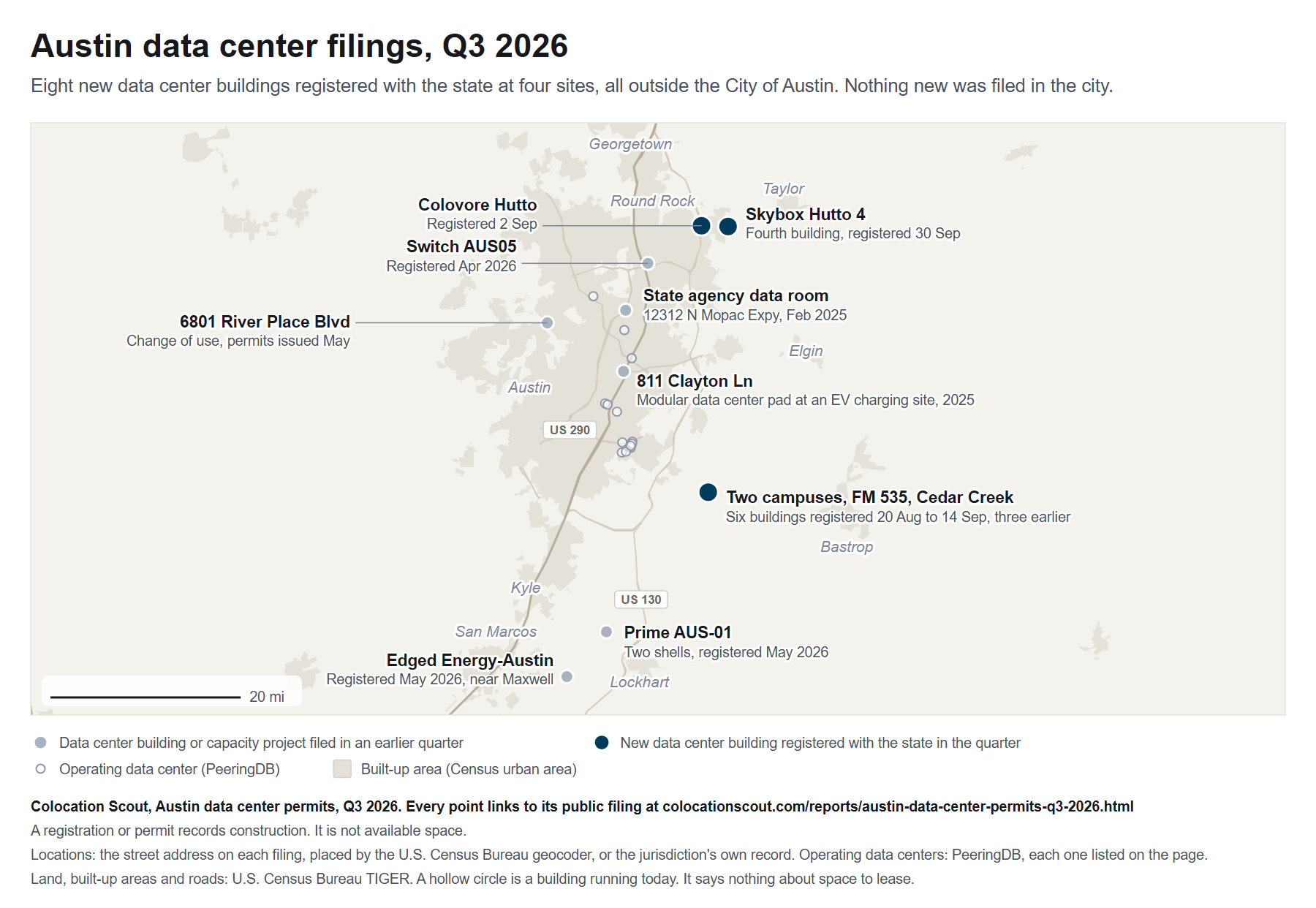

4
sites filed to add data center capacity around Austin: two FM 535 campuses at Cedar Creek, as county appraisal records quoted by Community Impact describe them, Colovore's building in Hutto and Skybox's fourth Hutto building. None is in the City of Austin.
8
new data center buildings registered with the State of Texas, six at Cedar Creek and two in Hutto. A registration is a state construction filing, not a local permit.
3
local bodies voted on data centers: Caldwell County paused new tax abatements on 13 August, Taylor's planning commission tabled a 664-acre campus on 18 August, and Austin's council voted to draft rules on 27 August.
All eight buildings registered this quarter are outside the City of Austin, six of them at Cedar Creek in Bastrop County, and on 21 September Governor Greg Abbott told the state's environmental agency to issue no permits sought by data center projects until the state's grid and water audits are done.
Operating facilities on the map (14)
The small hollow grey dots are data centers operating today, from the public PeeringDB facility list, each linked to its PeeringDB record. An operating building is context for the filings and is in no count on this page.
| Operator | Facility | City | Record |
|---|---|---|---|
| Alpheus Communications | Alpheus Austin (1905 E. 6th Street) | Austin | peeringdb.com/fac/2511 |
| Bestline Communications, L.P. | BESTNAP | Austin | peeringdb.com/fac/2853 |
| Cogent Communications, Inc. | Cogent Austin | Austin | peeringdb.com/fac/16445 |
| CyrusOne Inc. | CyrusOne Austin (Met 2) | Austin | peeringdb.com/fac/1483 |
| CyrusOne Inc. | CyrusOne Austin (Met 3) | Austin | peeringdb.com/fac/2354 |
| Data Foundry, Inc. | Data Foundry Austin 1 | Austin | peeringdb.com/fac/2340 |
| Data Foundry, Inc. | Data Foundry Texas 1 | Austin | peeringdb.com/fac/1720 |
| DataBank, Ltd. | DataBank Austin (AUS1) | Austin | peeringdb.com/fac/10925 |
| Digital Realty | Digital Realty AUS11 - Austin | Austin | peeringdb.com/fac/4870 |
| Element Critical, LLC | Element Critical Austin AUS1 | Austin | peeringdb.com/fac/3922 |
| LightEdge Solutions | LightEdge Austin 1 (AUS1) | Austin | peeringdb.com/fac/5970 |
| LightEdge Solutions | LightEdge Austin 2 (AUS2) | Austin | peeringdb.com/fac/5971 |
| Lumen Technologies Inc | Level(3) Austin (Kramer) | Austin | peeringdb.com/fac/1721 |
| Olive Grove Partners II, Ltd. | 1011 San Jacinto | Austin | peeringdb.com/fac/2974 |
What happened this quarter
Six buildings at Cedar Creek, none in the City of Austin
Four sites filed to add data center capacity this quarter, none inside Austin's city limits. Eight new data center buildings were registered with the state, six on FM 535 at Cedar Creek in Bastrop County. Burr Computer Environment registered four at 6402 and 6682, which county appraisal records put in one 951-acre campus, as Community Impact reported, and Uppingham Adams Holdings two on a second campus at 6543. The registrations name owners, not an operator, though Community Impact and DCD tie the land to EdgeConneX (news coverage). A registration is a state construction filing, not a local permit. Bastrop County's own permits are not in this record.
Colovore and a fourth Skybox building in Hutto
The other two buildings are in Hutto, east of Round Rock in Williamson County. Colovore Austin 1, LLC registered a 192,694 square foot data center at 2401 Innovation Boulevard on 2 September, and on 30 September Hutto Data Center Campus, LLC registered Skybox's fourth Hutto building at 3399 County Road 132, a core and shell of about 844,300 square feet for future data center use. Hutto's own permits are not in this record, and the outcomes of its September votes on a 140-acre rezoning and data center building standards are not posted.
Nothing new in the City of Austin
No City of Austin permit or plan review naming a data center was filed this quarter. The last, a February change of use making floors of the former 3M campus at 6801 River Place Boulevard a data center, had its plan review issued on 7 May and its building permits from 11 May. SB Energy's IPO registration puts its Cosmos Technology Campus, which Four Points News tied to this site (news coverage), at about 50 MW, a company figure.
Local votes and a state pause
Three local bodies voted on data centers this quarter: Caldwell County paused new tax abatements for large data centers on 13 August (minutes), Taylor's planning commission tabled a 664-acre campus on 18 August (files), and Austin's council voted 11-0 on 27 August (minutes) to draft rules, with the City Manager reporting before approving any project over 20 MW until then (resolution). Travis County Commissioner Brigid Shea told the Austin Free Press that lacking a say over development "puts counties in an impossible position" (news coverage). On 21 September Governor Greg Abbott ordered a halt to state environmental permits for data centers pending grid and water audits.
The quarter's filings
EDCAUS13, 14, 15 and 16, FM 535 campus
- Location
- 6682 FM 535 (EDCAUS13, 14) and 6402 FM 535 (EDCAUS15, 16), Cedar Creek, Bastrop County. One 951-acre campus in county appraisal records, reported (Community Impact)
- Owner of record
- Burr Computer Environment Inc
- Operator
- EdgeConneX, reported (Community Impact, DCD). The registrations name no operator.
- Size
- 729,537 square feet each (EDCAUS13, 14), 591,400 square feet each (EDCAUS15, 16)
- Work, as filed
- "New construction of a 729,537 SF 1-story data center with supporting office space and associated site improvements", the same wording at 591,400 SF for EDCAUS15 and 16
- Filing and status
- Four state construction registrations with the Texas Department of Licensing and Regulation, one per building, each "Project Registered". A registration is not a building permit.
- Registered
- 20 August 2026 (EDCAUS13, 14), 11 September 2026 (EDCAUS15), 14 September 2026 (EDCAUS16)
- Estimated cost, as filed
- $700 million each (EDCAUS13, 14), $600 million each (EDCAUS15, 16)
- Records
- TABS2026028410, TABS2026028423, TABS2027000881, TABS2027001020
EDCAUS31 and 32, 6543 FM 535
- Location
- 6543 FM 535, Cedar Creek, Bastrop County
- Owner of record
- Uppingham Adams Holdings, LLC
- Operator
- EdgeConneX, reported (Community Impact, DCD). The registrations name no operator.
- Size
- 576,777 square feet each
- Work, as filed
- "New construction of a 576,777 SF 1-story data center with supporting office space and associated site improvements"
- Filing and status
- Two state construction registrations with the Texas Department of Licensing and Regulation, one per building, each "Project Registered". A registration is not a building permit.
- Registered
- 21 August 2026 (EDCAUS31), 24 August 2026 (EDCAUS32)
- Estimated cost, as filed
- $700 million each
- Records
- TABS2026028550, TABS2026028609
Colovore Hutto
- Location
- 2401 Innovation Boulevard, Hutto, Williamson County
- Owner of record
- Colovore Austin 1, LLC
- Size
- 192,694 square feet
- Work, as filed
- "one story data center building 192,694 sf with admin area w/ screened equipment yard"
- Filing and status
- State construction registration with the Texas Department of Licensing and Regulation, "Project Registered". A registration is not a building permit.
- Registered
- 2 September 2026
- Estimated cost, as filed
- $280 million
- Record
- TABS2027000200
Skybox Hutto 4
- Location
- 3399 County Road 132, Building 4, Hutto, Williamson County
- Owner of record
- Hutto Data Center Campus, LLC
- Size
- About 844,300 square feet of data center with an office of about 20,000 square feet attached, as the scope states. The record's area field reads 846,300 square feet.
- Work, as filed
- "Site improvements & construction of a new Core & Shell building with a future use as a Data Center"
- Filing and status
- State construction registration with the Texas Department of Licensing and Regulation, "Project Registered". A registration is not a building permit.
- Registered
- 30 September 2026
- Estimated cost, as filed
- $550 million
- Record
- TABS2027002367
Completed 5 October 2026. These figures are frozen, and any later correction is listed under Sources and revisions. A filing is not space anyone can lease.
Sites filing to add data center capacity, by quarter
What to watch
- 8 October 2026: Taylor's council votes on a development agreement for Taylor Technology Campus, formerly Project Mustang, which the city says would move its annexation and development forward.
- 19 October 2026: the Texas Commission on Environmental Quality reports to the Governor on its data center permit pause, under the 21 September directive, which sets no end date. It does not reach the registrations and permits counted here, so the buildings stay on file, but it holds the agency's air and water permits (San Antonio Current), among them the air permits a campus needs for backup generators, so expect delays rather than cancellations.
- By 26 October 2026: Austin's City Manager owes council an update on data center rules, 60 days after the 27 August vote.
The records
Every project in the record, Q1 2025 to Q3 2026 (17)
| First filed | Permit first issued | Where | The work | Type | Declared value | Record |
|---|---|---|---|---|---|---|
| 18 February 2025 | Not a permit | 12312 N Mopac Expy, Austin | Offices made into a 700 square foot state agency data room | New data room | $479,000 | TABS2025012206 |
| 14 July 2025 | Not a permit | 8001 Wolf Ln, Cedar Creek | New data center, 578,000 square feet | New building | $440 million | TABS2025023484 |
| 30 September 2025 | Q1 2026 27 March 2026 | 811 Clayton Ln, Austin | Pad for a modular data center at an EV charging facility | Modular data center pad | Not separate ($1 million on every job there) | 2026-036762 BP, 2026-036762 EP |
| 9 February 2026 | Q2 2026 11 May 2026 | 6801 River Place Blvd, Austin | Change of use to data center, floors 3 and 4 | Change of use | $1.525 billion, repeated on each of three section permits | 2026-014961 PR, 2026-057401 BP, 2026-057402 BP, 2026-057403 BP, 2026-057404 BP |
| 15 April 2026 | Not a permit | 300 Dell Way, Round Rock | New data center, 72,600 square feet | New building | $20 million | TABS2026017678 |
| 4 May 2026 | Not a permit | 11255 Hwy 142, Maxwell | New data center in a warehouse building, 869,684 square feet | New building | $2.8 billion | TABS2026019322 |
| 5 May 2026 | Not a permit | 1395 Bob White Rd, Lockhart | Two 380,000 square foot shells for future data center use | New building | $400 million | TABS2026019473 |
| 26 May 2026 | Not a permit | 6682 FM 535, Cedar Creek | New data center, 729,537 square feet | New building | $700 million | TABS2026021187 |
| 26 May 2026 | Not a permit | 6682 FM 535, Cedar Creek | New data center, 729,537 square feet | New building | $700 million | TABS2026021191 |
| 20 August 2026 | Not a permit | 6682 FM 535, Cedar Creek | New data center, 729,537 square feet | New building | $700 million | TABS2026028410 |
| 20 August 2026 | Not a permit | 6682 FM 535, Cedar Creek | New data center, 729,537 square feet | New building | $700 million | TABS2026028423 |
| 21 August 2026 | Not a permit | 6543 FM 535, Cedar Creek | New data center, 576,777 square feet | New building | $700 million | TABS2026028550 |
| 24 August 2026 | Not a permit | 6543 FM 535, Cedar Creek | New data center, 576,777 square feet | New building | $700 million | TABS2026028609 |
| 2 September 2026 | Not a permit | 2401 Innovation Blvd, Hutto | New data center, 192,694 square feet | New building | $280 million | TABS2027000200 |
| 11 September 2026 | Not a permit | 6402 FM 535, Cedar Creek | New data center, 591,400 square feet | New building | $600 million | TABS2027000881 |
| 14 September 2026 | Not a permit | 6402 FM 535, Cedar Creek | New data center, 591,400 square feet | New building | $600 million | TABS2027001020 |
| 30 September 2026 | Not a permit | 3399 County Road 132, Building 4, Hutto | Core and shell for future data center use, about 844,300 square feet | New building | $550 million | TABS2027002367 |
TABS numbers are state registrations, never issued, and the others are City of Austin permits and plan reviews. Values are the filers' own estimates, never added together.
State air permits for data centers (none since January 2025)
A pending registration at Earl Callahan Road, Cedar Creek, is under Reported.
Government actions, 2026 (11)
- Round Rock council: Skybox Old Settlers rezoned to PUD No. 159, 7-0, minutes still in draft (record).
- Caldwell County: Tax abatement for EDC Austin, LLC, about 330 acres, 4-1, development agreement postponed. News coverage in DCD ties it to Edged's Maxwell project (minutes, DCD).
- Taylor council: Ordinance 2026-04, an employment center plan for KDC Project Comal on about 220 acres, unanimous (files).
- Caldwell County: Development agreement with Lockhart Property, LLC, for 205.756 acres, 4-1, its backup naming Prime Data Centers (minutes).
- San Marcos council: Data centers prohibited in every zoning district, 4-3 on the amendment and 7-0 on the ordinance (minutes).
- Bastrop County: A resolution seeking more county power over large industrial projects, tabled as reported, its text not naming data centers (agenda, Community Impact).
- Taylor planning commission: Two replats of Blueprint's 52.42-acre lot at 1601 Martin Luther King Jr Blvd disapproved, 8-0 each, on staff recommendation (minutes).
- Caldwell County: Resolution 34-2026, unanimous: no new tax abatements for large data centers or battery storage until the next legislative session ends. Permits are unaffected (minutes).
- Taylor planning commission: Taylor Technology Campus, formerly Project Mustang, tabled 90 days, 6-2. Its zoning and annexation application was withdrawn on 3 September (files, city page).
- Austin council: Data center rules to be drafted, 11-0. Until then the City Manager must report before approving any project over 20 MW or 85 million gallons a year (resolution, minutes).
- Governor of Texas: TCEQ told to halt permits sought by data centers until state grid and water audits are done, update due 19 October (release).
Reported (11)
Press reports, planning cases and records outside the counting rule. None of these is in the counts above.
- Hall work at existing data centers, Round Rock, Hutto and Austin. Sabey's halls, Skybox's Hutto Buildings 2 and 3, and 85,000 square feet with two Austin Energy transformers at 7000 Burleson Road (Sabey B35, Building 2, Building 3, Burleson Road). None states a power figure.
- Pacifico Energy and Black Chamber Partners, Earl Callahan Road, Cedar Creek. About 2,800 acres with a gas plant, abatement requests withdrawn in August, state stormwater coverage since July and an air registration pending (Elgin Courier, KVUE, state registry). No state record names a data center.
- Caldwell Valley Technology Park, Uhland, Caldwell County. Tract's 3,000-acre park, with 360 MW planned for 2028 and a 500-acre PowerHouse campus inside it (Tract, DCD, Bisnow). No state registration. The figures are the companies'.
- CloudBurst, near San Marcos. Reported to straddle Hays and Guadalupe counties, with Guadalupe County agreements approved in April 2026 and a Hays County site permit pending (The Real Deal, Guadalupe minutes, Hays permit). No state registration.
- Taylor Technology Campus, formerly Project Mustang, Taylor. 664 acres with data centers and on-site power, and a development agreement before the council on 8 October (City of Taylor, council agenda). A planning case with no filing date on record.
- KDC Project Comal, Taylor. A data center on about 220 acres, its plan approved in March 2026 (City of Taylor, council minutes). A planning case with no filing date on record.
- Blueprint Data Centers, Taylor. A 135,000 square foot data center, its plan approved in July 2025 and replats disapproved on 11 August, while the Attorney General investigates the site's parkland deed (City of Taylor, replat minutes, Attorney General). A planning case with no filing date on record.
- Skybox Old Settlers, Round Rock. Rezoned in February 2026 under a plan asking to allow a data center, with no permit in Round Rock's reports through August (Round Rock council). A planning case with no filing date on record.
- Prominent Property Group, Jarrell. A 150.92-acre tract annexed and zoned light industrial in October 2025 and given a preliminary plat in February 2026, which the press ties to a 200 MW data center (October minutes, February minutes, DCD, KXAN). The city's records do not name a data center.
- Project Mockingbird and two more, Mustang Ridge. Cielo Digital's proposed data center in the city's Caldwell County part, discussed in closed session in September 2025, and two more projects with data centers at August 2026 workshops (minutes, 4 August, 17 August). No action recorded and no state registration.
- Tesla Cortex 2.0, Giga Texas, Travis County. An AI training cluster Tesla calls online, with county fire permits for data halls 6 to 9, an extension filed in the quarter and a 46,400 square foot building registered with the state on 25 August (Tesla update, data halls, extension, registration). No Q3 record states a power figure or what the new building houses.
Coverage and method
Boundary. The Austin-Round Rock-San Marcos metropolitan area as the Bureau of Labor Statistics defines it: Bastrop, Caldwell, Hays, Travis and Williamson counties.
| Authority | Records | Status, Q1 2025 to Q3 2026 |
|---|---|---|
| City of Austin | Permits and plan reviews naming a data center, filings at data center addresses, zoning and site plans | Counted. A filing that never names a data center is missed |
| Texas Department of Licensing and Regulation | Construction registrations, five counties, by project, facility and owner name | Counted, though a registration without data center wording or a known owner is missed |
| City of Round Rock | Monthly reports of permit applications | Through August 2026. Its data center filings are hall work at Sabey's campus, with no power figure |
| Other cities, among them Hutto, Taylor, Georgetown, Jarrell and Mustang Ridge | Building permits | Not collected, so a new building there shows only through its state registration |
| The five counties | Unincorporated permits and fire marshal registers | Not counted, except as cited under Reported. Bastrop's and Caldwell's permit searches need an account |
| Councils, commissions and commissioners courts | Agendas and minutes naming data centers | Reviewed, with draft or unposted minutes flagged |
| Texas Commission on Environmental Quality | Air permits, by data center facility and owner name | Reviewed. None names a data center |
What is counted. Only work that adds data center buildings or capacity: new buildings, a change of use to a data center and, at a data center already on file, work stating added power with a figure. A new building or site naming a data center counts without a stated capacity, and power work not naming one counts only above 1 MW. Replacements, repairs, renovations, offices, renewals and amendments do not count. Planning cases in Taylor, Round Rock, Hutto and Jarrell are described but not counted, since their council records give no filing date.
Counting. A site is one address or one campus and counts once in a quarter however many jobs it files. Burr's four FM 535 buildings this quarter are one site, at two addresses that county appraisal records put in one campus, as Community Impact reported, and Uppingham's two at 6543 are another. A project is dated by its first application or registration. No counted record states megawatts.
Sources and revisions
Every figure links to the public record it came from: a City of Austin permit or plan review, a state registration, or the minutes of the body that acted. News coverage is named as news and never counted.
Colocation Scout is run by a colocation sourcing consultant. The permit data is public and every row links to its filing. How we publish these reports.
Revisions: Correction: on 5 October 2026 Q2 2026 changed from 3 to 4 sites and 4 to 5 new buildings when Edged's Maxwell registration, filed under another owner, was found. Edition status: final.
Cite this report as: Colocation Scout, "Austin data center permits, Q3 2026," colocationscout.com/reports/austin-data-center-permits-q3-2026.html
