Q3 2026 Market Report / Columbus

Columbus data center filings, Q3 2026: 2,530 MW of gas plants for data centers await the state while towns vote to limit them.

Q3 2026 filings to build data center space and power in the ten counties around Columbus, and the votes around them, each linked to its public record. The 2,530 MW is the most the three pending plants could produce, before the state rules on them.

1

site filed to add data center capacity: a gas plant of up to about 430 MW for EdgeConneX's New Albany North site, applied for with the state on 24 July.

2,530

megawatts, at most, of gas plants for data centers awaiting a state decision at the quarter's end: two for EdgeConneX, at New Albany and Ashville, and the Fairfield Energy Center at Millersport.

12

local bodies voted on data centers, seven to limit them: two moratoria, a district ban in Dublin, and four bans or public-vote rules sent to voters.

The quarter's one new filing was a gas plant for EdgeConneX in New Albany, one of three data center plants waiting on the state, while Pataskala turned Aligned Data Centers down and seven of twelve local votes set limits.

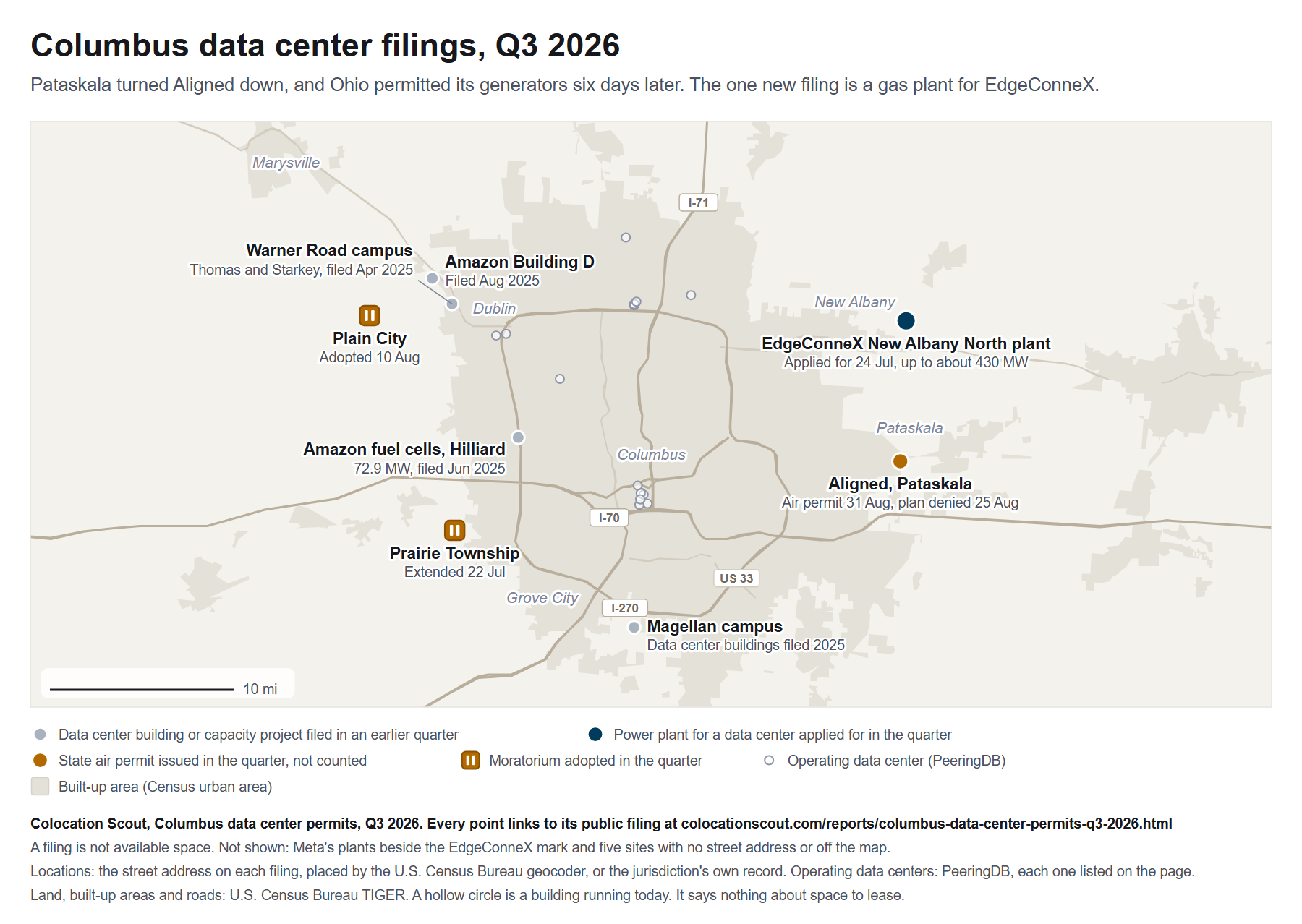

Map of the Columbus area, Ohio. The quarter's one counted filing, a gas plant of up to about 430 MW for EdgeConneX's New Albany North site on Clover Valley Road, is the dark mark east of New Albany. An orange mark at Pataskala is the state air permit issued in August for Aligned's 129 generators, on a site the city council turned down. Pause markers show Plain City's new moratorium and Prairie Township's extended one. Earlier filings are shown lighter: the Magellan campus on Rathmell Road south of Columbus, Amazon's fuel cells in Hilliard and two Jerome Township campuses on Industrial Parkway. Operating data centers from PeeringDB are small hollow dots.
Every point on the map is a filing or permit linked on this page. Download the map (PNG). Reporters may republish the map with credit to Colocation Scout and a link to this page.
Operating facilities on the map (21)

The small hollow grey dots are data centers operating today, from the public PeeringDB facility list, each linked to its PeeringDB record. An operating building is context for the filings and is in no count on this page.

OperatorFacilityCityRecord
Bresco BroadbandBresco Broadband Data CenterColumbuspeeringdb.com/fac/3890
Bresco BroadbandContinental PlazaColumbuspeeringdb.com/fac/3891
CentersquareCentersquare Columbus (CMH1)Lewis Centerpeeringdb.com/fac/2594
CENTRA Digital InterconnectCENTRA CMH01 - Columbus Ohio (180 E Broad)Columbuspeeringdb.com/fac/12210
City of WestervilleWēConnect WestervilleWestervillepeeringdb.com/fac/7142
CitynetCitynet ColumbusColumbuspeeringdb.com/fac/267
Cogent Communications, Inc.Cogent ColumbusColumbuspeeringdb.com/fac/10479
Cogent Communications, Inc.Cogent Columbus 2Columbuspeeringdb.com/fac/16457
Cologix, Inc.Cologix COL1Columbuspeeringdb.com/fac/2377
Cologix, Inc.Cologix COL2Columbuspeeringdb.com/fac/2378
Cologix, Inc.Cologix COL3Columbuspeeringdb.com/fac/3313
Cologix, Inc.Cologix COL4Columbuspeeringdb.com/fac/14565
Crown Castle Inc.Crown Castle Columbus (101 E Town)Columbuspeeringdb.com/fac/3493
DartPoints, LLCDartPoints Dublin, OH - CMH1Dublinpeeringdb.com/fac/9390
DataCenter.BZ, LLCDatacenter.BZColumbuspeeringdb.com/fac/1420
DataCenter.BZ, LLCDataCenter.BZ - Worthington-ColumbusWorthingtonpeeringdb.com/fac/1328
ExpedientExpedient Columbus - DublinDublinpeeringdb.com/fac/8471
ExpedientExpedient Columbus - Upper ArlingtonUpper Arlingtonpeeringdb.com/fac/8472
Hexion Building180 E Broad St.Columbuspeeringdb.com/fac/525
RacksquaredRacksquared Data CentersColumbuspeeringdb.com/fac/7609
WideOpenWest FinanceWOW! Business (Columbus Datacenter)Columbuspeeringdb.com/fac/1828

What happened this quarter

The one new filing is a power plant

One site filed to add data center capacity this quarter, and the filing was for power rather than a building. On 24 July PowerConneX, an EdgeConneX affiliate, applied to the Ohio Power Siting Board for a gas plant on EdgeConneX's New Albany North site on Clover Valley Road, which EdgeConneX describes as up to about 430 MW and the primary source of electricity for the data centers there. The board found the application complete on 4 September and set hearings for 22 October and 4 November. The power would come from on-site gas engines: Ohio EPA's draft air permit of 6 August, for "a data center and power generation facility" at the site, covers 30 of them. No new data center building was filed in the covered records, but those records leave out building permits in Licking and Union counties, where most of the market's campuses sit, because they cannot be searched online.

Pataskala said no to Aligned, and Ohio permitted the generators Aligned had already applied for

Pataskala's council voted 7-0 on 25 August to disapprove Aligned Data Centers' plan for three data center buildings on 89.41 acres at Broad and Mink streets. The generators are part of the same project, not a fallback from it. Aligned applied to Ohio EPA on 29 July, before the vote, for 129 emergency generators at 6770 Mink Street, and the state issued the permit six days after the vote. An air permit settles air quality, not local land use, so it does not revive the plan the council turned down. Pataskala's voters decide on 3 November whether to write a ban on data centers drawing more than 25 MW into the city charter. Aligned's case is not in the count because its records do not show when it was filed.

Twelve local bodies voted, and seven of them set limits on data centers

Set limits

7

Dublin, New Albany, Sunbury, Prairie Township, Pataskala, Plain City, Grove City

Both ways

1

Johnstown: a ban sent to a January vote, and a wider tax abatement area

The other way

1

Regional planners: plats extended for three Jerome Township campuses

Neither

3

Columbus peak rates, Marysville conditional use, Heath petitions rejected

Each vote is listed with its record in the timeline below.

Columbus and the state turn to the cost of power

Columbus's council voted 9-0 on 28 September to have its water and power department propose peak rates for large users, data centers named among them, by 26 October. On 5 August the Public Utilities Commission of Ohio ruled that a data center returning to AEP Ohio's standard service must give 180 days' notice and bear the cost of buying its power. Two gas plants filed earlier in the year, PowerConneX's plant of up to 800 MW at Ashville for EdgeConneX and the 1,300 MW Fairfield Energy Center at Millersport, went through hearings with no decision by the quarter's end. With New Albany North, that is up to 2,530 MW of gas plants for data centers waiting on the board.

The quarter's filings

PowerConneX New Albany 3, for EdgeConneX New Albany North

Location
3356 Clover Valley Road NW, New Albany, Licking County, on about 30 acres
Applicant of record
PowerConneX, Inc., an EdgeConneX affiliate
Power, as stated
Up to about 430 MW, as EdgeConneX states it (EdgeConneX)
Work, as described
Gas-fired equipment "that will serve as a primary source of electricity to data centers on the same site"
Filing and status
Application for a certificate from the Ohio Power Siting Board, found complete on 4 September 2026. Hearings on 22 October and 4 November. No decision.
Filed
24 July 2026
Record
26-0361-EL-BGN
Related state record
Ohio EPA draft air permit P0140005 for EdgeConneX New Albany North, 6 August 2026 (draft permit)
Final edition

Completed 8 October 2026. These figures are frozen, and any later correction is listed under Sources and revisions. Building permits in Licking and Union counties and Hilliard are not in the record, and a filing is not space anyone can lease.

Sites filing to add data center capacity, by quarter

2
Q1 25
5
Q2 25
2
Q3 25
2
Q4 25
1
Q1 26
2
Q2 26
1
Q3 26
A site counts once in a quarter however many permits it files. The count draws on City of Columbus permits and site plans, Jerome Township zoning certificates, planning cases that give a filing date, and the state's power plant applications, searched the same way for every quarter. Building permits in Licking and Union counties and Hilliard are not in it.

What to watch

  • By 26 October 2026: Columbus Water and Power owes council its proposed peak rates for large users, under Ordinance 2560-2026.
  • 3 November 2026: voters in Pataskala and Sunbury decide charter bans on data centers over 25 MW, and Grove City voters decide whether large projects need a public vote (minutes).
  • 4 November 2026: the siting board's evidentiary hearing on the New Albany North plant opens, after a local hearing on 22 October (docket).

The records

Every project in the record, Q1 2025 to Q3 2026 (18)
First filedPermit first issuedWhereThe workTypeDeclared valueRecord
7 March 2025Board approval, Q2 2025
9 June 2025
14250 Morse Rd, New AlbanyGas plant for the data center of Sidecat, a Meta affiliatePower plant, 200 MWNot stated25-0185-EL-BLN
26 March 2025None on record225 Rathmell Rd, ColumbusSite plan to add a data centerSite plan for a new data centerNot stated25345-00215
17 April 2025Q4 2025
22 December 2025
8510 Warner Rd, Jerome TownshipFive data center buildings, 965,250 square feetFive new buildingsNot statedZC 10827
17 April 2025Q4 2025
22 December 2025
7321 Industrial Pkwy, Jerome TownshipSix data center buildings, 1,380,375 square feetSix new buildingsNot statedZC 10826
23 April 2025Board approval, Q3 2025
24 July 2025
9850 Innovation Campus Way, New AlbanyGas plant for EdgeConneX's data centerPower plant, 120 MWNot stated25-0090-EL-BLN
25 April 2025Board approval, Q3 2025
18 September 2025
13385 Green Chapel Rd NW, New AlbanyGas plant for Sidecat's data centerPower plant, 200 MWNot stated25-0188-EL-BGN
8 May 2025Q3 2025
2 July 2025
225 Rathmell Rd, ColumbusShell of a 288,000 square foot data center buildingNew building$20 million shell, $200 million second phaseNEWC2516788, ALTC2530787
12 June 2025Q3 2025
11 September 2025
225 Rathmell Rd, ColumbusTwo buildings to support server operationsTwo new buildings$100 million each25345-00443, NEWC2526040, NEWC2526056
24 June 2025Board approval, Q3 2025
22 September 2025
4186 Scioto Darby Creek Rd, HilliardAEP Ohio fuel cells for Amazon's data center campusFuel cells, 72.9 MWNot stated25-0649-EL-BLN
25 June 2025Board approval, Q4 2025
20 November 2025
9850 Innovation Campus Way, New AlbanyGas plant for EdgeConneX's data centerPower plant, 216 MWNot stated25-0302-EL-BGN
21 August 2025Q3 2025
19 September 2025
8575 Industrial Pkwy, Jerome TownshipData building of 192,746 square feetNew buildingNot statedZC 11099
26 August 2025None on record225 Rathmell Rd, ColumbusSite plan to add a data centerSite plan for a new data centerNot stated25345-00641
17 November 2025Planning case, approved 15 December 2025Souder Rd, north of New Albany Rd E, New AlbanyData center of 330,000 square feetFinal development planNot statedFDP-96-2025
25 November 2025Q4 2025
23 December 2025
Industrial Pkwy, west campus, Jerome TownshipFirst building of 214,300 square feetNew buildingNot statedZC 11318, ZC 11358
27 March 2026Board approval, Q2 2026
26 June 2026
3439 Clover Valley Rd, New AlbanyGas plant for Sidecat's data centerPower plant, 250 MWNot stated26-0169-EL-BLN
1 April 2026Planning case, no decision on recordRickenbacker Exchange extension, Commercial PointMajor site plan for a data centerMajor site planNot statedK-Nova II major site plan
12 May 2026No board decision yetState Route 752, AshvilleGas plant for EdgeConneX's data centerPower plant, up to 800 MWNot stated26-0196-EL-BGN
24 July 2026No board decision yet3356 Clover Valley Rd NW, New AlbanyGas plant for EdgeConneX's New Albany North data centersPower plant, up to about 430 MWNot stated26-0361-EL-BGN

Two series, never added together: City of Columbus permits and site plans, Jerome Township zoning certificates and dated planning cases, and power plant applications to the Ohio Power Siting Board, dated by the application. A declared value is the filer's own estimate and is never added to another.

State air permits for new data centers and their power plants (11)
DateFacility, as the state names itWhereWhat happenedPermit
22 September 2026STY power plant, Will-Power OHNew AlbanyDraft permitP0139969
31 August 2026Aligned Data Centers CMH01, 129 emergency generatorsPataskalaPermit issuedP0140511
6 August 2026EdgeConneX New Albany North, 30 gas enginesNew AlbanyDraft permitP0140005
2 June 2026CMH170 Campus, 58 emergency generatorsMarysvillePermit issuedP0140211
10 February 2026CMH098 Campus, 388 emergency generatorsJohnstownPermit issuedP0139005
10 February 2026Montauk Innovations, 47 emergency generatorsNew AlbanyPermit issuedP0139081
16 December 2025Vantage OH2, 617 emergency generatorsMillersportPermit issuedP0138518
10 December 2025Cologix COL5, 15 generatorsOrange TownshipPermit issuedP0138685
18 November 2025CyrusOne New Albany, 145 emergency generatorsNew AlbanyPermit issuedP0138459
8 October 2025AEP Ohio fuel cells, 72.91 MWHilliardPermit issuedP0138549
29 July 2025CMH116 Campus, 303 emergency generatorsJohnstownPermit issuedP0137625

Ohio EPA permits for the generators and power plants of new data centers. 3 fall in Q3 2026. They are listed, not counted, because the records show when a permit was drafted or issued, not when it was applied for. A generator rating is backup plant, not capacity a customer can use.

Government actions, 2026 (17)
  1. Dublin council: Data centers dropped as a use in the West Innovation District, 6-1 (action summary).
  2. New Albany council: Data centers barred as a primary use on 22.6 rezoned acres, 7-0 (minutes).
  3. Marysville planning commission: Data centers made a conditional use in Marysville East, 7-0, a recommendation (minutes).
  4. Sunbury council: Charter ban on data centers over 25 MW sent to the ballot (ordinance).
  5. Prairie Township trustees: Moratorium extended to 15 April 2027, 3-0 (minutes).
  6. Pataskala council: Charter ban on data centers over 25 MW sent to the ballot, 4-0 (ordinance).
  7. Public Utilities Commission of Ohio: Data centers returning to AEP Ohio's standard service give 180 days' notice and bear the power cost (release, docket).
  8. Supreme Court of Ohio: Ashville's referendum on its EdgeConneX resolution ordered to the board of elections (opinion).
  9. Plain City council: One-year moratorium on data center applications (minutes).
  10. Pataskala council: Aligned Data Centers' plan disapproved, 7-0 (minutes).
  11. Johnstown council: Tax abatement area covering data center buildings widened by about 170 acres (ordinance).
  12. Grove City council: Public-vote amendment for projects over 20 MW sent to the ballot, 7-0, with a resolution opposing it (minutes).
  13. Johnstown council: Charter ban on data centers set for a 5 January 2027 election (ordinance).
  14. Regional planning commission: Plats extended for the Thomas and Starkey complexes, Jerome Township (minutes).
  15. Grove City council: Innovation district created without data processing among its uses, 7-0 (minutes).
  16. Heath council: Charter ban petitions rejected for too few signatures (minutes).
  17. Columbus council: Peak rates for large users, data centers named, due by 26 October, 9-0 (ordinance, minutes).
Reported (7)

Press reports, planning cases with no filing date and records outside the counting rule. None of these is in the counts above.

  • Harvey Farms, Etna Township. A 397.3-acre rezoning for "a 397.3-acre data center facility", tabled twice by county planners (staff report). Its filing date is not in the records.
  • Aligned Data Centers, Pataskala. Three data center buildings on 89.41 acres, disapproved on 25 August (staff report). Filed in 2025 on a date not shown.
  • Project Cosmos, Marysville. A data center exterior plan approved on 15 January 2025 (minutes). No filing date on record.
  • Fairfield Energy Center, Millersport. A 1,300 MW gas plant for "a data center adjacent to the project site" (docket). No record names the data center.
  • Neo Power, Jersey Township. A 500 MW gas plant applied for in June (docket). No record names a data center.
  • Hartman Farms line, Hamilton Township, near Lockbourne. Power lines for a customer of up to 688 MW on Magellan LLC land (construction notice). The record does not say data center.
  • Stream Data Centers, Grove City and Jackson Township. About 300 acres reported in the press. No local record names it.
Coverage and method

Boundary. The ten counties of the Columbus metropolitan area as the federal government defines it: Delaware, Fairfield, Franklin, Hocking, Licking, Madison, Morrow, Perry, Pickaway and Union.

AuthorityRecordsStatus, Q1 2025 to Q3 2026
City of ColumbusBuilding permits and site plans naming a data centerCounted. A filing that never names a data center is missed
Jerome TownshipZoning certificates for new buildingsCounted
New Albany, Pataskala, Commercial Point and other cities and villagesPlanning and council recordsCounted where a case names a data center and gives a filing date
Licking, Union and Hilliard building permitsBuilding permitsNot in the count. They are not searchable online
Licking, Franklin and Union county planning bodiesPlanning commission and commissioner recordsRead for 2026, partly for 2025
Ohio Power Siting BoardPower plant applications naming the data center servedCounted, dated by the application
Ohio EPAAir permits for data center generators and plantsListed, not counted. The records show permit dates, not filing dates
Madison, Morrow, Hocking and Perry countiesNoneNot collected

What is counted. Only work that adds data center buildings or capacity: new buildings and planning cases naming a data center, and power plants over 1 MW whose records name the data center they serve. Replacements, repairs, renewals and amendments do not count, nor do planning cases whose records give no filing date.

Counting. A site is one address or one campus and counts once in a quarter however many filings it makes. Meta's three power plants for its Sidecat campus are one site, and so are the Thomas and Starkey complexes in Jerome Township, which share an owner and a boundary. A power plant case is dated by its application, not the notice that opens its docket.

Sources and revisions

Every figure links to the public record it came from: a permit, a planning case, a state docket or the minutes of the body that acted. Company statements are named as such and never counted on their own.

Colocation Scout is run by a wholesale and colocation consultant. The permit data is public and every row links to its filing. How we publish these reports.

Revisions: none yet. Edition status: final.

Cite this report as: Colocation Scout, "Columbus data center permits, Q3 2026," colocationscout.com/reports/columbus-data-center-permits-q3-2026.html

Media inquiries

Cody Swift
Data Center Advisor at Colocation Scout
Powered by Bridgepointe Technologies
844-506-2299

Research at Colocation Scout

Colocation Scout tracks data center construction across U.S. markets from public records: building permits, planning cases and state air permits. Every figure in a report links to the filing it came from, so any reader can check it. How we publish these reports.

About Bridgepointe Technologies

Bridgepointe Technologies has been a technology advisory firm since 2002. It helps companies choose data center, connectivity and cloud providers, and partners with more than 380 of them. It has completed more than 1,200 data center and colocation projects as of 2026.

Market intelligence

Ask what the record means for your requirement.

The filings show where data center construction around Columbus is on file. A scout finds out which of it is reachable at your size, on your date, at a price worth signing.
