Q3 2026 Market Report / Greater Los Angeles

Greater Los Angeles data center permits, Q3 2026: no new capacity filed, and Vernon's utility stopped taking data center power requests.

What was filed to build data center space around Los Angeles in the third quarter of 2026, and the limits that spread with it. Every figure links to its public record.

Covers Los Angeles city permits that name a data center, Vernon's July and August 2026 permit reports, one Redondo Beach data center, and council and county records across the five counties. Full list under Coverage and method.

0

sites filed to add data center capacity. Cooling units in Redondo Beach and power panels in a Los Angeles data hall state no added power.

0

new data center buildings filed in the quarter. The $156 million building Vernon permitted on July 13 was applied for in September 2025.

5

local governments adopted new limits on their own records: a 45-day moratorium in Commerce, whose extension has no recorded outcome, a moratorium in Palm Springs, bans in Irwindale and Coachella, and the county planning director's bar on large-scale data centers in unincorporated areas.

The one new data center building in these records got its permit in Vernon, a $156 million project filed in September 2025, while five local governments adopted new limits and Vernon's utility says it is not taking new data center power requests.

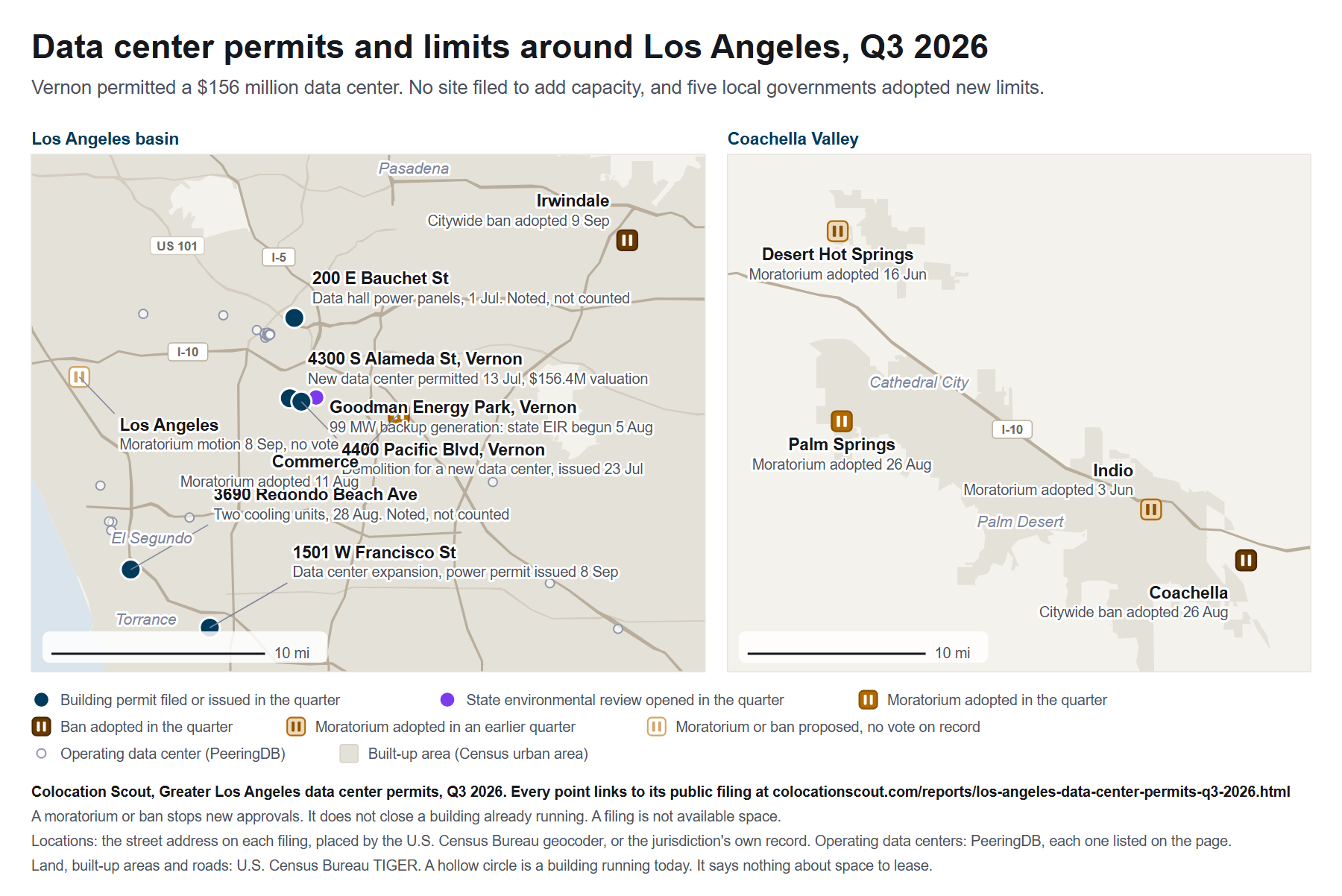

Two maps. Left, the Los Angeles basin: in Vernon, a new data center at 4300 South Alameda Street was permitted on July 13, 2026, with a $156,354,270 valuation, a demolition permit for a new data center development was issued at 4400 Pacific Boulevard on July 23, and the state began an environmental review of 99 MW of backup generation for the Goodman Energy Park data centers on August 5. In Los Angeles, an express permit for data hall power panels at 200 East Bauchet Street was issued on July 1 and a data center power permit at 1501 West Francisco Street on September 8. In Redondo Beach, two cooling units were filed for a data center at 3690 Redondo Beach Avenue. Pause markers show Commerce's 45-day moratorium of August 11, Irwindale's citywide ban of September 9 and the moratorium motion pending in Los Angeles. Los Angeles County's bar on large-scale data centers in unincorporated areas, described on the page, is not drawn. Right, the Coachella Valley: Palm Springs adopted a moratorium and Coachella a citywide ban on August 26, and Desert Hot Springs and Indio adopted moratoria in June. Operating data centers from PeeringDB are small hollow dots.
Every point on the map is a filing linked on this page. Download the map (PNG). Reporters may republish the map with credit to Colocation Scout and a link to this page.
Operating facilities on the map (42)

The small hollow grey dots are data centers listed in the public PeeringDB facility list, each linked to its record. Listings marked closed are left off. A listed building is in no count on this page.

OperatorFacilityCityRecord
Aecero Inc.Aecero - Orange County (SNA1)Anaheimpeeringdb.com/fac/3777
CentersquareCentersquare Los Angeles (LAX4)Hawthornepeeringdb.com/fac/6669
Cogent Communications, Inc.Cogent La MiradaLa Miradapeeringdb.com/fac/13227
Colocation America CorporationLADC1 - 624 S Grand AveLos Angelespeeringdb.com/fac/3421
Colocation America CorporationLADC2 - 707 Wilshire BlvdLos Angelespeeringdb.com/fac/3422
Colocation America CorporationLADC3 - 600 W 7th StLos Angelespeeringdb.com/fac/3423
Colocation America CorporationLADC4 - 530 W 6th StLos Angelespeeringdb.com/fac/3424
Colocation America CorporationLADC5 - 650 S Grand AveLos Angelespeeringdb.com/fac/3425
ColoCrossingColoCrossing LA1Los Angelespeeringdb.com/fac/6426
CoreSiteCoreSite - Los Angeles (LA1) One WilshireLos Angelespeeringdb.com/fac/19
CoreSiteCoreSite - Los Angeles (LA2)Los Angelespeeringdb.com/fac/363
CoreSiteCoreSite - Los Angeles (LA3)Los Angelespeeringdb.com/fac/9664
Crown Castle Inc.Crown Castle Los Angeles (624 S Grand)Los Angelespeeringdb.com/fac/5775
DataBank, Ltd.DataBank Los Angeles (LAX1)Los Angelespeeringdb.com/fac/10932
Digital RealtyDigital Realty LAX (2260 E El Segundo)El Segundopeeringdb.com/fac/2547
Digital RealtyDigital Realty LAX (600 W 7th)Los Angelespeeringdb.com/fac/403
Equinix, Inc.Equinix LA1 - Los AngelesLos Angelespeeringdb.com/fac/8
Equinix, Inc.Equinix LA2 - Los AngelesLos Angelespeeringdb.com/fac/102
Equinix, Inc.Equinix LA3/LA4 - Los Angeles, El SegundoEl Segundopeeringdb.com/fac/333
Equinix, Inc.Equinix LA7 - Los AngelesLos Angelespeeringdb.com/fac/9406
Fireline Network Solutions, IncFireline Data CenterLos Angelespeeringdb.com/fac/1227
Fireline Network Solutions, Inc dba: Fireline BroadbandFireline BroadbandSanta Fe Springspeeringdb.com/fac/4514
JMA WiredJMA NAC Los AngelesLos Angelespeeringdb.com/fac/22
Lumen Technologies IncLevel(3) Los AngelesLos Angelespeeringdb.com/fac/1096
Morlin ManagementTelecom Center LALos Angelespeeringdb.com/fac/642
MultaCom IncMultaCom MainLos Angelespeeringdb.com/fac/2781
MultaCom IncMultacom One WilshireLos Angelespeeringdb.com/fac/2782
MultaCom IncMultacom Telecom CenterLos Angelespeeringdb.com/fac/2783
Psychz NetworksPsychz Networks LAX1Los Angelespeeringdb.com/fac/2185
QuadraNet Enterprises LLCQuadraNet DTLALos Angelespeeringdb.com/fac/981
QuadraNet Enterprises LLCQuadraNet LAXLos Angelespeeringdb.com/fac/3825
Rising Realty PartnersThe Garland Center / West 7 CenterLos Angelespeeringdb.com/fac/7985
ServerfarmServerfarm LAX1 Los AngelesEl Segundopeeringdb.com/fac/4952
SUBRIGO CORPORATIONSubrigo LAX11Los Angelespeeringdb.com/fac/5600
Telehouse - Global Data CentersTelehouse - Los AngelesLos Angelespeeringdb.com/fac/317
Thomas Properties Group800 south hopeLos Angelespeeringdb.com/fac/966
Turnkey Internet Inc.TurnKey Internet - CALos Angelespeeringdb.com/fac/7263
UnitedLayer LLCUnitedLayer Los AngelesLos Angelespeeringdb.com/fac/3012
Verizon Communications, Inc.XO 600 West 7thLos Angelespeeringdb.com/fac/1004
Verizon Communications, Inc.XO 818 West 7thLos Angelespeeringdb.com/fac/1003
VPLSEvocative LAX14Los Angelespeeringdb.com/fac/8863
XfernetXfernet LAX01Los Angelespeeringdb.com/fac/7297

What happened this quarter

No site filed to add capacity

No site filed to add data center capacity in the records this report covers. In Redondo Beach a record dated August 28 adds two computer room air conditioning units to an existing data center on Redondo Beach Avenue. In Los Angeles an express electrical permit for 24 power panels in a data hall at 200 East Bauchet Street was issued on July 1. The city publishes no separate filing date for express permits, so the issue date is treated as the filing date. Neither states added power. A Los Angeles project filed in April got its permit for more IT power at 1501 West Francisco Street on September 8. It states no added power either.

Vernon permitted the quarter's one new building

On July 13 Vernon issued the building permit for a new data center at 4300 South Alameda Street, recording a valuation of $156,354,270 (July permit report, page 96). It was applied for in September 2025. No new data center building was filed in the quarter. Trade permits followed in July and a substation-site grading permit in August (August report). The permits name no operator. A county flood control permit on the parcel is labelled CoreSite LA5. On July 23 the city also issued a demolition permit at 4400 Pacific Boulevard for a new data center development. No building permit is on record. Digital Realty bought that site in 2025, Bisnow reported (news).

Five governments adopted new limits

Commerce adopted a 45-day moratorium on August 11. It ran to September 25, and the city records no outcome of the September 22 extension hearing. On August 26 Palm Springs adopted a moratorium and Coachella banned data centers citywide, both 5-0. Irwindale adopted a citywide ban on September 9. On September 17 Los Angeles County's planning director barred large-scale data centers in unincorporated areas until the zoning code is amended, as a October 6 county motion records. In all, five local governments adopted new limits on data centers on their own records. A Los Angeles council motion on a moratorium above 100 MW has not been voted on. A moratorium stops new approvals, not a building already running.

Vernon's utility paused new requests, and the state acted

Vernon Public Utilities says it is not processing new data center capacity or expansion requests until further notice. The notice is undated. On August 5 the state Energy Commission began an environmental impact report on 99 MW of backup generators for two Goodman Energy Park data center buildings in Vernon, applied for in February 2025. On September 21 the Governor signed seven data center bills, CalMatters reported (news). Two from the Legislature's records: SB 887 ends categorical exemptions from environmental review for data centers, and AB 2469 requires water information before a city or county permits one.

4300 South Alameda Street, Vernon

Location
4300 South Alameda Street, Vernon, Los Angeles County (parcel 6302-017-052)
Applicant of record
Not named in the city's permit report. A county flood control permit on the parcel is labelled CoreSite LA5.
Valuation, as filed
$156,354,270
Power
Utility service at 13.8 kV and eight 3.5 MW standby generators in the first phase. These are backup ratings, not IT load.
Cooling
Four 1,650-ton water-cooled chillers with cooling towers in the first phase, and four more planned.
Work, as filed
"Existing building to be demolished and new data center to be built at the given location."
Filing and status
Building permit issued July 13, 2026. Mechanical and electrical permits followed on July 14, grading on July 15 and plumbing on July 28. Grading for a substation site at 1936 East Vernon Avenue was issued on August 26 (August report, page 23). The application was filed in Q3 2025.
Filed
September 18, 2025
Record
IND-2025-0165 (July permit report, page 96)
Final edition

Completed October 8, 2026. Any later correction is listed under Sources and revisions. They cover the records under Coverage and method, not every permit in the five counties. No regional total is given. A permit shows construction, not space anyone can lease.

A site counts once in a quarter however many permits it files. Los Angeles city permits whose records name a data center, the same query in every quarter. Vernon's July and August 2026 permit reports. One Redondo Beach address. Not a regional total.

Earlier quarters, from the records we have

These counts come from the records we could search for each quarter. Some sources only start partway through, so read them as what the records show, not as a trend.

QuarterGreater Los Angeles: sites filing to add capacity
Q2 20261
Q1 20260
Q4 20250
Q3 20252
Q2 20251
Q1 20250

Every count's record is in the table below.

What to watch

  • October 6, 2026: the Board of Supervisors sent a motion to write a large-scale data center prohibition into the county zoning code back to Supervisor Solis's office without adopting it, Voice of Black LA reported (news). The planning director's bar stays in place.
  • November 3, 2026: Alhambra voters decide Measure DB, which would let only voters lift the city's data center ban.
  • No date set: Commerce's outcome on its moratorium extension and citywide ban, Vernon's September permit report, and the draft environmental report on the Goodman Energy Park generators.

The records

Every project in the record, Q1 2025 to Q3 2026
QuarterFirst filedPermit first issuedWhereThe workTypeRecords
Q1 2025March 19, 2025Q2 2025
April 22, 2025
17200 S Vermont Ave, 5th floor, Los AngelesPower distribution for an expansion of an existing data center's raised floor.No added power stated25041-10000-10743
Q2 2025April 17, 2025Q3 2025
September 5, 2025
600 W 7th St, suite 100, Los Angeles256 new 60 amp receptacle whips in an existing data center.No added power stated25041-10000-17795
Q2 2025June 6, 2025None on record2500 S Navy Way, Port of Los AngelesA new data center with redundant UPS units, transformers and cooling power.New data room or hall25041-10000-27487, 25041-10000-34363
Q3 2025July 31, 2025Q4 2025
December 2, 2025
2500 S Navy Way, building 100, Port of Los AngelesA new 632 square foot data center with new power distribution.New data room or hall25041-10000-34952
Q3 2025August 27, 2025Q3 2025
September 24, 2025
600 W 7th St, suite 420, Los AngelesData center: 312 new receptacles for new server equipment.No added power stated25041-10000-40122
Q3 2025September 18, 2025Q3 2026
July 13, 2026
4300 S Alameda St, VernonExisting building demolished. New data center with chiller plant, power, grading, plumbing and a substation site.New buildingIND-2025-0165 (p. 96), MEC-2025-0150 (p. 97), ELE-2025-0346 (p. 90), E-2025-0653 (p. 92), PLB-2025-0199 (p. 113), E-2026-0788 (p. 23)
Q2 2026April 9, 2026Q3 2026
July 23, 2026
4400 Pacific Blvd, VernonDemolition of an existing building for a new data center development.New buildingDEM-2026-0055 (p. 90)
Q2 2026April 21, 2026Q3 2026
September 8, 2026
1501 W Francisco St, Los AngelesAn existing data center adds 14 cooling units, a cage layout and more power distribution.No added power stated26041-10000-16135, 26016-10000-13551
Q3 2026July 1, 2026*Q3 2026
July 1, 2026
200 E Bauchet St, suite 301, Los Angeles24 new remote power panels and branch circuits in a data hall.No added power stated26041-10000-26278
Q3 2026August 28, 2026**None on record3690 Redondo Beach Ave, Redondo BeachTwo new computer room air conditioning units at an existing data center.No added power stated2602298

* Express permit: the city publishes no filing date. The issue date is treated as the filing date.

** The portal's Permit Date. The application date is not stated.

Each row is one project with every record linked. Vernon page numbers are council packet pages. Valuations are never summed.

Air permits and the state power plant filing (none in Q3 2026)

South Coast air district equipment records for CoreSite and Equinix facilities show no application or permit dated in Q3 2026. Other operators and other air districts were not read, so this is not a finding that none was filed.

The Energy Commission docket holds GIC Vernon LLC's February 2025 application for 40 diesel generators, 38 of 3 MW and two of 1 MW, for two Goodman Energy Park data center buildings in Vernon. The August 5, 2026, notice opened the environmental impact report. A state filing, in no count.

Government actions in the record, 2026
  1. Monterey Park: Saturn Park moratorium, then a citywide ban approved by voters June 2 as Measure NDC (ordinances, certification).
  2. Baldwin Park and El Monte: 45-day moratoria, El Monte's on March 18, both extended in April (minutes, minutes).
  3. Indio: 45-day moratorium (city release). Extended to October 16 on July 15, NBC Palm Springs reported (news).
  4. Coachella: 45-day moratorium and a July extension, KVCR reported (news).
  5. Desert Hot Springs: 45-day moratorium (June 16 meeting). Extension heard July 7 (agenda packet) and adopted, KESQ reported (news).
  6. Alhambra: citywide ban, 5-0 (minutes). Measure DB called for November 3 on July 27 (ballot measures).
  7. Commerce: 45-day moratorium to September 25 (file 14-6219). Extension and citywide ban heard September 21 and 22, no outcome recorded (agenda, agenda).
  8. Los Angeles County: departments recommended banning hyperscale data centers in all zones (report).
  9. Palm Springs: moratorium, 5-0 (minutes). Extended to August 25, 2028, on September 30 (agenda), The Palm Springs Post reported (news).
  10. Coachella: citywide ban, 5-0 (minutes).
  11. Los Angeles City Council: motion to study a moratorium above 100 MW, no vote (file 26-1284).
  12. Irwindale: citywide ban, second reading (draft minutes, pages 10 and 11).
  13. Riverside: committee memo for a citywide ban, no outcome (meeting).
  14. Los Angeles County: planning director barred large-scale data centers in unincorporated areas pending a code change (October 6 motion).
  15. State of California: Governor signed SB 887 and AB 2469.

No local action specific to data centers was found for 2025.

Reported (4)

Projects reported in the press or by the operator, with no record saying they build a data center. None of these is in the counts above.

  • DataBank, 3094 East Vernon Avenue, Vernon. A 32 MW data center with Goodman, as the operator announced in April 2026. No Vernon permit names it.
  • 2301 West 120th Street, Hawthorne. Two city filings describe a 4,200 square foot telecom space for new IT racks. Neither calls it a data center.
  • Elsinore Heights Industrial Project, Lake Elsinore. The city's February 2026 notice describes an option with a data center building on 61 acres. No later filing is on record.
  • Puente Hills Mall redevelopment, City of Industry. Proposed as part of the mall's redevelopment, CALÓ News reported (news). No application or site record is public.
Coverage and method

Boundary. Los Angeles, Orange, Ventura, Riverside and San Bernardino counties: 184 cities and five unincorporated areas (SCAG boundaries).

Permit and planning registers reviewed, by county
CountyCities and unincorporated areaWith a permit or planning register reviewedWhich
Los Angeles8912Burbank, Commerce, El Segundo, Gardena, Glendale, Hawthorne, Long Beach, Los Angeles, Pasadena, Redondo Beach, Torrance, Vernon
Orange353Anaheim, Santa Ana, Tustin
Ventura1111Camarillo, Fillmore, Moorpark, Ojai, Oxnard, Port Hueneme, San Buenaventura, Santa Paula, Simi Valley, Thousand Oaks, Unincorporated
Riverside292Riverside, Unincorporated
San Bernardino254Fontana, Rancho Cucamonga, San Bernardino, Unincorporated
Total18932

"Reviewed" ranges from a full quarter of a city's permit data to one address or one month of reports. In the other 157 jurisdictions no permit register was read, which is no finding that nothing was filed there.

Records read. Los Angeles: the city's building, electrical and mechanical permit datasets, every filing since January 1, 2025, whose description says data center or data hall. Vernon: the July and August 2026 permit reports, scanned council packet pages, so a filing appears only once a permit is issued. Redondo Beach: the portal's records at one address. Council and county records for the governments in the timeline, state environmental notices for the five counties, and the Energy Commission's Vernon docket. The other cities in the table held no filing that adds capacity. Certificates of occupancy were not read.

What the figures include. Only permitting that adds data center buildings or capacity. A new building or data room counts without a stated capacity. Work at an existing data center counts only when its record states added power with a figure. Other work there is listed in the table. Power work that does not name a data center counts only above 1 MW with the data center it serves on record. Replacements, repairs, renewals, amendments, voided filings and work whose record does not name a data center are left out.

Counting. A site is one address or campus and counts once in a quarter it files to add buildings or capacity, however many permits it files. A project is one piece of work with its filings, dated by its first filing, or by the building's filing when a city numbers one building's jobs separately. Valuations are the city's figures, never added together. Generator megawatts are backup ratings, never space.

Sources and revisions

Every figure links to the public record it came from. Figures from Vernon's scanned reports are read off the page image. The counts are generated from the records. News coverage is named as news. When this edition is final its figures are frozen. A later correction is added here with its date and reason.

Colocation Scout is run by a wholesale and colocation consulting company. The permit data is public and every row links to its filing. How we publish these reports.

Revisions: none yet. Edition status: final.

Cite this report as: Colocation Scout, "Greater Los Angeles data center permits, Q3 2026," colocationscout.com/reports/los-angeles-data-center-permits-q3-2026.html

Media inquiries

Cody Swift
Data Center Advisor at Colocation Scout
Powered by Bridgepointe Technologies
844-506-2299

Research at Colocation Scout

Colocation Scout tracks data center construction across U.S. markets from public records: building permits, planning cases and state air permits. Every figure in a report links to the filing it came from, so any reader can check it. How we publish these reports.

About Bridgepointe Technologies

Bridgepointe Technologies has been a technology advisory firm since 2002. It helps companies choose data center, connectivity and cloud providers. It has more than 400 strategists, consultants, engineers and support staff. It has completed more than 1,200 data center and cloud projects.

Market intelligence

Ask what the record means for your requirement.

The filings show where data center work around Los Angeles is on file and where cities are moving to limit it. A scout finds out which of it is reachable at your size, on your date, at a price worth signing.
