Q3 2026 Market Report / Phoenix and Mesa

Phoenix data center filings, Q3 2026: two new data center buildings, both in Mesa, and none found in Phoenix's permit records.

Q3 2026 filings to build data center space in the Mesa and Phoenix city records, and the decisions around them, each linked to its public record. Phoenix's records were searched by permit name, operator and address, so a filing under a codename could be missed.

2

new data center buildings filed, both on Mesa's East Elliot Road, neither issued by the end of September. Phoenix's permit records, searched by name, operator and address, show none.

2

local government decisions on data center projects by Phoenix, Mesa, Maricopa County or Pinal County: Phoenix waived its special permit rule for 5C Data Centers on 1 July, and Pinal County denied the La Osa rezoning on 26 August. Casa Grande's waiver is outside those authorities.

Mesa's East Elliot Road drew both of the quarter's new data center buildings, while Phoenix showed no new filing in the records searched, issued permits for three buildings at Thistle Landing and let a fourth project skip its special permit rule.

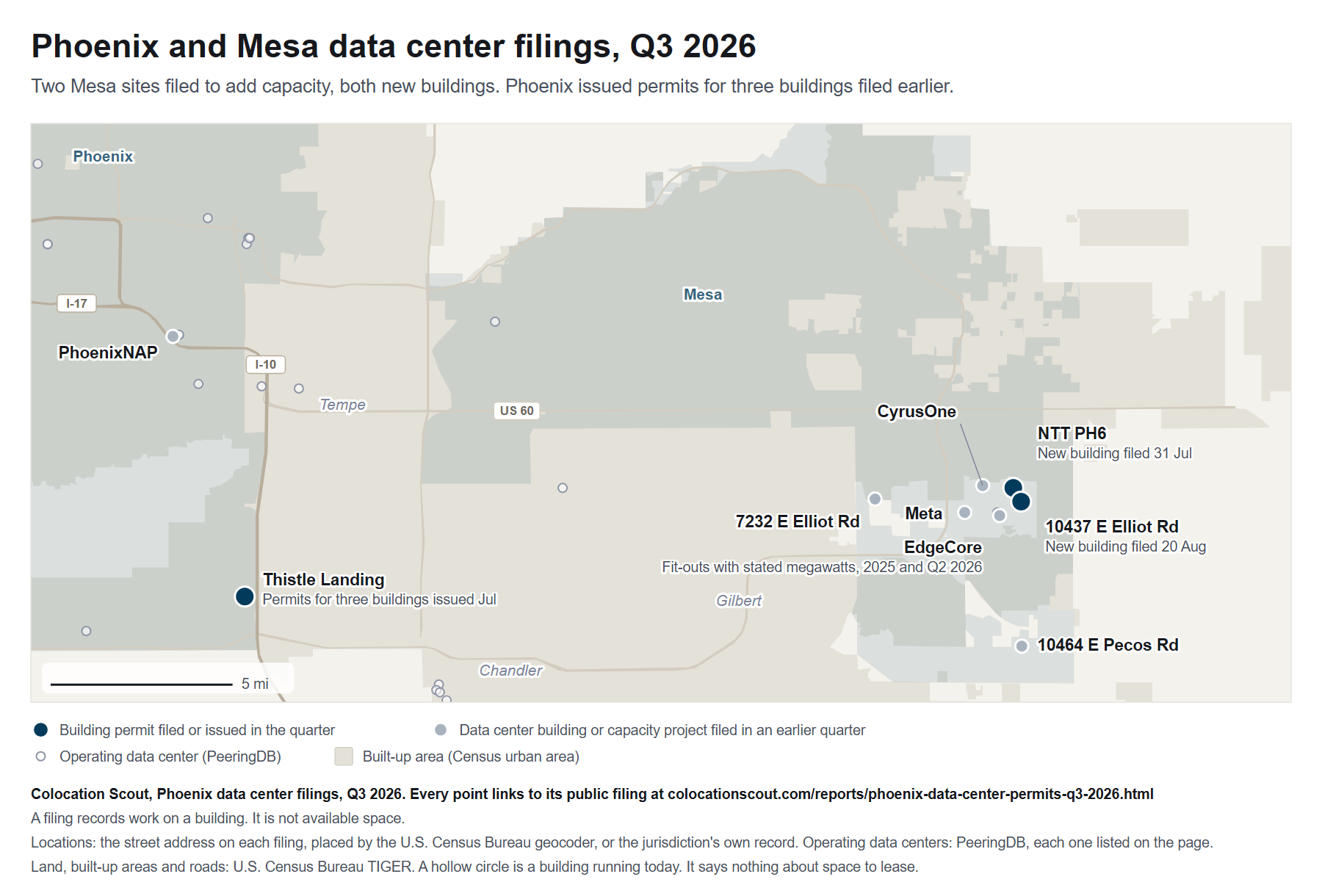

Map of Phoenix and Mesa, Arizona. In Q3 2026 two Mesa sites filed to add data center capacity, both new buildings on East Elliot Road: NTT's PH6 and a 229,416 square foot building at 10437 East Elliot Road. Phoenix issued permits for three buildings at Thistle Landing. Projects filed in earlier quarters are shown in grey, from EdgeCore, CyrusOne, Meta and the Pecos Road building in southeast Mesa to PhoenixNAP II in Phoenix.
Every point on the map is a filing linked on this page. Download the map (PNG). Reporters may republish the map with credit to Colocation Scout and a link to this page.
Operating facilities on the map (21)

The small hollow grey dots are data centers operating today, from the public PeeringDB facility list, each linked to its PeeringDB record. An operating building is context for the filings and is in no count on this page.

OperatorFacilityCityRecord
1GServers, LLC1GServers Data Center PHX1Phoenixpeeringdb.com/fac/16889
CentersquareCentersquare Phoenix (PHX1)Phoenixpeeringdb.com/fac/2642
CentersquareCentersquare Phoenix (PHX3)Mesapeeringdb.com/fac/613
CyrusOne Inc.CyrusOne PhoenixPhoenixpeeringdb.com/fac/1488
DataBank, Ltd.DataBank Phoenix (PHX1)Phoenixpeeringdb.com/fac/10934
DataBank, Ltd.DataBank Phoenix (PHX2)Phoenixpeeringdb.com/fac/10935
DataBank, Ltd.DataBank Phoenix (PHX3)Chandlerpeeringdb.com/fac/10936
Digital RealtyDigital Realty PHX10 (120 E Van Buren)Phoenixpeeringdb.com/fac/171
Digital RealtyDigital Realty PHX15 (2121 S Price Rd)Chandlerpeeringdb.com/fac/5138
EdgeConneX Inc.EdgeConneX Phoenix (EDCPHX01)Tempepeeringdb.com/fac/1917
EdgeCore Digital InfrastructureEdgeCore PhoenixMesapeeringdb.com/fac/12553
ExpedientExpedient PhoenixPhoenixpeeringdb.com/fac/8474
H5 Data CentersH5 Data Centers PhoenixChandlerpeeringdb.com/fac/3076
INAP Holding LLCINAP PhoenixPhoenixpeeringdb.com/fac/8861
Iron Mountain Data CentersIron Mountain Data Center - Phoenix (AZP-1)Phoenixpeeringdb.com/fac/572
Iron Mountain Data CentersIron Mountain Data Center - Phoenix (AZP-2)Phoenixpeeringdb.com/fac/6346
OneNeck IT Solutions LLCUS Signal AZ01 - PhoenixGilbertpeeringdb.com/fac/12307
PhoenixNAPPhoenixNAPPhoenixpeeringdb.com/fac/917
QTS Realty Trust, Inc.QTS Phoenix (PHX1)Phoenixpeeringdb.com/fac/1880
QTS Realty Trust, Inc.QTS Phoenix (PHX2)Phoenixpeeringdb.com/fac/13686
Quantum Names, LLCOmnis Network PhoenixTempepeeringdb.com/fac/4572

What happened this quarter

Two new buildings on Mesa's East Elliot Road

Two sites filed to add data center capacity, both of them new buildings in Mesa. NTT filed PH6 on 31 July: "an additional Data Center building" on "a 244MW master planned site", built first as "a single 8 MW vault" with seven more to follow. Those are NTT's design figures, not connected power. On 20 August a 229,416 square foot data center was filed at 10437 East Elliot Road, near the site of the city's "AWS PHX 062" substation case, although the permit itself names no operator. Neither had been issued by the end of September.

No new Phoenix filing found, and three buildings permitted

Phoenix's permit records show no new data center building, hall or power work this quarter. They carry only a short permit name, so a filing under a codename at an unknown site could be missed. At 4801 East Thistle Landing Drive the city issued the building permit for building 5 on 2 July and the core and shell permit for buildings 1 and 2 on 17 July, both filed in earlier quarters. The records give no size or operator, but a county air application for the address describes a "data center campus using line power".

Phoenix waived its permit rule a fourth time, and Pinal County said no

Since July 2025 Phoenix has required a City Council special permit for any new data center. Owners can claim compensation under Arizona's property-rights law, and the city settles with waivers. On 1 July the Council waived it 8-1 for 5C Data Centers at 2802 West Palm Lane, its fourth waiver. A county air application for that address says "the facility will be a data center", though no city permit names one yet. On 26 August the Pinal County Board of Supervisors denied the La Osa rezoning, 2,394 acres for a data center, gas plant and batteries.

Beyond Mesa and Phoenix: a gas plant, rezonings and a Casa Grande campus

Near Waddell, the county approved a construction yard for Project Baccara on 30 September. It is a gas plant of about 700 MW that the Corporation Commission says will power a planned data center complex. Near Tonopah, county supervisors approved two industrial rezonings, Camelback Creek and Balterra, on 2 September. Their conditions set standards for data center uses, but no data center is filed there. In Casa Grande, outside the two cities counted here, a 954-acre data center campus with its own batteries and power generation filed for a conditional use permit on 13 August, and the planning commission approved it 6-1 on 1 October. On 3 August its council voted 7-0 to waive that permit rule for a separate 480-acre site, settling a property-rights claim (minutes). On 31 August Attorney General Kris Mayes called for a statewide pause on new data centers (azfamily, KTAR), and Governor Katie Hobbs declined (KJZZ, KOLD). Both are news coverage, not government actions.

The quarter's filings

SiteSquare feetEstimated cost, as filedMegawatts, as filed
NTT PH6, 10256 East Elliot RoadMesa, Maricopa County. 1 buildingTBATBA8 MW first vault
10437 East Elliot RoadMesa, Maricopa County. 1 building229,416TBATBA
Total, 2 sites and 2 buildings229,416 (1 of 2 sites)None statedNo total

TBA marks a figure the record does not state yet. Square feet are the data center area each permit's description states, and NTT's states none. Estimated cost, as filed, is the filers' own unverified figure, not total project spend, and neither Mesa record states one. NTT's filing gives a first vault of 8 MW on what it calls a 244 MW master planned site, a design figure rather than connected power, so megawatts are not totalled.

Final edition

Completed 7 October 2026. These figures are frozen, and any later correction is listed under Sources and revisions. The counts cover Mesa and Phoenix city records only, not the whole metro: Goodyear, Avondale, Glendale, Chandler, Casa Grande, Pinal County and unincorporated Maricopa County are not in them. A filing is not space anyone can lease.

Sites filing to add data center capacity, by quarter

0
Q1 25
1
Q2 25
5
Q3 25
6
Q4 25
2
Q1 26
2
Q2 26
2
Q3 26
A site counts once in a quarter however many permits it files. Mesa and Phoenix city permit files only, searched the same way in every quarter. Goodyear, Avondale, Glendale, Chandler and the rest of the metro are not counted. Planning cases count one per case.

Counts this small are not a trend.

What to watch

  • Fourth quarter 2026: whether Mesa issues the building permits for NTT's PH6 and the 10437 East Elliot Road building.
  • Fourth quarter 2026: whether 5C Data Centers, which holds a council waiver and a county air permit for 2802 West Palm Lane, files for a City of Phoenix building permit there.
  • Late 2026: the Corporation Commission's decision in Arizona Public Service's rate case (the commission's schedule).

The records

The quarter's filings, in detail (2)

NTT PH6, Mesa

Location
10256 East Elliot Road, Mesa, Maricopa County (parcel 30401006N)
Applicant of record
NTT Global Data Centers PH LLC
Power
"a single 8 MW vault with 56 MW future vaults 2 through 8", on what the filing calls "a 244MW master planned site". These are NTT's design figures, not connected power.
Work, as filed
"NTT Global Data Centers Americas is adding an additional Data Center building in Mesa, Arizona as part of a 244MW master planned site." The first phase is a core and shell, underground utilities, equipment pads and the first vault.
Filing and status
Commercial building permit application with the City of Mesa, status "Revisions Required". Not issued by the end of September.
Filed
31 July 2026
Record
PMT26-13890

10437 East Elliot Road, Mesa

Location
10437 East Elliot Road, Mesa, Maricopa County (parcel 31410777), near the 43-acre site west of Elliot and Signal Butte roads that the city's "AWS PHX 062" substation case describes. Neither record names the other.
Applicant of record
An individual applicant. The permit names no owner or operator.
Size
229,416 square feet, one story
Work, as filed
"Development of 229,416 SF, Type II-B construction, groups B and S-1 occupancy single story data center", with chiller cooling platforms on the north and south sides
Filing and status
Commercial building permit application with the City of Mesa, status "Revisions Required". Not issued by the end of September.
Filed
20 August 2026
Record
PMT26-15404
Every project adding data center buildings or capacity, Q1 2025 to Q3 2026 (13 projects and 6 planning cases)
QuarterFirst filedPermit first issuedWhereThe workTypeDeclared valueCity records
Q2 202515 April 2025Q3 2025
24 July 2025
3856 S EVERTON TERR, Mesa, AZEdgeCore PH02 Tower 2: three 8 MW data halls, about 120,540 sq ftData hall fit-outNot statedPMT25-06684
Q2 202525 June 2025Q4 2025
21 October 2025
3856 S EVERTON TERR, Mesa, AZEdgeCore PH02 Tower 3 Sector A: 6 MW data hall, first levelData hall fit-out$2.0 millionPMT25-11502
Q3 202522 July 2025Q4 2025
30 December 2025
3255 S 96TH ST, Mesa, AZCyrusOne building 1: two-story shell data hall building, 243,332 sq ftNew buildingNot statedPMT25-13240
Q3 202524 July 2025Q1 2026
15 January 2026
10464 E PECOS RD, Mesa, AZSingle-story data center building, 229,416 sq ft (Mesa case AWS PHX 065)New buildingNot statedPMT25-13554
Q3 2025Pre-submittal meeting, 5 August 2025None on record10010 E Pecos Rd, Mesa, AZData center campus: pre-submittal meetingPlanning caseNot statedPRS25-00576
Q3 2025Pre-submittal meeting, 19 August 2025None on record3841 S Ellsworth Rd, Mesa, AZAdditional data center building: pre-submittal meetingPlanning caseNot statedPRS25-00624
Q3 2025Pre-submittal meeting, 19 August 2025None on record7232 E Elliot Rd, Mesa, AZAdditional data center, phase 3: pre-submittal meetingPlanning caseNot statedPRS25-00625
Q4 202513 October 2025Q1 2026
9 February 2026
3856 S EVERTON TERR, Mesa, AZEdgeCore PH02 Tower 3 Sector H: 12 MW data hall space, 40,964 sq ftData hall fit-out$4.0 millionPMT25-18626
Q4 2025Pre-submittal meeting, 28 October 2025None on record10256 E Elliot Rd, Mesa, AZSite plan modification combining PH6 and PH7: pre-submittal meetingPlanning caseNot statedPRS25-00804
Q4 202530 October 2025None on record775 S 6TH AVE, Phoenix, AZPHX-MBA data center: preliminary site plan reviewPlanning caseNot statedPlan review 2506977
Q4 202531 October 2025Q3 2026
17 July 2026
4801 E THISTLE LANDING DR, Phoenix, AZThistle Landing buildings 1 and 2: core and shell, filed as a plan reviewNew buildingNot statedPlan review 2505672-02, 26008875
Q4 20259 December 2025None on record10010 E Pecos Rd, Mesa, AZNTT Mesa PH10: design review casePlanning caseNot statedDRB25-00623
Q4 202516 December 2025Q1 2026
26 March 2026
3225 E ELWOOD ST, Phoenix, AZPhoenixNAP II: new data center shellNew buildingNot stated26004695
Q1 202622 January 2026Q2 2026
18 June 2026
7232 E ELLIOT RD, Mesa, AZNew data hall building, 285,282 sq ft, with mechanical and electrical yardsNew buildingNot statedPMT26-01256
Q1 202617 February 2026Q2 2026
7 May 2026
3841 S ELLSWORTH RD, Mesa, AZMeta MAZ7: new data storage building, 144,640 sq ftNew buildingNot statedPMT26-03021
Q2 202613 April 2026Q3 2026
14 July 2026
3856 S EVERTON TERR, Mesa, AZEdgeCore PH02 Tower 3 Sectors G and H: 6 MW data hall space, about 58,000 sq ftData hall fit-out$6.0 millionPMT26-06976
Q2 202617 June 2026Q3 2026
2 July 2026
4801 E THISTLE LANDING DR, Phoenix, AZThistle Landing building 5: new data center buildingNew buildingNot stated26008627
Q3 202631 July 2026None on record10256 E ELLIOT RD, Mesa, AZNTT PH6: new building, one 8 MW vault first, seven more plannedNew buildingNot statedPMT26-13890
Q3 202620 August 2026None on record10437 E ELLIOT RD, Mesa, AZSingle-story data center building, 229,416 sq ft, operator not namedNew buildingNot statedPMT26-15404

A Phoenix plan review is the filing, and the later permit is the issue.

County air permit applications at new data center sites, 2025 and 2026 (none in Q3)

County air applications are a separate series, listed below, not counted.

ReceivedFacility, as the county names itPlaceApplication
14 February 2025PHX065MesaA0011802
27 February 2025PHX069AvondaleA0011852
3 April 2025CyrusOne - MesaMesaA0011441
13 May 2025Takanock Baccara (gas turbines for a planned data center)WaddellA0012237
3 June 2025Vantage Data Centers (AZ2)GoodyearA0012420
24 June 2025PHX01AvondaleA0012561
11 July 2025IB10 Hermosa RanchAvondaleA0012638
8 September 2025Novva PhoenixMesaA0012859
1 May 2026HEGIC NorthTonopahA0014418
25 June 2026MD-PHX1PhoenixA0014711
26 June 2026Project Eagle Data CenterWaddellA0014684
29 June 2026PHX (2802 W Palm Ln)PhoenixA0014522

First applications at new sites, from county records and weekly reports to 26 September 2026. An air permit covers backup engines, not capacity.

Government actions, July 2025 to September 2026
  1. Phoenix council: data center special permit rule, 9-0 (G-7396).
  2. Phoenix council: first waiver, 9-0 (S-52436). Pinal County: La Osa and Project Midway plan amendments approved (summary).
  3. Chandler council: Price Road campus rezoning denied 7-0 (minutes).
  4. Phoenix council: second waiver, 8-1 (S-52435).
  5. Corporation Commission: Baccara Power gas plant certificate (release).
  6. Phoenix council: third waiver, Aligned, 7-1 (S-52717).
  7. Mesa zoning board: NTT Mesa PH10 rezoning on the agenda. No council vote on record.
  8. Phoenix council: fourth waiver, 5C Data Centers, 8-1 (S-53089).
  9. Casa Grande council: waiver of its data center use permit rule for about 480 acres, Resolution 5960, 7-0 (minutes).
  10. Pinal County: La Osa rezoning denied (summary).
  11. Maricopa County supervisors: Balterra (3-0) and Camelback Creek (4-0) rezonings approved (summary).
  12. Maricopa County: Baccara construction yard approved (UC260030).
Reported (11)

Projects reported in the press or in a record that does not say what it builds. None of these is in the counts above.

  • Avondale. QTS, eight buildings on 212 acres, approved July 2025 (PL-23-0205). Hermosa Ranch (PL-22-0094) and STACK (PL-22-0194) under construction.
  • El Mirage. Microsoft PHX82 and PHX83 (SPA24-02-01, SPA24-09-01) and Compass PHX II (PZ22-11-31), under construction.
  • Aligned, Reems Road, Glendale. City permit reports list a foundation at 8895 North Reems Road (22 July) and tenant improvements at 8907 (20 August), by an Aligned parcel, with no work description.
  • Tonopah and Wintersburg. Hassayampa Ranch, Wintersburg 313, Camelback Creek and Balterra, rezonings with data center standards (March, May and August minutes). No operator or building permit.
  • Mesa, no power figure. In Q3: CyrusOne's data hall (PMT26-17452) and Edged's cooling galleries (PMT26-12295). Earlier: NTT PH5 vaults (PMT25-23755 and related permits), Edged's busways (PMT26-00884), EdgeCore halls (PMT25-01071, PMT25-15477) and 3261 South Hawes Road (PMT25-09255, PMT25-17623).
  • Phoenix, no power figure. Suites at 5100 East Roosevelt Street (25017747, 26003848, 26003918) and 4802 East Van Buren Street (26004581), QTS hall 1200 (25004476) and PhoenixNAP cooling (2601745).
  • Novva, Mesa. About 159 acres at Warner and Ellsworth roads, site plan approved January 2025 (ZON24-00291), air application September 2025 (A0012859). No permit names it.
  • Project Eagle, Waddell. A data center air application with 33 backup engines (A0014684) on the Project Baccara parcel (MCP250007). No building permit or operator.
  • HEGIC North, Tonopah. A data center air application with its own generation (A0014418). Size and operator unconfirmed.
  • Project Midway and W Holdings, Pinal County. Plan amendments approved November 2025 (county summary), Midway's for a data center on about 215 acres and W Holdings' for an energy and technology campus (staff report). Rezoning and operator unconfirmed.
  • Buckeye Tech Corridor, Buckeye. A 2,109 acre master plan, approved August 2024 (PLZZ-23-00005) naming no operator or use. No Buckeye permit names a data center.
Coverage and method

Covered. Besides the counted Mesa and Phoenix records: county air applications, planning records of Maricopa County, Avondale, El Mirage and Buckeye, Casa Grande planning and council records, Glendale permit reports, and actions of Phoenix, Mesa, Chandler, Maricopa County, Pinal County and the Arizona Corporation Commission.

Boundary, version 1. The Phoenix-Mesa-Chandler metro in OMB Bulletin 23-01 (July 2023): Maricopa and Pinal counties. Left out: Yavapai (Prescott metro), Gila (Payson) and Pima (Tucson metro) counties.

AuthorityRecordsQ1 2025 to Q3 2026
MesaPermits and planning cases, by wording and addressCounted, partial
PhoenixPermits and plan reviews, by name, operator and address, so a codenamed filing could be missedCounted, partial
Maricopa County Air Quality DepartmentAir applicationsSeparate series, to 26 September 2026
Phoenix, MesaCouncil and board agendasReviewed. Mesa's online agenda records do not show council outcomes
Maricopa and Pinal countiesPlanning cases, board actionsReviewed, not counted
Chandler, Avondale, El Mirage, Buckeye, TempePermits, planning layersReviewed, not counted
GlendaleIssued permits, no work descriptionNot counted
GoodyearPermit layer ends November 2024Not covered
Casa Grande, Eloy, CoolidgeMeetings, planningPartial. Casa Grande meetings from 17 August 2026
Other cities and townsNoneNot collected

What is counted. Filings that add data center buildings or capacity: new buildings, planning cases for new sites, and work inside an existing data center whose filing states added power with a figure. Repairs, replacements and fire, sign or office work are not.

Decisions. The figure counts official Phoenix, Mesa, Maricopa County and Pinal County actions that approve, waive or deny a named data center project. Casa Grande is a city outside those authorities, the same reason its Grande Valley filing is not counted.

Counting. A site (one address or campus) counts once in a quarter it files, a project is dated by its first filing, and a planning case counts once. Certificates of occupancy are not counted, which is not a finding that none were issued.

Sources and revisions

Every figure links to the public record it came from, and the counts are generated from those records. News coverage is named as news and never counted. When this edition is final its figures are frozen, and any later correction is added here with its date and reason.

Colocation Scout is run by a wholesale and colocation consultant. The permit data is public and every row links to its filing. How we publish these reports.

Revisions: none yet. Edition status: final.

Cite this report as: Colocation Scout, "Phoenix data center filings, Q3 2026," colocationscout.com/reports/phoenix-data-center-permits-q3-2026.html

Media inquiries

Cody Swift
Data Center Advisor at Colocation Scout
Powered by Bridgepointe Technologies
844-506-2299

Research at Colocation Scout

Colocation Scout tracks data center construction across U.S. markets from public records: building permits, planning cases and state air permits. Every figure in a report links to the filing it came from, so any reader can check it. How we publish these reports.

About Bridgepointe Technologies

Bridgepointe Technologies has been a technology advisory firm since 2002. It helps companies choose data center, connectivity and cloud providers, and partners with more than 380 of them. It has completed more than 1,200 data center and colocation projects as of 2026.

Market intelligence

Ask what the record means for your requirement.

The filings show where data center work in Phoenix and Mesa is on file. A scout finds out which of it is reachable at your size, on your date, at a price worth signing.
