4

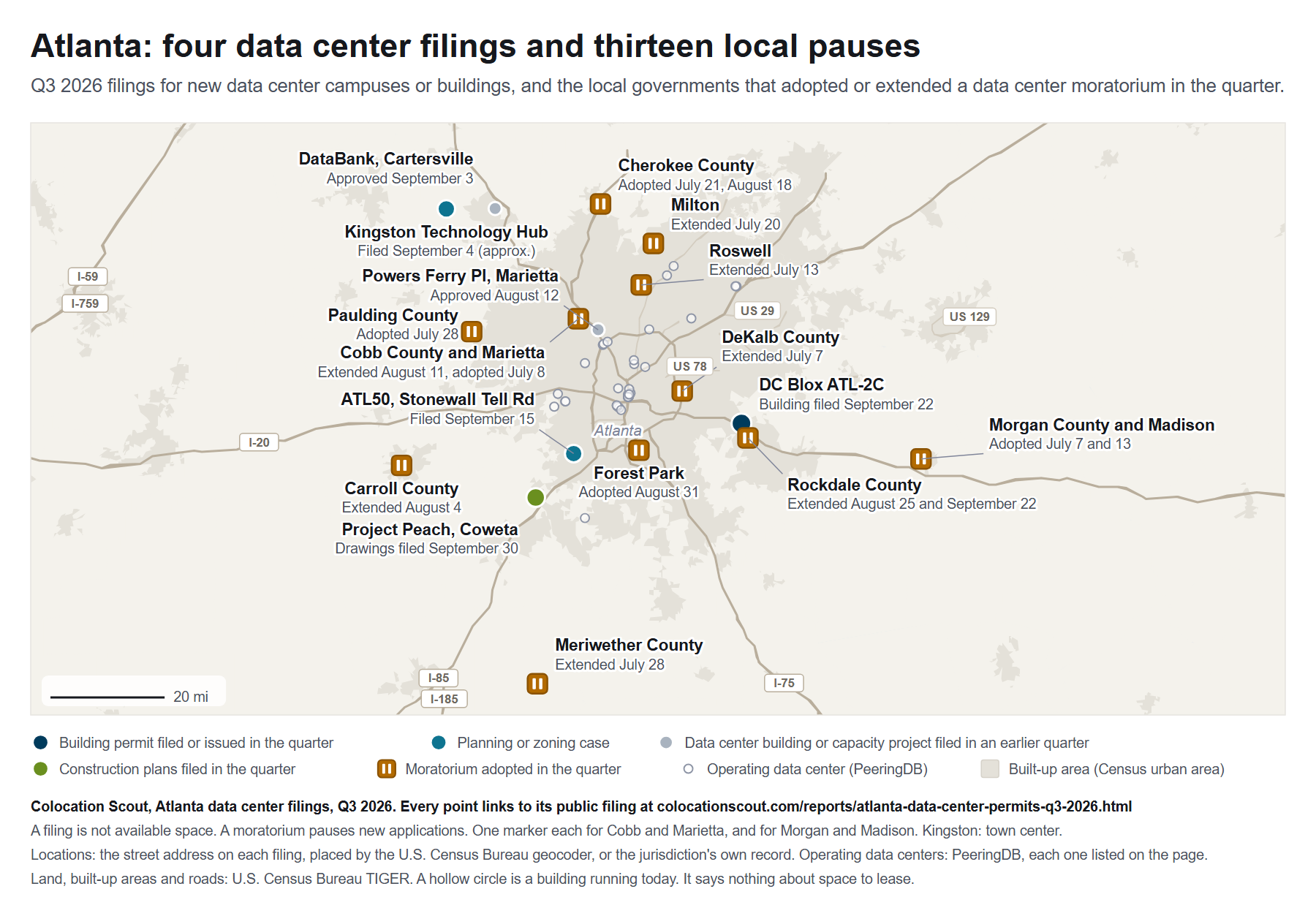

sites filed for new data center campuses or buildings in Q3 in the records reviewed: two campuses entered the state's regional impact review, DC Blox applied for a building in Rockdale and Project Peach filed construction drawings in Coweta. The metro total of local permits is unknown.
13
local governments adopted or extended a data center moratorium in Q3, among them DeKalb, Cobb and Cherokee counties and the cities of Marietta and Roswell.
2
county boards denied data center campuses, in Douglas and Coweta, while Cartersville and Marietta approved projects.
Microsoft and Thor Acquisition sent campuses to the state's regional review, DC Blox and Coweta's Project Peach filed for buildings, and thirteen local governments paused new data center applications.
Operating facilities on the map (42)
The small hollow grey dots are data centers listed in the public PeeringDB facility list, each linked to its record. Listings marked closed are left off. A listed building is in no count on this page.
| Operator | Facility | City | Record |
|---|---|---|---|
| 365 Data Centers | 365 Data Centers Alpharetta (GA1) | Alpharetta | peeringdb.com/fac/16127 |
| 365 Data Centers | 365 Data Centers Smyrna (GA2) | Smyrna | peeringdb.com/fac/16132 |
| Centersquare | Centersquare Atlanta (ATL1-A/B/C) | Lithia Springs | peeringdb.com/fac/4048 |
| Centersquare | Centersquare Atlanta (ATL1-D) | Lithia Springs | peeringdb.com/fac/6675 |
| Cogent Communications, Inc. | Cogent Atlanta | Atlanta | peeringdb.com/fac/9622 |
| Cogent Communications, Inc. | Cogent Atlanta 2 | Atlanta | peeringdb.com/fac/16444 |
| Colo at 55, LLC | Colo at 55, LLC | Atlanta | peeringdb.com/fac/619 |
| Coloblox Data Centers Inc | Coloblox Data Centers ATL1 | Atlanta | peeringdb.com/fac/7938 |
| Coloblox Data Centers Inc | Coloblox Data Centers ATL2 | Atlanta | peeringdb.com/fac/4604 |
| Coloblox Data Centers Inc | Coloblox Data Centers ATL3 | Atlanta | peeringdb.com/fac/6022 |
| CoreSite | CoreSite - Atlanta (AT1) | Atlanta | peeringdb.com/fac/1337 |
| CoreSite | CoreSite - Atlanta (AT2) | Marietta | peeringdb.com/fac/6638 |
| DataBank, Ltd. | Databank Atlanta (ATL1) | Atlanta | peeringdb.com/fac/8484 |
| DataBank, Ltd. | DataBank Atlanta (ATL2) | Atlanta | peeringdb.com/fac/3853 |
| DataBank, Ltd. | DataBank Atlanta (ATL3) | Atlanta | peeringdb.com/fac/10916 |
| DC BLOX Parent LLC | DC BLOX ATL1 - DCBLOX Atlanta | Atlanta | peeringdb.com/fac/7220 |
| Digital Realty | Digital Realty ATL13 - Atlanta | Atlanta | peeringdb.com/fac/125 |
| Digital Realty | Digital Realty ATL14 - Atlanta | Atlanta | peeringdb.com/fac/3725 |
| EdgeConneX Inc. | EdgeConneX Atlanta (EDCATL01) | Atlanta | peeringdb.com/fac/1929 |
| EdgeConneX Inc. | EdgeConneX Atlanta (EDCATL02) | Atlanta | peeringdb.com/fac/7568 |
| Equinix, Inc. | Equinix AT1 - Atlanta | Atlanta | peeringdb.com/fac/940 |
| Equinix, Inc. | Equinix AT2/AT3 - Atlanta | Atlanta | peeringdb.com/fac/11 |
| Equinix, Inc. | Equinix AT4 - Atlanta | Atlanta | peeringdb.com/fac/12513 |
| Flexential Corp. | Flexential - Atlanta/Alpharetta (ATL3/4) | Alpharetta | peeringdb.com/fac/4996 |
| Flexential Corp. | Flexential - Atlanta/Douglasville (ATL5) | Douglasville | peeringdb.com/fac/13389 |
| Flexential Corp. | Flexential - Atlanta/Norcross (ATL1/2) | Norcross | peeringdb.com/fac/4995 |
| H5 Data Centers | H5 Data Centers Atlanta | Atlanta | peeringdb.com/fac/3078 |
| Lincoln Rackhouse | Lincoln Rackhouse Atlanta | Dunwoody | peeringdb.com/fac/10104 |
| Lumen Technologies Inc | Level(3) Atlanta (Courtland) | Atlanta | peeringdb.com/fac/249 |
| Lumen Technologies Inc | Level(3) Atlanta (Peachtree) | Atlanta | peeringdb.com/fac/1729 |
| Performive | Atlanta Tech Village | Atlanta | peeringdb.com/fac/2269 |
| Performive | Colo@ (Buckhead) | Atlanta | peeringdb.com/fac/2268 |
| Performive | Colo@34 (Downtown) | Atlanta | peeringdb.com/fac/1293 |
| PhoenixNAP | PhoenixNAP ATLANTA | Marietta | peeringdb.com/fac/8341 |
| QTS Realty Trust, Inc. | QTS Atlanta-Fayetteville (ATL2) | Fayetteville | peeringdb.com/fac/16563 |
| QTS Realty Trust, Inc. | QTS Atlanta-Metro (ATL1) | Atlanta | peeringdb.com/fac/581 |
| QTS Realty Trust, Inc. | QTS Atlanta-Suwanee (SUW1) | Suwanee | peeringdb.com/fac/580 |
| Serverfarm | Serverfarm ATL1 Atlanta | Suwanee | peeringdb.com/fac/5435 |
| Southern Telecom | Southern Telecom | Atlanta | peeringdb.com/fac/15861 |
| T5 Data Centers | T5@Atlanta | Lithia Springs | peeringdb.com/fac/11930 |
| Verizon Communications, Inc. | Verizon Atlanta | Atlanta | peeringdb.com/fac/3951 |
| VPLS | Evocative ATL1 | Atlanta | peeringdb.com/fac/5890 |
What happened this quarter
Four sites filed for new campuses or buildings
Four sites filed for new data center campuses or buildings in Q3 in the records reviewed. Two entered the state's review of developments of regional impact, which every Georgia local government files for large projects. Union City filed Microsoft's ATL50 on September 15: two three-story buildings totalling 910,000 square feet on 88 acres off Stonewall Tell Road. Kingston filed the Kingston Technology Hub on September 4, one building of about 350,000 square feet on 559 acres. A third, Stillwater Technology Park in Lovejoy, about 3,465,000 square feet, was filed on July 22 and withdrawn on August 10. In Rockdale, DC Blox applied on September 22 for the shell of a further building on its Farmer Road campus. In Coweta, construction drawings for Project Peach, a campus rezoned in April 2025, were filed on September 30.
Two counties turned campuses down, two cities approved projects
Two county boards denied data center campuses. Douglas County's commissioners denied East Village Dothan, about 4.5 million square feet on some 700 acres near Villa Rica, by 4-1 on July 7, and Coweta's board denied LDO Coweta's five-building campus on Walt Sanders Road by 5-0 on August 25. DeKalb's commissioners denied 7-0 on August 13 a special land use permit for utility structures on Loveless Place in Ellenwood, a site its staff report describes as a one million square foot data center campus. Cartersville went the other way on September 3, rezoning DataBank's Industrial Park Road site by 6-0 after a June regional filing that states 200 MW of critical IT load. Marietta approved a data infrastructure use for part of a building at 1155 Powers Ferry Place on August 12. Rockdale heard the Project Rockforge campus on September 24, with no decision recorded in the quarter.
Thirteen local governments paused new projects
Thirteen local governments adopted or extended a data center moratorium in the quarter. DeKalb extended its pause in July, Cobb extended its own by up to 180 days, and Cherokee adopted a 30-day moratorium in July and a 180-day one in August. Marietta, Roswell, Milton, Paulding, Carroll, Rockdale, Forest Park, Meriwether, Morgan County and Madison also acted. Others wrote rules instead: South Fulton replaced its data center ordinance, Roswell, Dawson and Bartow adopted standards, and Chattahoochee Hills removed data processing from its zoning uses. Atlanta's council has held a proposed exception for a data center site in Adair Park in committee since July.
More data halls inside existing buildings, and a gas plant for a data center
No new data center building was filed in the City of Atlanta in Q3. The city's filings add data space inside existing buildings. An Edged application filed on August 20 would fit out data halls on two floors at 1968 Marietta Road, at an estimated $44,445,616 as filed, and filings at 55 Marietta Street in July and September would convert office floors to data facilities. In Newton County, the state issued an air permit on September 18 for a 90 MW gas-fired plant on Hazelbrand Road that the permit says will supply prime power to a nearby Serverfarm facility. Two days earlier the state had settled with its developer, VoltaGrid, over engines installed before a permit.
The quarter's filings
| Site | Square feet | Estimated cost, as filed | Power, as filed |
|---|---|---|---|
| Kingston Technology HubKingston, Bartow County. One building | 350,000 | About $1,000,000,000 | “Approximately 150 Megawatts per day” |
| ATL50Union City, Fulton County. Two buildings | 910,000 | TBA | TBA |
| DC Blox ATL-2CFarmer Road, Rockdale County. One building | TBA | TBA | TBA |
| Project Peach construction drawingsPalmetto area, Coweta County. Building count not stated | TBA | TBA | TBA |
| Total, 4 sites | 1,260,000 (2 of 4 sites) | $1,000,000,000 (1 of 4 sites) | Not added |
TBA marks a figure the record does not state yet. Estimated cost, as filed, is the filers' own unverified figure, not total project spend. Power is quoted as the form words it.
Sites filing to add data center capacity, by quarter
A site counts once in a quarter however many permits it files. The counts come from the state's regional impact register, which covers every local government in the 29 counties but only projects above its size thresholds, from building permits in the City of Atlanta and the Gwinnett, Clayton, Rockdale and Newton registers, and from local planning applications that carry a filing date. Many cities and counties publish no searchable permit register, so a quarter can be missing a filing.
Earlier quarters, from the records we have
These counts come from the records we could search for each quarter. Some sources only start partway through, so read them as what the records show, not as a trend.
| Quarter | Atlanta metro: sites filing to add capacity |
|---|---|
| Q2 2026 | 3 |
| Q1 2026 | 5 |
| Q4 2025 | 4 |
| Q3 2025 | 4 |
| Q2 2025 | 6 |
| Q1 2025 | 8 |
Filings and decisions by quarter
Regional impact filings are dated by the local government's submission, and local permits and applications by their filing date. The register shows no data center filing in the metro from July to mid October 2025.
What to watch next
- October 2026. Coweta's board is to hold a hearing at its second October meeting, date to be set, on possibly rezoning the Project Peach site. Published record.
- October 26, 2026. Kingston's council is scheduled to hold its first hearing on annexing 561.51 acres, the Kingston Technology Hub site, with final action set for November 2. Published record.
- November 6, 2026. Comments close on the state air permit application for Amazon's ATL 114 campus on South Flat Rock Road in Douglasville. Published record.
The records behind the findings
The quarter's filings, in detail (4)
Kingston Technology Hub
- Location
- Bartow County tax parcel 0037-0197-001, about 559 acres. The City of Kingston submitted the filing.
- Developer
- Thor Acquisition WC LLC
- Work, as filed
- “One (1) Approximately 350,000 Square Foot Proposed Data Center Facility”
- Power, as filed
- “Approximately 150 Megawatts per day”, from the Municipal Electric Authority of Georgia
- Estimated cost, as filed
- “Approximately $1 Billion USD”
- Filing and status
- Development of regional impact submitted September 4, 2026, for a rezoning. The regional commission's finding is dated September 29.
- Record
- DRI 4835
ATL50
- Location
- 5235 Stonewall Tell Road, west of Stonewall Tell Road and north of Koweta Road
- Developer
- Microsoft
- Work, as filed
- “a data center development on 88.01 acres of land that consists of two, 3-story buildings totaling 910,000 square feet”
- Filing and status
- Development of regional impact submitted by Union City on September 15, 2026, for a permit and master plan review. Only the initial form is on record. Buildout is listed as 2032.
- Record
- DRI 4843
DC Blox ATL-2C
- Location
- 1726 Farmer Road NW, Conyers, on the DC Blox Atlanta East campus
- Owner of record
- Dcb Atlanta East LLC
- Work, as filed
- “DC Blox ATL- 2C - Core and Shell Permit” for “a cold dark shell”, with no mechanical, electrical or plumbing plans
- Filing and status
- Building permit application created September 22, 2026, not yet issued. The register row gives no square footage or power. A two-story, 192,437-square-foot building on the same campus was filed in October 2025.
- Record
- Rockdale County permit register, web case 55690
Project Peach construction drawings
- Location
- 200 Johnston Circle, Palmetto, in unincorporated Coweta County
- Project
- Project Peach, a data center campus of about 2.1 million square feet that Coweta rezoned on April 15, 2025. The drawings record names only “Project Peach”.
- Work, as filed
- “Construction Drawings”, with offsite sewer drawings filed the same day
- Pending hearing
- On October 21, 2025 Coweta's board voted 4-1 to hold a hearing at its second October 2026 meeting on possibly rezoning the site back to rural use, under a condition of the rezoning, giving the owner 12 months to obtain a power purchase agreement.
- Filing and status
- Construction drawings filed September 30, 2026, in review. The public record states no square footage, building count or power.
- Record
- CD-26-062
Every data center project with a dated record, Q1 2025 to Q3 2026 (61)
| Site and records | Authority | First filed | Permit first issued | Declared value | Scope |
|---|---|---|---|---|---|
| Stillwater Technology Park / DRI 4794 | Lovejoy | July 22, 2026 | Withdrawn August 10, 2026 | $13,000,000,000 | About 3,465,000 sq ft of data center buildings |
| Kingston Technology Hub / DRI 4835 | Kingston | September 4, 2026 | Planning case, not decided | About $1 billion | One building of about 350,000 sq ft on 559 acres |
| ATL50 / DRI 4843 | Union City | September 15, 2026 | Planning case, not decided | Not stated | Two buildings, 910,000 sq ft, 88 acres |
| DC Blox Atlanta East campus / 25-012274 web case 55690 ATL-2C core and shell, filed September 22, 2026 | Rockdale | October 15, 2025 | ATL2 issued December 30, 2025. ATL-2C not issued | Not stated | ATL2, 192,437 sq ft, filed October 15, 2025. ATL-2C shell filed September 22, 2026 |
| DataBank Project Indo / DRI 4761 Z26-05 Council rezoning, September 3, 2026 | Cartersville | June 19, 2026 | Rezoned September 3, 2026 | $2.4 billion | 200 MW critical IT load, as filed |
| Bridgeport (revised) / DRI 4727 | Coweta | April 28, 2026 | Regional review completed | $3 to $5 billion | Technological facility added to an industrial park. Load request up to 1,500 MW, as filed |
| Henderson Farms / DRI 4680 CU-25-01-17 conditional use approved March 25, 2025 | Hampton | March 24, 2026 | Regional review completed | $650 million | Mixed-use tract with a data center campus, 200 MW as filed |
| Hampton Technology Park / DRI 4624 | Hampton | February 13, 2026 | Regional review completed | $12 billion | Five buildings, 4,000,000 sq ft, 603.56 acres, 1,500 MW peak as filed |
| The Crossings / DRI 4617 | Union City | February 12, 2026 | Review terminated | Not stated | Data center development on 231.8 acres |
| 75 South Data Center Campus / DRI 4607 withdrawal letter 26-01FLUM, 26-01Z, 26-01S and 26-07V withdrawn, June 25, 2026 | Spalding | January 27, 2026 | Applications withdrawn June 25, 2026. The applicant said it would refile | $6 billion | Seven buildings, 2,240,000 sq ft, 450 MW as filed |
| Project Bus / DRI 4606 | Temple | January 26, 2026 | Withdrawn | $11 billion | 12 buildings and two substations on 350.73 acres |
| ATL2 East (QTS) / DRI 4603 25-O-34 QTS East Campus rezoning approved December 18, 2025 | Fayetteville | January 13, 2026 | Regional review completed | $3 billion | 2,000,000 sq ft data center west of Veterans Parkway |
| Wallace Jackson Data Center Campus / DRI 4599 | Spalding | January 6, 2026 | Regional review completed | $3,650,000,000 | Ten buildings, 4,986,000 sq ft |
| 4350 E Tanners Church Road / BCOM-1225-01957 | Clayton | December 11, 2025 | In review in the 2025 file | $24,458,250 | Building shell, 309,911 sq ft. A Data Hall 2 permit followed on August 11, 2026 |
| Stanton Springs MWG 7 / CBP25-001118 | Newton (for the Stanton Springs authority) | October 23, 2025 | Issued October 23, 2025 | Not stated | New data center building, tensioned membrane structure. The record places it in Morgan County |
| Flexential expansion, Peachtree Corners / SUP2025-002 | Peachtree Corners | Letter of intent dated October 1, 2025 | Approved December 16, 2025 | Not stated | Expansion into 2755 Northwoods Parkway, four 1.5 MW blocks as filed |
| Highway 16 Interstate Health Development / DRI 4560 | Butts | October 14, 2025 | Regional review completed | $10 billion | Mixed-use development naming data center use, about 11 million sq ft in all |
| 1611 Ellsworth / DRI 4506 | City of Atlanta | June 30, 2025 | Regional review completed | $1 billion | Mixed-use plan naming a data center |
| ATL 15 and 16 (Digital Realty) / DRI 4482 | Forest Park | May 30, 2025 | Regional review completed | $2.55 billion | About 1,902,657 sq ft on 97 acres at Fort Gillem |
| T5 ATL IV / DRI 4465 | Fairburn | May 5, 2025 | Regional review completed | $3.2 billion | Six data center buildings |
| Project Rockforge / DRI 4456 REZ2025-08 county rezoning, filed April 22, 2025 | Rockdale | April 14, 2025 | Heard September 24, 2026, no decision recorded in the quarter | $8,953,374,500 | Eight buildings, 4,089,000 sq ft in the regional filing. Seven buildings, 2,961,000 sq ft in the county hearing packet |
| Avemore / DRI 4451 | Villa Rica | April 11, 2025 | Rezoned May 2025 | More than $45 million | Technology campus and data park |
| Project Bunkhouse / DRI 4433 | Bartow | March 31, 2025 | Rezoned June 4, 2025 | $19 billion | Eight data center buildings |
| Project Spalding / DRI 4425 | Spalding | March 28, 2025 | Rezoned July 14, 2025 | $1,875,000,000 | Data center campus |
| Gregory Road Data Center / DRI 4428 | Covington | March 27, 2025 | Regional review completed | $5.7 billion | Up to 1,410,000 sq ft on about 213 acres |
| Hickman Property (East Village Dothan) / DRI 4422 M2026-01, Z2026-56, S2026-57 denied 4-1, July 7, 2026 | Douglas | March 14, 2025 | Denied December 2, 2025, and July 7, 2026 | $24.9 billion | About 700 acres, 4.5 million sq ft in the county case |
| Project Springbank / DRI 4403 | Bartow | February 14, 2025 | Rezoning withdrawn May 14, 2025 | $4.5 billion | Six buildings, 2,274,000 sq ft |
| Social Circle Technology Park / DRI 4376 DRI 4426 refiled by Social Circle, March 21, 2025 | Newton, then Social Circle | January 16, 2025 | Regional review completed | $5 billion | Nine buildings, 2,567,040 sq ft |
| Central Coweta Industrial Phase II (LDO Coweta) / DRI 4374 REZ 24-20 denied 5-0, August 25, 2026 | Coweta | January 15, 2025 | Denied August 25, 2026 | $4 billion | Eight data center buildings, 2,388,800 sq ft in the regional filing. Five buildings, 1,828,368 sq ft in the amended county case |
| Edged ATL01-3 shell / BB-202501970 | City of Atlanta | March 5, 2025 | Issued | $50,000,000 | New one-level 217,682 sq ft shell at 1740 Thomas Street |
| QTS ATL-DC4 fit-out / BB-202500047 | City of Atlanta | January 3, 2025 | Certificate of occupancy issued | $30,000,000 | Data hall fit-out with four 3 MW pods, as described |
| ATL 088, Rock House Road / Douglas, February 2026 report | Douglas | Not in the issued report | Issued February 4, 2026 | $310,000,000 | New building shell and interior, 414,000 sq ft |
| AWS 071 Building 4, T5 ATL III campus / 2402778 | Douglas | Not in the issued report | Issued August 27, 2026 | $23,333,333 | Shell only, 427,456 sq ft |
| Edged data hall fit-out, Marietta Road / BB-202607320 | City of Atlanta | August 20, 2026 | In review | $44,445,616 | Data hall fit-out of two floors at an existing building. The filing does not state added power in its description |
| 55 Marietta Street office conversions / BB-202606258 BB-202607720 17th floor conversion, filed September 2, 2026, $2,000,000 | City of Atlanta | July 17, 2026 | In review | $16,800,000 | Office floors converted to a data facility |
| Switch NAP04 data hall racking / 2601601 | Douglas | Not in the issued report | Issued July 2, 2026 | $5,000,000 | Area 7 data hall racking, 41,957 sq ft, at 1 Switch Way. No added power stated |
| WSG Land data center, Fairplay Road / SU-2025-005 | Social Circle | June 17, 2025 | Approved September 16, 2025 | Not stated | Annexation, rezoning and special use for a data center |
| WSG Land data center, Mill Road / SU-2025-006 September 16, 2025, council decisions | Social Circle | July 1, 2025 | Mill Road approved September 16, 2025. Cannon Drive annexation denied | Not stated | Rezoning and special use for a data center |
| Hawkins Academy and Roy Malcom roads data center / SU-2025-007 SU-2026-001 1402 Roy Malcom Road added, filed February 9, 2026, approved April 21, 2026 | Social Circle | August 12, 2025 | Approved November 6, 2025 | Not stated | Annexation, rezoning and special use for a data center |
| Dermody data center campus, East Hightower Trail / SU-2025-008 | Social Circle | September 15, 2025 | Approved with conditions November 18, 2025 | Not stated | Special use for a data center campus |
| GA Strouds Creek Land data center campus, Lakewood Drive / SU-2025-009 | Social Circle | September 2025 | Approved November 18, 2025 | Not stated | Annexation, rezoning and special use for a data center campus |
| Sailfish data center campus, Amber Stapp Studdard Road / SU-2024-001 | Social Circle | November 15, 2024 | Approved January 22, 2025 | Not stated | Annexation, rezoning and special use for a data center campus |
| Morgan County data center application / Staff report, August 2026 | Morgan | June 30, 2026 | Incomplete, under the county's moratorium | Not stated | Rezoning for a data center. The record does not name the applicant or site |
| 585 Spalding Investments data center campus / 25-22Z | Spalding | Not on record (first hearing June 24, 2025) | Rezoned October 23, 2025 | Not stated | Data center campus at 50 S McDonough Road |
| Stack Phase 2 (SAC III Acquisitions) / Z2025-47 | Douglas | Not on record (heard May 6, 2025) | Approved May 6, 2025 | Not stated | Data center rezoning and special use, Factory Shoals Road and Linda Lane |
| Stream Winston campus (SDC ATLA) / Z2025-55 | Douglas | Not on record (first hearing June 3, 2025) | Approved July 8, 2025 | Not stated | Data center rezoning and special use. The site's regional filing was in 2024 |
| Amazon Data Services, Strickland Street / RES-2025-43 | Douglasville | Not on record | Height variance approved September 2, 2025 | Not stated | Variance for a data center site of 132.2 acres |
| Big Power Developments 5, Rockhouse Road / S2025-13 | Douglas | Not on record (first listed April 2025) | Denied March 3, 2026 | Not stated | Special use for a data center |
| Stonewall Tell data center rezoning / Z25-002 | South Fulton | Not on record (first council reading, January 14, 2025) | Approved August 12, 2025 | Not stated | City-initiated data center rezoning and special use, Mason Road and Stonewall Tell Road |
| Freeman Investments, Gaines Road / Z-25-00015 | Bartow | Not on record | Approved June 4, 2025 | Not stated | 122 acres rezoned with data center as the only allowed use |
| MMM Acquisitions, 1751 Bells Ferry Road / Z2025-11 | Marietta | Not on record | Approved June 11, 2025 | Not stated | Data center campus with a substation on 31 acres |
| Prime Storage, 1155 Powers Ferry Place / Z2026-12 | Marietta | Not on record (planning commission July 1, 2026) | Approved August 12, 2026 | Not stated | Data infrastructure use in part of an existing building |
| TC Atlanta campus, Veterans Memorial Highway / Z2024-55 | Douglas | 2024 | Approved February 4, 2025 | Not stated | Data center rezoning and special use |
| Project Peach (Weldon Road) / REZ 24-14 CD-26-062 construction drawings, filed September 30, 2026 CD-26-063 offsite sewer drawings, filed September 30, 2026 | Coweta | 2024 | Rezoned April 15, 2025. Construction drawings in review | Not stated | Data center rezoning, 2.1 million sq ft |
| Project Sail, Welcome to Sargent Road / REZ 24-19 | Coweta | December 2024 | Approved April 7, 2026 | Not stated | Data center rezoning on 829 acres |
| PCC-DeKalb, Loveless Place, Ellenwood / SLUP-25-1247635 2025-0970 board history | DeKalb | June 25, 2025 | Special land use permit for utility structures denied 7-0, August 13, 2026 | Not stated | The county staff report says the site plan shows a one million sq ft data center campus with a substation on 95 acres |
| Alcovy Rise, 600 Elks Club Road, Covington / PAR25.0004 | Covington | Not on record (Newton objected October 21, 2025) | Annexation denied January 20, 2026 | Not stated | Annexation of 1,522.68 acres for a data center |
| Hazelbrand Road data center site, Covington / Annexation and M2 zoning | Covington | Not on record | Approved 5-1, January 6, 2025 | Not stated | 95.556 acres annexed and zoned to allow a data center at 10835 Hazelbrand Road |
| CleanSpark data center, 4570 Edison Drive, College Park / CUP, item 9D April 21, 2025, packet staff report and ordinances, 1.98 acres for a data center | College Park | Not on record (planning commission hearing March 31, 2025) | Conditional use and rezoning approved 4-0, April 21, 2025 | Not stated | Conditional use for a data center on 1.98 acres. The applicant stated 36 MW across six units at the hearing |
| TA Realty data center, Red Oak Road, Union City / Items E, F and G, December 16, 2025 | Union City | Not on record (first on the September 2025 agenda) | Approved 2-1, December 16, 2025 | Not stated | Three rezonings to OI totalling 67.786 acres for a data center, four buildings per staff |
| 3600 International Drive, DeKalb / 1248045 | DeKalb | March 6, 2026 | Not accepted under the county's moratorium | Not stated | Land disturbance revision to regrade a studio campus for future data center buildings |
State air permit applications (4)
| Received | Facility and record | Status | What the record states |
|---|---|---|---|
| September 18, 2026 | VoltaGrid ATL-1 EGU, Hazelbrand Road, Covington / 4911-217-0080-S-01-0 | Issued | A new 90 MW natural gas plant of 33 engines. The permit says it will provide prime power to a nearby Serverfarm facility. |
| August 2026 | Amazon Data Services ATL088 Campus, 2341 Echo Road, Lithia Springs / 30292 | Application, comments closed September 25 | To construct and operate a data center. The notice states no generator count. |
| July 2026 | The Keep 2 Campus (Switch), Bates Road, Cartersville / 30076 | Proposed permit, comments closed August 7 | Additional emergency generators at an existing campus. No capacity stated. |
| August 2026 | The Keep 2 Campus (Switch), Bates Road, Cartersville / 30289 | Application, comments closed September 25 | Additional main generators at an existing campus. No capacity stated. |
An air permit covers generators or a power plant, not data center floor space.
Government actions and review milestones (29)
All dates are 2026. A hearing or recommendation is not an approval.
Reported
These projects have been reported, but a decision, a filing or the data center use is still open for each.
- Project Rockforge, Farmer Road, Rockdale County. The Rockdale Citizen reported that commissioners denied it on October 6, after the quarter. The county's minutes are not yet posted.
- Brown Farm Road, Bartow County. The Daily Tribune News reported a planning commission vote against the 111-acre rezoning on August 24. No county record of the vote or a final decision is posted.
- Equinix, 1100 Site Parkway, Hampton. State air permit issued June 30, 2026, for 149 generators. The local building permits are not on public record.
- Amazon ATL089, 11145 Alcovy Road, Covington. State air permit issued June 29, 2026, for 321 generators. The local building permits are not on public record.
- DataBank Boulder Park, Bakers Ferry Road, Atlanta. State air permit issued June 6, 2025, for 74 generators. The building permit is not on public record.
- Amazon land, High Falls Park Road, Lamar County. The Griffin Daily News reported a 984.89-acre rezoning in August 2025. No data center use is on record.
- Amazon Web Services, River Park, Butts County. The Jackson Progress-Argus reported an amended agreement for data centers there in November 2025. Permits and size are not on record.
- Atlas Development, Adairsville. The council approved a development agreement for a possible data center on about 500 acres on July 17, 2025. No site or filing is on record.
- Atlas Development, Stiles Road, Bartow County. The Daily Tribune News reported a 302-acre application withdrawn on December 2, 2025. The county's case record is not posted.
- Microsoft, Highway 74 and Kirkley Road, Tyrone. The Fayette County News reported a 161-acre site approved in 2024 and a May 2026 open house. No building permit is on record.
- Rockdale Technology Park 1, Sigman Road, Rockdale County. Its regional impact filing of February 2024, for 837,500 square feet in three buildings, predates this report. No later filing for the site is on record.
- DC Blox ATL3, Farmer Road, Rockdale County. Its 2024 rezoning and special use predate this report. The county register shows site trailers and a laydown plat but no building application.
Coverage and method
Boundary: the Atlanta-Sandy Springs-Roswell metropolitan statistical area as the federal government defined it in 2023: Barrow, Bartow, Butts, Carroll, Cherokee, Clayton, Cobb, Coweta, Dawson, DeKalb, Douglas, Fayette, Forsyth, Fulton, Gwinnett, Haralson, Heard, Henry, Jasper, Lamar, Meriwether, Morgan, Newton, Paulding, Pickens, Pike, Rockdale, Spalding and Walton counties, with every city in them.
| Authority | Records reviewed | Coverage |
|---|---|---|
| Georgia DCA, developments of regional impact | Every regional impact filing in the 29 counties | Complete for all seven quarters. |
| City of Atlanta | Building and planning records, council legislation | Complete for all seven quarters. |
| Douglas County | Monthly issued-permit reports, board minutes | Board records complete. Permit reports for January to August 2025 are not posted online. |
| Gwinnett, Clayton, Rockdale and Newton counties | Public permit registers, board records | Complete for all seven quarters. |
| Cobb, Cherokee, Coweta, DeKalb, Fayette, Spalding, Bartow and other county boards | Board and planning agendas and minutes | Complete where minutes are posted. Several counties publish no searchable permit register. |
| Cities | Council and planning records in about 60 cities | Partial. Some cities post no minutes, or none for part of the period. |
| Georgia EPD | Air permits and enforcement orders | Complete for issued permits. Weekly application notices read from January 2025, with three issues not posted. |
Full: every relevant local record for the quarter was read in that county. Partial: some authorities in the county publish no searchable permit register, or post scanned or no minutes, so the quarter may be missing a filing. The state register is complete for every county in every quarter.
| Authority | Q1 2025 | Q2 2025 | Q3 2025 | Q4 2025 | Q1 2026 | Q2 2026 | Q3 2026 |
|---|---|---|---|---|---|---|---|
| Barrow | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Bartow | Partial | Full | Partial | Partial | Full | Full | Partial |
| Butts | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Carroll | Full | Full | Full | Full | Full | Full | Full |
| Cherokee | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Clayton | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Cobb | Full | Full | Full | Full | Full | Full | Full |
| Coweta | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Dawson | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| DeKalb | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Douglas | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Fayette | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Forsyth | Full | Full | Full | Full | Full | Full | Full |
| Fulton | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Gwinnett | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Haralson | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Heard | Full | Full | Full | Full | Full | Full | Full |
| Henry | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Jasper | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Lamar | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Meriwether | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Morgan | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Newton | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Paulding | Full | Full | Full | Full | Full | Full | Full |
| Pickens | Full | Full | Full | Full | Full | Full | Full |
| Pike | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Rockdale | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Spalding | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Walton | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
A site is one address or campus, listed in the quarter its record shows a filing to add data center buildings: a regional impact filing, rezoning or other planning application for a new campus, or a permit for a new building. Work inside an existing data center building is listed with the power it states. A filing later withdrawn or terminated is listed in the records but not in the quarterly counts.
Since December 15, 2025, the state register covers data centers above 300,000 square feet or 200 acres in the Atlanta Regional Commission's area and above 500,000 square feet or 200 acres elsewhere, so smaller projects can be missing.
This is not a census of every local permit. A filing does not establish construction, and a permit is never available space.
Sources and revisions
Every figure links to the public record it came from: a regional impact filing, a building permit, a zoning case, a board or council record, or a state permit. News coverage is named as news and never stands in for a record. This edition is final. Its figures change only by a dated correction. A correction will name the record it changes.
Colocation Scout is run by a wholesale and colocation consulting company. The permit data is public and every row links to its filing. How we publish these reports.
Revisions: none yet. Edition status: final.
Cite this report as: Colocation Scout, "Atlanta data center filings, Q3 2026," colocationscout.com/reports/atlanta-data-center-permits-q3-2026.html
