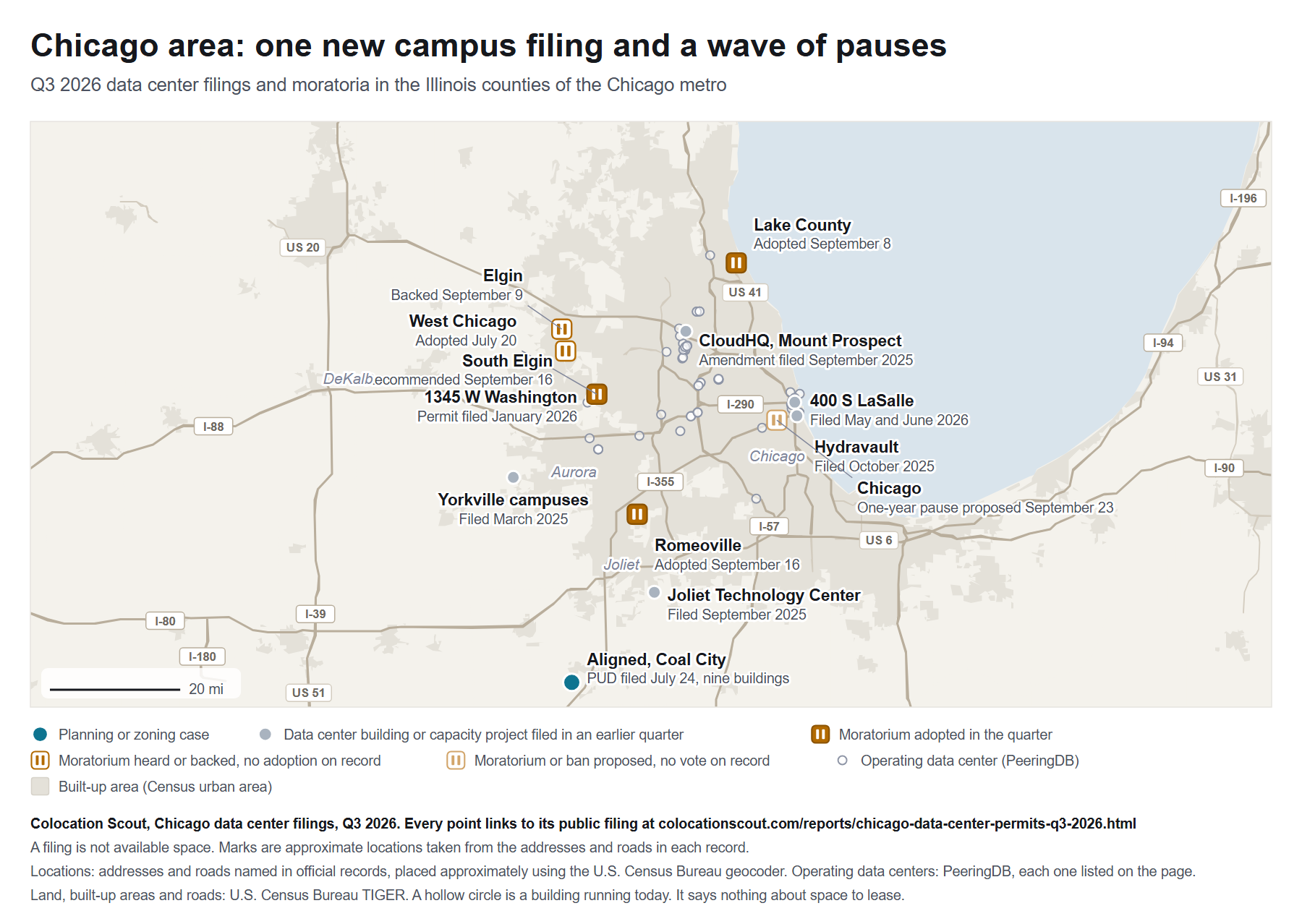

1
new data center site filed in Q3 in the records reviewed, Aligned Data Centers' campus in Coal City. The metro-wide total is unknown.
9
data center buildings, about 3.2 million square feet, in the utility memo filed with the Coal City application. No power figure is stated.
3
local governments adopted data center moratoria in Q3: West Chicago, Lake County and Romeoville. Chicago's mayor proposed a one-year pause, still in committee.
Aligned filed for a nine-building campus in Coal City, the one new data center site in the Q3 records reviewed, while Chicago's mayor proposed a one-year pause and three local governments adopted moratoria.
Operating facilities on the map (68)
The small hollow grey dots are data centers listed in the public PeeringDB facility list, each linked to its record. Listings marked closed are left off. A listed building is in no count on this page.
| Operator | Facility | City | Record |
|---|---|---|---|
| 365 Data Centers | 365 Data Centers Chicago (CH6) | Chicago | peeringdb.com/fac/283 |
| Agile Data Sites | Agile Aurora | Aurora | peeringdb.com/fac/8283 |
| Aligned Data Centers | Aligned Chicago (ORD-01) | Northlake | peeringdb.com/fac/12878 |
| Aligned Data Centers | Aligned Chicago (ORD-02) | Northlake | peeringdb.com/fac/12879 |
| Apotech | Apotech | Mount Prospect | peeringdb.com/fac/15599 |
| Ascent, LLC | Ascent - CH2 | Northlake | peeringdb.com/fac/2770 |
| Centersquare | Centersquare Chicago (ORD1) | Chicago | peeringdb.com/fac/2591 |
| Centersquare | Centersquare Chicago (ORD2) | Elk Grove Village | peeringdb.com/fac/2593 |
| Centersquare | Centersquare Chicago (ORD4) | Lisle | peeringdb.com/fac/6676 |
| CME Group | CME Cermak | Chicago | peeringdb.com/fac/1938 |
| Cogent Communications, Inc. | Cogent Chicago 1 | Chicago | peeringdb.com/fac/10476 |
| Cogent Communications, Inc. | Cogent Chicago 2 | Chicago | peeringdb.com/fac/10477 |
| Cogent Communications, Inc. | Cogent Chicago 3 | Chicago | peeringdb.com/fac/16455 |
| Colocation America Corporation | CDC1 - 350 E Cermak Rd | Chicago | peeringdb.com/fac/3436 |
| Colocation America Corporation | CDC2 - 600 S Federal st | Chicago | peeringdb.com/fac/3437 |
| Colocation America Corporation | CDC3 - 800 E Business Center Dr | Mount Prospect | peeringdb.com/fac/3438 |
| Colocation America Corporation | CDC4 - 1808 Swift Dr | Oak Brook | peeringdb.com/fac/3439 |
| Colocation America Corporation | CDC5 - 2200 Busse Rd | Elk Grove Village | peeringdb.com/fac/3440 |
| ColoCrossing | ColoCrossing CHI1 | Elk Grove Village | peeringdb.com/fac/6428 |
| CoreSite | CoreSite - Chicago (CH1) | Chicago | peeringdb.com/fac/440 |
| CoreSite | CoreSite - Chicago (CH2) | Chicago | peeringdb.com/fac/8868 |
| Crown Castle Inc. | Crown Castle Chicago (725 S Wells) | Chicago | peeringdb.com/fac/3488 |
| CyrusOne Inc. | CyrusOne Aurora I | Aurora | peeringdb.com/fac/3143 |
| CyrusOne Inc. | CyrusOne Chicago (Lombard) | Lombard | peeringdb.com/fac/1486 |
| DataBank, Ltd. | DataBank Chicago (ORD1) | Chicago | peeringdb.com/fac/2956 |
| DataBank, Ltd. | DataBank Chicago (ORD2) | Chicago | peeringdb.com/fac/10918 |
| DataBank, Ltd. | DataBank Chicago (ORD3) | Mount Prospect | peeringdb.com/fac/2960 |
| DataBank, Ltd. | DataBank Chicago (ORD4) | Oak Brook | peeringdb.com/fac/10919 |
| DataBridge Sites | DataBridge Sites Aurora | Aurora | peeringdb.com/fac/11195 |
| Digital Realty | Digital Realty CH1 - Chicago | Elk Grove Village | peeringdb.com/fac/1384 |
| Digital Realty | Digital Realty CH2 - Chicago | Elk Grove | peeringdb.com/fac/8929 |
| Digital Realty | Digital Realty CH3 - Chicago | Elk Grove | peeringdb.com/fac/8930 |
| Digital Realty | Digital Realty CHI (350 E Cermak) | Chicago | peeringdb.com/fac/466 |
| Digital Realty | Digital Realty CHI (505 N Railroad) | Northlake | peeringdb.com/fac/6587 |
| Digital Realty | Digital Realty CHI (600-780 S Federal) | Chicago | peeringdb.com/fac/2924 |
| Digital Realty | Digital Realty CHI (9333 Grand Ave) | Franklin Park | peeringdb.com/fac/12488 |
| Digital Realty | Digital Realty CHI (9355 Grand Ave) | Franklin Park | peeringdb.com/fac/12489 |
| Digital Realty | Digital Realty CHI (9377 Grand Ave) | Franklin Park | peeringdb.com/fac/12490 |
| EdgeConneX Inc. | EdgeConneX Chicago (EDCCHI02) | Elk Grove Village | peeringdb.com/fac/12344 |
| Element Critical, LLC | Element Critical Chicago CH1 | Wood Dale | peeringdb.com/fac/6904 |
| Element Critical, LLC | Element Critical Chicago CH2 | Wood Dale | peeringdb.com/fac/6272 |
| Equinix, Inc. | Equinix CH1/CH2/CH4 - Chicago | Chicago | peeringdb.com/fac/7 |
| Equinix, Inc. | Equinix CH3 - Elk Grove | Elk Grove Village | peeringdb.com/fac/968 |
| Equinix, Inc. | Equinix CH7 - Westmont | Westmont | peeringdb.com/fac/11497 |
| Forsythe Data Centers | Forsythe Data Centers | Elk Grove Village | peeringdb.com/fac/2571 |
| GigeNET | GigeNET CHI3 | Arlington Heights | peeringdb.com/fac/14342 |
| Lincoln Rackhouse | Lincoln Rackhouse Aurora | Aurora | peeringdb.com/fac/6886 |
| Lumen Technologies Inc | Level(3) Chicago (Canal) | Chicago | peeringdb.com/fac/250 |
| Lumen Technologies Inc | Level(3) Chicago (Kingsbury) | Chicago | peeringdb.com/fac/1730 |
| Netrality Data Centers | Netrality Chicago - 717 S Wells | Chicago | peeringdb.com/fac/3398 |
| Netrix LLC | NETRIX - MTP | Mount Prospect | peeringdb.com/fac/2034 |
| Netrix, LLC | NETRIX - ALSIP | Alsip | peeringdb.com/fac/2035 |
| Netrix, LLC | NETRIX - BBN | Bannockburn | peeringdb.com/fac/2036 |
| New York Internet | NYI CH1 (800 Jorie Blvd) | Oak Brook | peeringdb.com/fac/7525 |
| Northwestern University | Northwestern University co-location facility | Chicago | peeringdb.com/fac/1707 |
| Printer's Square | Printer's Square Chicago (600 S Federal) | Chicago | peeringdb.com/fac/184 |
| QTS Realty Trust, Inc. | QTS Chicago (CHI1) | Chicago | peeringdb.com/fac/3362 |
| RagingWire Data Centers - NTT | RagingWire CH1 - NTT | Itasca | peeringdb.com/fac/12160 |
| SBA Edge, LLC | SBA Edge, LLC | Chicago | peeringdb.com/fac/1727 |
| Serverfarm | Serverfarm CH1 Chicago | Chicago | peeringdb.com/fac/5434 |
| Serverfarm | Serverfarm CH2 Oak Brook / Chicago | Oak Brook | peeringdb.com/fac/5438 |
| Stream Data Centers | Stream Data Centers - Chicago I | Elk Grove Village | peeringdb.com/fac/8087 |
| Stream Data Centers | Stream Data Centers - Chicago II | Elk Grove Village | peeringdb.com/fac/10623 |
| T5 Data Centers | T5@Chicago | Elk Grove Village | peeringdb.com/fac/8411 |
| TierPoint, LLC | TierPoint Chicago - Polk | Chicago | peeringdb.com/fac/3014 |
| TierPoint, LLC | TierPoint Chicago - West | Franklin Park | peeringdb.com/fac/2982 |
| tzulo, inc. | tzulo Chicago | Chicago | peeringdb.com/fac/12675 |
| US Signal | US Signal - Oak Brook | Oak Brook | peeringdb.com/fac/2983 |
What happened this quarter
One new site: a nine-building campus in Coal City
One new data center site was filed in the records reviewed for Q3. On July 24 Aligned Data Centers filed a planned unit development application for about 320 acres at Reed and Carbon Hill roads in Coal City, in Grundy County, with an annexation of 5 more acres. A utility memo filed with it describes nine data center buildings of about 3.2 million square feet and a 30-acre ComEd substation. The records state no power figure. The village had approved an annexation agreement and I-1 zoning for 80 acres of the site in February for "a potential data center", and a review committee began meeting in August. No public hearing has been set.
Chicago's mayor proposes a one-year pause
On September 23 Mayor Brandon Johnson introduced an ordinance that would stop city permits and approvals for new or expanded data centers for one year, except projects whose building permit was already issued. It went to committee without a vote. Aldermen introduced a six-month pause on zoning applications, a rule requiring a planned development for every data center and a 40th Ward advisory referendum the same day. The council passed, 50-0, an ordinance bringing buildings with data centers into energy benchmarking. The city's issued-permit records show no new data center building filed in Q3, though applications still in review do not appear there.
West Chicago, Lake County and Romeoville adopt moratoria
West Chicago, Lake County and Romeoville adopted moratoria. West Chicago adopted a 180-day pause on new data centers and battery storage on July 20, and the Lake County Board a pause for unincorporated areas on September 8, running to May 2027. On September 16 Romeoville extended an existing moratorium to data centers for 36 months. South Elgin's board resolved on August 17 that it intends to deny annexation of land for a data center proposed by Whiterose Partners, and its plan commission backed a 12-month moratorium. Elgin's committee of the whole voted 9-0 on September 9 for a 12-month moratorium, according to its draft minutes.
Approved campuses move toward construction
Yorkville's council approved on July 14 an amendment letting CyrusOne build its CHI-11 campus as eight one-story buildings of 1,854,805 square feet. CyrusOne's attorney told the council the substation was under construction, with power expected in 2027 and the first building occupied in early 2028, and the company filed the campus's final plat on September 22. In Mount Prospect the board hired an outside reviewer for five CloudHQ permit applications at a campus approved in 2025 for 345 MW. The state's tax incentive program for data centers stopped processing applications on July 1.
Aligned Data Centers, Coal City campus
- Project
- Aligned Data Centers campus, called Project Heartland in the utility memo
- Location
- Southeast corner of East Reed Road and South Carbon Hill Road, Coal City, Grundy County. The narrative gives about 320 acres and the application form about 307.
- Applicant of record
- Aligned Data Centers (Coal City) PropCo, LLC, the contract purchaser, through Kimley-Horn and Associates
- What is being built
- "Proposed Data Center Development", in the application's words. The utility memo describes nine data center buildings, six of 323,000 square feet and three of 428,500, and the narrative a 30-acre ComEd substation lot.
- Floor area
- 3,223,500 square feet in nine buildings, from the utility memo. At the July 27 planning board meeting the chair described five two-story buildings.
- Power
- The records state no power figure.
- Estimated cost, as filed
- Not stated
- Filing type and status
- Planned unit development application ZA26-0015 and annexation and rezoning application ZA26-0016. A review committee appointed on July 28 began meeting on August 18. No hearing date is set.
- Date filed
- July 24, 2026, the filing date the village wrote on both applications
- Earlier record
- In February the village approved an annexation agreement and I-1 zoning for 80 acres of the site, on an application filed January 26 for "a potential data center".
Sites filing to add data center capacity, by quarter
A site counts once in a quarter however many permits it files. Building permits were searched in Chicago only, and several suburban cases do not state a filing date, so a quarter can be missing a site. The bars count what the public records show.
Earlier quarters, from the records we have
These counts come from the records we could search for each quarter. Some sources only start partway through, so read them as what the records show, not as a trend.
| Quarter | Chicago area: sites filing to add capacity |
|---|---|
| Q2 2026 | 1 |
| Q1 2026 | 2 |
| Q4 2025 | 1 |
| Q3 2025 | 4 |
| Q2 2025 | 0 |
| Q1 2025 | 2 |
Filings and decisions by quarter
Dates are the filing dates on each authority's own record. Joliet's is the date on the petition pages.
What to watch next
- November 4, 2026. Yorkville's Economic Development Committee is set to review CyrusOne's CHI-11 final plat, with the planning commission on November 12 and the council on November 24. All three dates are tentative. Published record.
- January 16, 2027. West Chicago's 180-day moratorium on new data centers and battery storage is set to expire. Published record.
- May 11, 2027. Lake County's moratorium on data centers in unincorporated areas is set to expire. Published record.
The records behind the findings
Data center projects with a record in the seven quarters, Q1 2025 to Q3 2026 (25)
| Site and records | Authority | First filed | Permit first issued | Declared value | Scope |
|---|---|---|---|---|---|
| Aligned Data Centers, Coal City / ZA26-0015 ZA26-0016 5-acre annexation, filed July 24, 2026 ZA26-0001 80 acres rezoned for a potential data center, filed January 26, 2026, adopted February 24, 2026 | Coal City | January 26, 2026 (80 acres). Campus application July 24, 2026 | In review, no hearing set | Not stated | Nine data center buildings, 3,223,500 sq ft, on about 320 acres |
| 400 S LaSalle office conversion / 101081181 101084518 Phase 3, filed June 17, 2026 | Chicago | May 8, 2026 | Phase 2 issued July 6, 2026, phase 3 issued September 16, 2026 | $51,100,000 and $151,112,046 | Converts a seven-story office building to a data center |
| Data center, 1345 W Washington St / Building permit | West Chicago | January 6, 2026 | Issued May 12, 2026 | Not stated | Data center building, permitted use, under construction |
| Hydravault, 2538 S Wabash Ave / 101074646 | Chicago | October 13, 2025 | Issued February 13, 2026 | $18,000,000 | Two-story addition for a new data center |
| Joliet Technology Center / A-4-25, PUD-8-25 PUD-8-25 Scope of development Ord. 18826, 18827 Council approval, March 19, 2026 | Joliet | Petition dated September 8, 2025 | Approved March 19, 2026, 8-1 | Not stated | 24 data center buildings, 6,936,000 sq ft, on 795 acres |
| CloudHQ Mount Prospect campus amendment / PZ-21-25 Plan review Five permit applications under review, July 2026 | Mount Prospect | September 3, 2025 | Approved October 28, 2025 (Ordinance 6811), 5-0 | Not stated | Two buildings of 2,172,000 sq ft and 345 MW in place of three of 84 MW |
| CyrusOne Phase 2, Beecher Road / Petition page | Yorkville | August 22, 2025 | Withdrawn April 17, 2026 | Not stated | Three buildings, about 740,000 sq ft, on 128 acres |
| Meyer rezoning / Petition page | Yorkville | July 11, 2025 | Withdrawn April 14, 2026 | Not stated | About 91 acres rezoned for a future data center campus |
| Project Cardinal / Petition page | Yorkville | March 21, 2025 | Approved, final ordinances March 10, 2026 | Not stated | 14 data center buildings, over 17 million sq ft, on 1,037 acres |
| Project Steel / Petition page | Yorkville | March 14, 2025 | Approved March 24, 2026, 6-1 | Not stated | Filed as 18 data center buildings over 9 million sq ft, revised to 16, on 540 acres |
| CyrusOne CHI-11 campus / PZC 2026-12 Ord. 2026-50 Amendment, July 14, 2026 | Yorkville | Not stated. Amendment filed April 21, 2026, final plat September 22, 2026 | Amendment approved July 14, 2026, 7-0 | Not stated | Eight one-story buildings, 1,854,805 sq ft, on 228.93 acres |
| DMYF-Loftus rezoning / Ord. 2025-34 | Yorkville | December 13, 2024 | Approved April 8, 2025 | Not stated | 53.7 acres rezoned for a future data center |
| Equinix Minooka campus / Case 2025-5 | Minooka | Not stated | Approved September 23, 2025 | Not stated | Seven data center buildings, four hyperscale and three colocation, on about 368 acres |
| NTT CH5, Itasca / Ord. 2178-26 | Itasca | Not stated | Approved May 5, 2026, 5-0 | Not stated | Data center site plan, Marino Court |
| CyrusOne Bryn Mawr Phase III, Wood Dale / CDC-2024-0007 Council Approval, January 16, 2025 | Wood Dale | Not stated | Approved January 16, 2025, 7-0 | Not stated | Four data center buildings, 996,850 sq ft, on 42 acres |
| Karis Critical, 1960 Lucent Lane / Conditional use Council Denial, January 20, 2026 | Naperville | Not stated | Denied January 20, 2026, 6-1 | Not stated | One data center building of 211,160 sq ft on about 20 acres |
| EdgeConneX, 901 Busse Road / B25-1159 Res. 35-26 Class 6B letter, May 12, 2026 | Elk Grove Village | Not stated (2025 permit series) | Issued April 16, 2026 | $150,000,000 | New data center building. The village incentive resolution states 163,593 sq ft and 30 MW |
| Stream Data Centers, 2000 Landmeier Road / B24-1347 Res. 61-25 Campus resubdivision, November 18, 2025 | Elk Grove Village | Not stated (2024 permit series) | Issued April 29, 2026 | $232,000,000 | New data building on the campus |
| Prime Data Centers, 1550-1650 E Higgins Road / Ord. 3904 | Elk Grove Village | Not stated | Approved June 17, 2025, 6-0 | Not stated | Resubdivision into three lots for a three-building campus |
| Data halls, Higgins Road campus / B24-0494, B24-0932 B24-0494 First data hall | Elk Grove Village | Not stated (2024 permit series) | B24-0494 issued July 15, 2025, B24-0932 issued June 22, 2026 | $75,000,000 and $87,000,000 | Two new three-story data halls with generator buildings. The permit rows name no operator |
| Compass Datacenters, 3333 Beverly Road / PLN24-0011 Ord. 5152-2025 Board approval | Hoffman Estates | Not stated (2024 case) | Approved February 17, 2025 | Not stated | Five buildings, 1.25 million sq ft, on 193 acres |
| Project Vector, Edged / Ord. 2025-050 to 2025-052 Council Approval, December 8, 2025 | DeKalb | Not stated | Approved December 8, 2025 | Not stated | Four data center buildings on about 560 acres |
| Donato Solar, Peace Road / Ord. 2025-039 Council Vote, September 8, 2025 | DeKalb | Not stated | Annexation agreement failed September 8, 2025, 2-5 | Not stated | Two data center buildings of 6,000 sq ft with a solar field |
| Batavia data center, Hut 8, 1780 Hubbard Ave / Res. 2025-082-R Res. 2025-082-R Utility agreement | Batavia | Not stated | Utility agreement approved July 21, 2025. No building permit on record | Not stated | About 120,000 sq ft, about 20 MW at first and up to 50 MW |
| Cloud Centers, 711 Ogden Ave / PUD application | Lisle | Not stated | Heard January 21, 2026, did not proceed | Not stated | About 50 MW data center on 18.5 acres |
State air permit applications (2)
| Date | Facility and record | Status | What the record states |
|---|---|---|---|
| August 14, 2025 | Aligned Data Centers, 50 and 150 Northwest Point Blvd, Elk Grove Village / 24050021 | Issued | 112 emergency generators of 3,000 kWe at a proposed data center, applied for May 31, 2024. |
| July 9, 2026 | Equinix, 17450 Ridge Road, Minooka / 25110011 | Final permit on file | Final air permit for the Minooka campus. |
An air permit covers backup generators, not data center capacity, and Illinois publishes an application only at public notice or decision.
Government actions and review milestones (10)
A hearing, motion or recommendation is not an adoption. A proposal in committee has not been voted on.
Reported
These projects have been reported or appear in public records, but a filing date, scope or status is still open for each.
- QTS second building, 2800 S Ashland Ave, Chicago. Chicago approved a second QTS building of about 366,000 square feet of data center space in 2024. Support permits filed in Q3 refer to construction permit 101075283, whose filing date and status the city's issued-permit records do not show.
- Metro Edge, 1951 W Hastings St, Chicago. A Class 6(b) ordinance introduced on May 20, 2026, describes a planned 324,600 square foot data center. A building permit filing is not on record.
- CloudHQ permit applications, Mount Prospect. Five permit applications were under review in July. Their numbers, dates and scope are not published.
- CyrusOne Building 2 and Phase II, Wood Dale. Three data center buildings on about 66 acres, noticed for hearing in August 2025. No hearing has been held.
- Western Hospitality Partners, Braidwood. Braidwood adopted a TIF inducement resolution for a data center proposed by Western Hospitality Partners in November 2025. In February 2026 the city reported the project on indefinite hold. No annexation or zoning filing is on record.
- ILLCO Grundy County (Tract), Morris. Morris approved agreement amendments and a utility agreement with ILLCO Grundy County, care of Tract Capital Management, for about 344 acres on August 18, 2025. Tract has announced a data center campus there. The agreements name no data center use, and no zoning application is on record.
- Whiterose Partners, 33W304 Kenyon Road, South Elgin. A concept plan for a 200,000 square foot data center with a 48 MW request to ComEd. Its filing date falls between June 19 and July 15, 2026, and is not stated.
Coverage and method
Boundary: the nine Illinois counties of the Chicago-Naperville-Elgin metro area as the federal government defined it in July 2023: Cook, DeKalb, DuPage, Grundy, Kane, Kendall, Lake, McHenry and Will. The metro's four Indiana counties are covered by this site's Indiana reporting, not here.
| Authority | Records reviewed | Coverage |
|---|---|---|
| City of Chicago | Issued building permits, zoning and planned development cases, City Council legislation | All seven quarters. Q3 2026 building permits show issued permits only. |
| Suburban Cook County | Board, plan commission and zoning records | 18 authorities. Melrose Park and Stone Park publish no records. |
| DuPage, Lake and McHenry counties, and Aurora | Board, plan commission and zoning records | 30 authorities. |
| Kane, Kendall and DeKalb counties | Board, plan commission and zoning records | 34 authorities. |
| Will and Grundy counties | Board, plan commission and zoning records | 28 authorities. Several small villages publish no records. |
| Illinois EPA | Air permits for data center generators | Applications appear only at public notice or decision. |
Full: every relevant record for the quarter was read. Partial: some records are not published or could not be read, so the quarter may be missing a filing or a decision. Gap: no record for the quarter could be read.
| Authority | Q1 2025 | Q2 2025 | Q3 2025 | Q4 2025 | Q1 2026 | Q2 2026 | Q3 2026 |
|---|---|---|---|---|---|---|---|
| Arlington Heights, Aurora, Bartlett, Bensenville, Bolingbrook, Carol Stream, Channahon, Chicago City Council, Chicago zoning and planned developments, Coal City, Cook County Board of Commissioners, Cook County Zoning Board of Appeals and Department of Building and Zoning, Cortland, Crest Hill, Crystal Lake, DeKalb, DeKalb County, Diamond, DuPage County, Elburn, Elgin, Elk Grove Village, Elwood, Frankfort, Franklin Park, Geneva, Genoa, Gilberts, Grundy County, Hampshire, Harvard, Hinckley, Hoffman Estates, Itasca, Joliet, Kendall County, Lake County, Lisle, Lockport, Lombard, Malta, Mazon, McHenry County, Minooka, Monee, Montgomery, Mount Prospect, Mundelein, Naperville, New Lenox, North Chicago, Oak Brook, Oswego, Pingree Grove, Plainfield, Plano, Rolling Meadows, Romeoville, Sandwich, Schaumburg, Schiller Park, Seneca, Shabbona, St. Charles, Sycamore, Volo, Waterman, West Chicago, Westmont, Wheeling, Will County, Wood Dale, Woodstock, Yorkville | Full | Full | Full | Full | Full | Full | Full |
| Addison, Downers Grove, Elmhurst, Huntley, Kirkland, Lisbon, Millbrook, Mokena, Newark, North Aurora, Plattville, Shorewood, University Park, Waukegan, Wilmington | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Chicago building permits, Des Plaines, Illinois EPA air permits | Full | Full | Full | Full | Full | Full | Partial |
| Melrose Park, Stone Park | Gap | Gap | Gap | Gap | Gap | Gap | Gap |
| Big Rock, Morris | Full | Full | Full | Full | Partial | Partial | Partial |
| Northlake | Full | Full | Partial | Partial | Full | Full | Full |
| Grayslake | Gap | Gap | Gap | Full | Full | Full | Full |
| Lakewood | Full | Full | Full | Full | Gap | Gap | Gap |
| Kane County | Full | Partial | Partial | Partial | Full | Full | Partial |
| Batavia | Partial | Partial | Partial | Full | Full | Full | Full |
| South Elgin | Full | Full | Partial | Partial | Partial | Partial | Full |
| Sugar Grove | Full | Partial | Partial | Partial | Partial | Partial | Full |
| Manhattan | Partial | Partial | Partial | Partial | Full | Full | Full |
| Gardner | Full | Partial | Full | Full | Partial | Full | Full |
| Braidwood | Partial | Partial | Partial | Partial | Full | Full | Partial |
| Braceville | Partial | Full | Full | Full | Full | Full | Partial |
| Carbon Hill | Full | Full | Partial | Full | Full | Full | Partial |
A site is one address or one campus, listed in the quarter its own record shows a filing to add data center buildings or power: an annexation, rezoning or planned development for a new site, a building permit for a new building, or an amendment that states more buildings or power.
Most suburbs publish no searchable building permits, so a new building filed with a suburb can be missing until a board record names it. Cities and villages not named in the matrix were not searched, so their activity is unknown.
Sources and revisions
Every figure links to the public record it came from: a building permit, a zoning or planned development case, a council or board record, or a state air permit. News coverage is named as news and never stands in for a record.
This edition is final. Its figures change only by a dated correction. A correction will name the record it changes.
Colocation Scout is run by a wholesale and colocation consulting company. The permit data is public and every row links to its filing. How we verify.
Revisions: none yet.
