5
sites filed for new data center buildings in Q3 in the county records reviewed, in Hanover, Chesterfield, Henrico, Goochland and Dinwiddie. The Richmond-area total is unknown.
900 MW each
the load two Q3 campus applications, in Goochland and Dinwiddie, each say they could reach. Neither county has accepted either application as complete.
2
county boards adopted new rules or positions on large projects in Q3. Dinwiddie adopted siting rules for facilities of 100 MW or more, citing state law, and New Kent stated a strong preference that no new data center applications be filed while it writes rules.
Google, Iron Mountain and a Hanover landowner filed for new buildings and Tract affiliates for two campuses of up to 900 MW, while counties around Richmond moved to slow new projects.

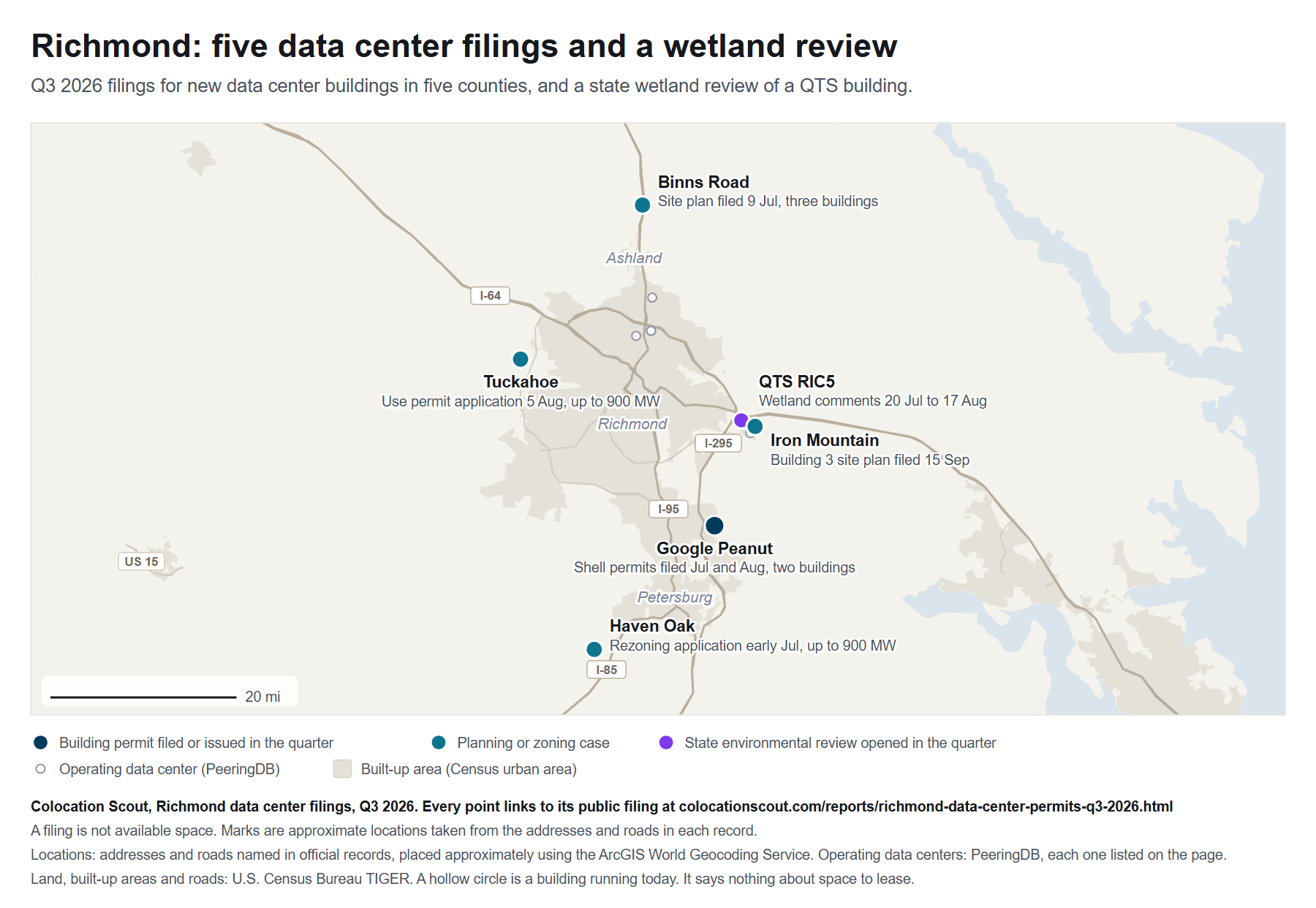

Operating facilities on the map (6)
The small hollow grey dots are data centers listed in the public PeeringDB facility list, each linked to its record. Listings marked closed are left off. A listed building is in no count on this page.
| Operator | Facility | City | Record |
|---|---|---|---|
| EdgeConneX Inc. | EdgeConneX Richmond (EDCRIC01) | Richmond | peeringdb.com/fac/2075 |
| Flexential Corp. | Flexential - Richmond (RIC01/02) | Richmond | peeringdb.com/fac/5008 |
| Hosted Backbone, LLC | Hosted Backbone Richmond1 | Richmond | peeringdb.com/fac/3672 |
| Pixel Factory Data Center | Pixel Factory Data Center | Ashland | peeringdb.com/fac/2071 |
| QTS Realty Trust, Inc. | QTS Richmond - (RIC5) | Sandston | peeringdb.com/fac/16565 |
| QTS Realty Trust, Inc. | QTS Richmond (RIC1) | Sandston | peeringdb.com/fac/2365 |
What happened this quarter
Five sites filed for new data center buildings
Five sites filed for new data center buildings in the county records reviewed for Q3. Google filed permits on 17 July and 14 August for the shells of the second and third buildings at its Project Peanut campus in Chester. Iron Mountain filed a site plan on 15 September for the third building of its approved White Oak campus in Henrico. In Hanover, a site plan filed on 9 July proposes three buildings totalling 396,000 square feet on Binns Road near Doswell. Tract affiliates filed two campus applications that each describe up to 900 MW, in Goochland and Dinwiddie. Separately, QTS sought wetland approval for Data Center Building 5 on its existing RIC5 campus in Henrico.
Tract's two campuses await county acceptance
The applicants describe themselves as affiliates of Tract Capital Management, and their applications cover about 867 acres off Route 288 in Goochland and about 987 acres on White Oak Road in Dinwiddie. Goochland received a conditional use application on 5 August, largely inside the technology overlay district it adopted in November 2025, and its 20 August letter listed 21 items still needed, including the applicant's correct legal name. Dinwiddie received a rezoning application over the 4 July weekend. Neither county had accepted its application as complete, so neither has a hearing date.
Hanover is reviewing a by-right plan while it drafts limits
Binns Road rests mainly on industrial land where data processing is allowed by right, and county planners told the applicant that nothing for the data center may sit on the 14-acre agricultural parcel inside its boundary. Hanover began drafting data center rules on 12 June. On 24 September staff proposed that data centers over 20,000 square feet need a conditional use permit, and their slide said one site plan already under review would need one under that approach, with grandfathering undecided. The slide does not name the plan. On 20 August the Planning Commission voted 5 to 2, according to draft minutes, to recommend the Iron Horse rezoning near Ashland.
Counties and the state moved to slow new projects
Two county boards adopted new rules or positions on large projects. New Kent's supervisors on 13 July dropped a proposed technology overlay district and stated a strong preference that no new data center use permit applications be filed while the county writes standards. Dinwiddie's supervisors on 21 July required a sound assessment, a review of effects on resources and a description of substations and transmission voltage with any rezoning or permit for a facility needing 100 MW or more, citing state law. A 26 August staff update told Chesterfield's supervisors, who have required a conditional use permit for new data centers since January, that they had indicated they would not support more. On 18 September Executive Order 22 ended state site-readiness and expedited-review help for new projects expected to draw 25 MW or more.
The quarter's filings
| Site | Square feet | Estimated cost, as filed | Power, as filed |
|---|---|---|---|
| Google Project Peanut, Buildings 2 and 3Chester, Chesterfield County. 2 buildings | TBA | $192,519,145 | TBA |
| Binns Road Data CentersDoswell, Hanover County. 3 buildings | 396,000 | TBA | TBA |
| Iron Mountain White Oak, Building 3Sandston, Henrico County. 1 building | TBA | TBA | TBA |
| Tuckahoe Technology ParkGoochland County. Building count not stated | Up to about 3,000,000* | TBA | Up to 900 MW utility load |
| Haven Oak Technology ParkDinwiddie County. Building count not stated | TBA | TBA | Up to 900 MW gross load |
| Total, 5 sites | 396,000 (1 of 5 sites)* | $192,519,145 (1 of 5 sites) | Not added |
TBA marks a figure the record does not state yet. Estimated cost, as filed, is the filers' own unverified figure, not total project spend. Power is quoted as each application words it, utility load for Tuckahoe and gross load for Haven Oak, so the two are not added. *Tuckahoe's narrative limits floor area to about 3 million square feet, a cap rather than a building plan, so it is not added.
Sites filing to add data center capacity, by quarter
Filings and decisions by quarter
Chesterfield dates are the day its portal opened the record.
What to watch next
- 28 October 2026. The Iron Horse applicant asked Hanover's Board of Supervisors to hear its rezoning on this date. Published record.
- November 2026. Hanover's committee is scheduled to review draft data center ordinance changes, with a 45-day public comment period planned for January 2027. Published record.
- By 17 March 2027. Executive Order 22's deadline for DEQ recommendations on backup generators, a cooling-water rulemaking timeline and a noise-rule workplan. Published record.
The records behind the findings
The quarter's filings, in detail (5)
Google Project Peanut, Buildings 2 and 3
- Location
- 2600 Bermuda Hundred Road (Building 2) and 2200 Bermuda Hundred Road (Data Center 3), Chester, Chesterfield County. The shell permit for the campus's first building, filed in December 2025, shows as issued.
- Owner of record
- Peanut LLC. A county staff presentation to supervisors on 26 August 2026 names Google as owner and operator.
- Work, as filed
- Building 2: “Cold shell building including the primary structural frame, exterior precast enclosure and roof ... with no occupancy.” Data Center 3: “Includes the primary structural frame, exterior precast enclosure and roof ... No occupancy is requested at this stage.” Building 2's own permit does not say data center. Its chilled water permit is “to serve the data center cooling operations. Peanut Building #2”.
- Estimated cost, as filed
- $95,780,669 (Building 2) and $96,738,475.69 (Data Center 3)
- Filing and status
- Two new-construction building permits for building shells, filed 17 July and 14 August 2026. Building 2's is issued. Data Center 3's was returned for corrections. Foundation permits for both were filed in April and June 2026. No permit states square footage or power.
- Records
- 20260717-026, 20260814-094, foundations 20260417-054 and 20260601-023, site plan 25PR1323
Binns Road Data Centers
- Location
- Binns Road near Doswell, Hanover County. Parcels 7882-47-6634, 7882-48-6475, 7882-58-3767 and 7883-50-0062.
- Owner of record
- 7883 Binns Rd, LLC owns all four parcels in county parcel records. The application form names no company.
- Work, as filed
- “Three data center buildings”, with generator yards and guard shacks
- Size
- 396,000 square feet proposed. 105.42 gross acres, 38 acres in the project.
- Zoning
- About 91 acres are zoned M-3 industrial, where data processing is allowed by right, and 14 acres A-1 agricultural. The county's first review says no improvement for the data center use may sit on the A-1 parcel and asks for the parcels to be combined.
- Filing and status
- Site plan, filed 9 July 2026, in review. A 26 August staff meeting listed a second access drive for Building 3, water-flow testing and wetlands review, and DEQ approval before site plan approval. The county has not approved the plan. The application states no power figure.
- Records
- SPR2026-00035, application form
Iron Mountain White Oak, Building 3
- Location
- 6110 Technology Creek Drive, Sandston, in White Oak Technology Park, Henrico County
- Operator
- Iron Mountain. The plan is part of the IMDC master plan, and the state air permit for this address is issued to Iron Mountain Information Management, LLC.
- Work, as filed
- “Proposed development of Building 3 as part of the overall IMDC RCH1 and Master Plan.” The master plan provides for three two-story data centers totalling about 1,189,285 square feet and a substation.
- Backup generators
- Four 1,500 kW and 126 3,000 kW emergency generators, under the state air permit approved on 7 May 2026
- Filing and status
- Minor site plan, submitted 15 September 2026. The county's approval steps were completed on 9 October 2026, after the quarter.
- Record
- POD-2026-102079
Tuckahoe Technology Park
- Location
- Bounded by Hockett Road, Route 288 and Patterson Avenue, in Goochland's Technology Overlay District. Addresses 44 Cobblestone Circle and 70 Fleetwood Lane.
- Applicant
- VALCO2 Goochland County, LLC, which the applicant's revised pre-application narrative describes as an affiliate of Tract Capital Management
- Work, as filed
- “a data center campus on approximately 867 acres”
- Size
- The 31 August revised pre-application narrative limits floor area to “approximately 3 million square feet”. It states no building count.
- Power, as filed
- “up to 900 MW of utility load across multiple buildings and phases” (narrative)
- Filing and status
- Conditional use permit application, submitted 5 August 2026. The county's 20 August letter lists 21 items it needs before it can formally accept the application, including changing the applicant's name from VALCO to VALCO2, and suggests a new pre-application. The applicant revised its June pre-application on 31 August.
- Record
- CU-2026-00014
Haven Oak Technology Park
- Location
- About 986.9 acres north of White Oak Road at its intersection with Claiborne Road, Dinwiddie County
- Applicants
- VALCO Dinwiddie County, LLC and VALCO Dinwiddie County Two, LLC, the contract purchaser, which the narrative describes as an affiliate of Tract Capital Management
- Work, as filed
- Comprehensive plan amendment, rezoning to the Emerging Technologies district, and a conditional use permit. The revised narrative shows eight data center buildings “for illustrative purposes”.
- Power, as filed
- “up to 900 MW of gross load across multiple buildings and phases”
- Filing and status
- Application dated 1 July 2026. The county “received the application over the July 4th weekend” and had not yet accepted it, according to Board minutes of 18 August. A revised narrative dated 28 August followed.
- Record
- Application
Every data center project with a dated record, Q1 2025 to Q3 2026 (28)
| Site and records | Authority | First filed | Permit first issued | Declared value | Scope |
|---|---|---|---|---|---|
| Google Project Peanut / 25PR1323 20251218-001 Hall 1 shell 20260717-026 Building 2 shell 20260814-094 Data Center 3 shell 26PR2070 Peanut HUB site plan, March 2026 | Chesterfield | 2025-11-09 | Building 1 and 2 shells issued, Data Center 3 in corrections | Hall 1 $55,368,271, Building 2 $95,780,669, Data Center 3 $96,738,476 | Three data center buildings |
| Binns Road Data Centers / SPR2026-00035 | Hanover | 2026-07-09 | None. In review | Not stated | Site plan, three buildings, 396,000 sq ft |
| Iron Mountain White Oak / POD-2025-100752 POD-2025-102428 Building 2 POD-2026-102079 Building 3 POD-2025-101402 RCH4 plan, June 2025, withdrawn BLD-2026-103238 Building permit, February 2026 | Henrico | 2025-03-31 | Master plan approved June 2025, Building 3 in October 2026 | Not stated | Three data centers, 1.19 million sq ft |
| Tuckahoe Technology Park / CU-2026-00014 | Goochland | 2026-08-05 | None. Not accepted as complete | Not stated | Use permit, 867 acres, up to 900 MW |
| Haven Oak Technology Park / application | Dinwiddie | Early July 2026 | None. Not accepted as complete | Not stated | Rezoning, 987 acres, up to 900 MW |
| QTS RIC5 / POD-2024-102383 POD-2025-101688 two buildings POD-2026-100070 phase 2 POD-2026-100248 construction plan BLD-2026-119821 DC1 fit-out 2026-09-09. No added power stated | Henrico | 2024-11-01 | Master plan approved 2025-02-26 | Not stated | Seven data centers, 4.1 million sq ft |
| QTS RIC4 / POD-2024-102609 POD-2025-102186 phase 1 POD-2026-100990 buildings 1 to 3 BLD-2026-121202 DC2 fit-out 2026-09-25. No added power stated | Henrico | 2024-12-06 | Master plan approved 2025-02-26 | Not stated | Ten data centers, 3.8 million sq ft |
| Meta Project Tropical / POD-2025-102510 BLD-2026-108165 Building 1 shell BLD-2026-115185 Building 1 fit-out BLD-2026-115264 Building 2 fit-out, four data halls each 2026-07-08. No added power stated | Henrico | 2025-10-10 | Approved 2025-11-19. Building 1 shell issued 2026-10-12 | Not stated | Two data centers, 767,580 sq ft |
| DC Blox Richmond / POD-2025-100199 BLD-2026-119492 data hall build-out 2026-09-08. No added power stated BLD-2025-111018 Building permit, May 2025 | Henrico | 2025-02-06 | Approved 2025-04-23 | Not stated | One data center, 66,000 sq ft |
| Airport West Data Center Campus / POD-2025-101009 PUP-2025-101460 withdrawn | Henrico | 2025-04-28 | Withdrawn 2026-03-23 | Not stated | Seven data centers, 1.6 million sq ft |
| Chirisa CTP-03 / 25PR1033, 25PR1203 20250723-027 building permit | Chesterfield | 2025-01-31 | Site plan approved 2025-09-11. Permit issued | $39,550,463 | One data center, 138,884 sq ft |
| Chirisa Digital Drive / 25PR1335 20260114-081 building permit | Chesterfield | 2025-12-01 | Site plan approved 2026-06-10. Permit issued | $72,540,051 | First building, 211,000 sq ft |
| Upper Magnolia Green West, Skye / 25SN1038 decision | Chesterfield | 2025-02-05 | Rezoning approved 2025-05-28 | Not stated | Rezoning for data centers, 979 acres |
| Watkins Centre South, Loch / 25SN1040 decision | Chesterfield | 2025-02-05 | Rezoning approved 2025-05-28 | Not stated | Rezoning for data centers, 350 acres |
| Branders Bridge Road / 24SN1308 withdrawal | Chesterfield | 2024-11-05 | Withdrawn 2025-06-18 | Not stated | Rezoning, 741 acres |
| Tradeport 95 / 25PR1325 | Chesterfield | 2025-11-14 | None. Use permit required, per the county | Not stated | Grading for a proposed data center |
| Old Bermuda Data Center / 24PR1100 appeal | Chesterfield | 2024-04-12 | None. Use permit required. Appeal denied 2026-06-03 | Not stated | Site plan, three buildings |
| Iron Horse / REZ2025-00010 | Hanover | 2025-03-27 | Recommended 2026-08-20 in draft minutes. Board vote pending | Not stated | Rezoning, 78 acres |
| Old Ridge Road / REZ2025-00014 | Hanover | 2025-06-30 | Withdrawn 2026-05-14 | Not stated | Rezoning and permits |
| Hunting Hawk Technology Park / REZ2025-00020 | Hanover | 2025-08-22 | Withdrawn 2026-01-28 | Not stated | Rezoning, 238 acres |
| Mountain Road Technology Park / REZ2025-00023 | Hanover | 2025-09-26 | Denied 2026-05-27 | Not stated | Rezoning, 427 acres |
| Page Road campus, Newport Equities / 25-11-REZ-C approval | Powhatan | 2025-07-29 | Approved 2025-10-27 | Not stated | 61.8-acre rezoning for data center development |
| Roxbury Technology Park / RZ-01-2025-C withdrawal EDA minutes Application before the county by 2 January 2025 | Charles City | Before 2025 | Withdrawn by 2025-08-26 | Not stated | Rezoning, 515 acres |
| Collier Yard / 2025-REZ-03 expansion | Petersburg | 2025-02-25 | Approved 2025-04-15, expanded 2026-02-17 | Not stated | 173-acre rezoning for a data center campus |
| Project 460 / SUP 2025-02 Staff report Application submitted 22 August 2025 Board packet Permit described as approved, December 2025 | Sussex | 2025-08-22 | Use permit approved, late 2025 | Not stated | Data center park, about 2,015 acres |
| PointOne Richmond / Site plan | Charles City | 2025-09-10 | None. In review | Not stated | Six buildings, about 2.47 million sq ft of footprint |
| Oppidan Data Center / Site plan BC2025-00442 Building permit, October 2025 | Ashland | 2025-01 | Site plan approved September 2025 | Not stated | Data center, 12166 Washington Hwy |
| Wagner Road Data Center / Site plan PC packet Site plan submitted before 2025 | Petersburg | Before 2025 | Site plan approved, Q2 2026 | Not stated | Data center, 1161 Wagner Road |
State air permit applications (3)
| Received | Facility and record | Status | What the record states |
|---|---|---|---|
| 2026-03-02 | QTS Richmond Data Center / 51232-18 | In engineering review | Minor new source review. The state permit search lists Quality Investment Properties Richmond LLC. No capacity stated. |
| 2026-03-19 | Iron Mountain, 6110 Technology Creek Drive / 53266-1 | Approved 2026-05-07 | Application dated 19 March, complete 26 March. Four 1,500 kW and 126 3,000 kW emergency generators for a data center. |
| 2026-09-24 | QTS Richmond Data Center / 51232-19 | Review started 2026-09-24 | Minor new source review. No building or capacity stated. |
An air permit covers backup generators, not data center capacity.
Government actions and review milestones (10)
A meeting, comment period or recommendation is not an approval.
Reported
These projects have been reported, but a filing date, status or scope is still open for each.
- Google Project Skye, Moseley Road, Chesterfield. Rezoned for data centers in May 2025, and the county names Google as owner and operator. A filing date for data center buildings is still open.
- Google Project Loch, Watkins Centre Parkway, Chesterfield. Rezoned for data centers in May 2025, and the county names Google as owner and operator. A filing date for data center buildings is still open.
- Chirisa Technology Park, Chesterfield. The county's July 2026 data center table lists one building under construction at CTP-02 to CTP-04 without naming it.
- Hanover Technology Park, Hickory Hill Road. Rezoned for data centers in March 2024. A filing date for data center buildings is still open.
- Petersburg data center projects, County Drive and Jamestown Drive. The city's project map lists both as approved data center projects. Their filing dates are not on it.
- Iron Mountain RCH4, Elko Tract Road, Henrico. The state received Iron Mountain's wetland application for IMDC RICH4 on 17 September 2026. The county's 2025 plan for RCH4 was withdrawn, and a filing date for a new one is still open.
- C5, LLC, Charles City. The county agreed in 2024 to sell C5, LLC 87.5 acres on Roxbury Road for a data center. County staff reported in August 2026 that a mass grading plan for C5 is under review. A filing date for data center buildings is still open.
Coverage and method
Boundary: the Richmond metro area in the region's 2024 demographic fact sheet: Amelia, Charles City, Chesterfield, Dinwiddie, Goochland, Hanover, Henrico, King and Queen, King William, New Kent, Powhatan, Prince George and Sussex counties, and Colonial Heights, Hopewell, Petersburg and Richmond cities.
| Authority | Records reviewed | Coverage |
|---|---|---|
| Hanover County | Planning cases, commercial building permits and Board records | Complete for all seven quarters. |
| Town of Ashland | Monthly planning reports, agendas, minutes and permits | Complete in five of seven quarters. |
| Chesterfield County | Building and planning records by date, case map, Board and BZA records | Complete except Q3 2026, where 13 new applications show no name yet. |
| Henrico County | Build Henrico by date, plan agendas, Board and BZA records | Complete for all seven quarters. |
| Goochland County | Permit register, Board and commission minutes, project pages | Complete in four of seven quarters. |
| Dinwiddie County | Commission, Board and BZA records, project page | Complete for all seven quarters. |
| Town of McKenney | Joint meeting minutes and county records | The town publishes no planning records online. |
| Powhatan County | Board and commission packets and minutes, case list | Complete in five of seven quarters. |
| Charles City County | Board, commission, BZA and EDA records and packets | Site plan logs are not published. |
| New Kent County | Board and commission minutes and packets | Complete in five of seven quarters. |
| City of Petersburg | Commission and BZA packets, Council records, project map | Site plan filing dates are not public. |
| City of Richmond | Council, commission, plan and building records | No data center application found. |
| Prince George County | Monthly planning reports, commission and Board records | No data center application found. |
| City of Colonial Heights | Council, commission and BZA records, permit lists | No data center application found. |
| City of Hopewell | Council, commission and EDA records | Site plans are not published. |
| Amelia County | Board, commission and EDA records | No data center application found. |
| King and Queen County | Board, commission, EDA and BZA records | No data center application found. By-right site plans are not published. |
| King William County | Board, commission and BZA records, permit portal | No data center application found. |
| Town of West Point | Council, commission and BZA agendas and minutes | No data center application found. |
| Sussex County | Board and commission agendas, packets and minutes | Project 460 filed August 2025 and approved. |
| Towns of Waverly, Wakefield, Jarratt and Stony Creek | Town council agendas and minutes where posted | No data center application found. |
| Virginia DEQ and U.S. Army Corps | Air and wetland permits, federal notices | A separate series. |
Full: every relevant record for the quarter was read. Partial: some records are not published, so the quarter may be missing a filing or a decision.
| Authority | Q1 2025 | Q2 2025 | Q3 2025 | Q4 2025 | Q1 2026 | Q2 2026 | Q3 2026 |
|---|---|---|---|---|---|---|---|
| Hanover | Full | Full | Full | Full | Full | Full | Full |
| Town of Ashland | Full | Full | Full | Full | Partial | Full | Partial |
| Chesterfield | Full | Full | Full | Full | Full | Full | Partial |
| Henrico | Full | Full | Full | Full | Full | Full | Full |
| Goochland | Full | Full | Full | Full | Partial | Partial | Partial |
| Dinwiddie | Full | Full | Full | Full | Full | Full | Full |
| Town of McKenney | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Powhatan | Full | Full | Full | Full | Partial | Full | Partial |
| Charles City | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| New Kent | Full | Full | Full | Full | Full | Partial | Partial |
| Petersburg | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| City of Richmond | Full | Full | Full | Full | Full | Full | Full |
| Prince George | Full | Full | Full | Full | Full | Full | Full |
| Colonial Heights | Partial | Full | Full | Full | Full | Full | Partial |
| Hopewell | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Amelia | Full | Full | Full | Full | Full | Full | Partial |
| King and Queen | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| King William | Full | Full | Full | Full | Full | Full | Full |
| Town of West Point | Full | Partial | Partial | Full | Full | Full | Partial |
| Sussex | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
| Sussex towns | Partial | Partial | Partial | Partial | Partial | Partial | Partial |
A site is one address or one campus, listed in the quarter its record shows a filing to add data center buildings: a rezoning, use permit or site plan for a new site, or a site plan or building permit for a new building. Fit-outs at existing buildings are listed with their project and the power they state.
This interim edition is not a Richmond-area census. A filing does not establish construction, power or space to lease.
Sources and revisions
Every figure links to the public record it came from: a site plan, a building permit, a zoning case, a county meeting record, a state permit or a federal notice. News coverage is named as news and never stands in for a record. This edition is final. Its figures change only by a dated correction. A correction will name the record it changes.
Colocation Scout is run by a wholesale and colocation consultant. The permit data is public and every row links to its filing. How we publish these reports.
Revisions: none yet. Edition status: final.
Cite this report as: Colocation Scout, "Richmond data center filings, Q3 2026," colocationscout.com/reports/richmond-data-center-permits-q3-2026.html
