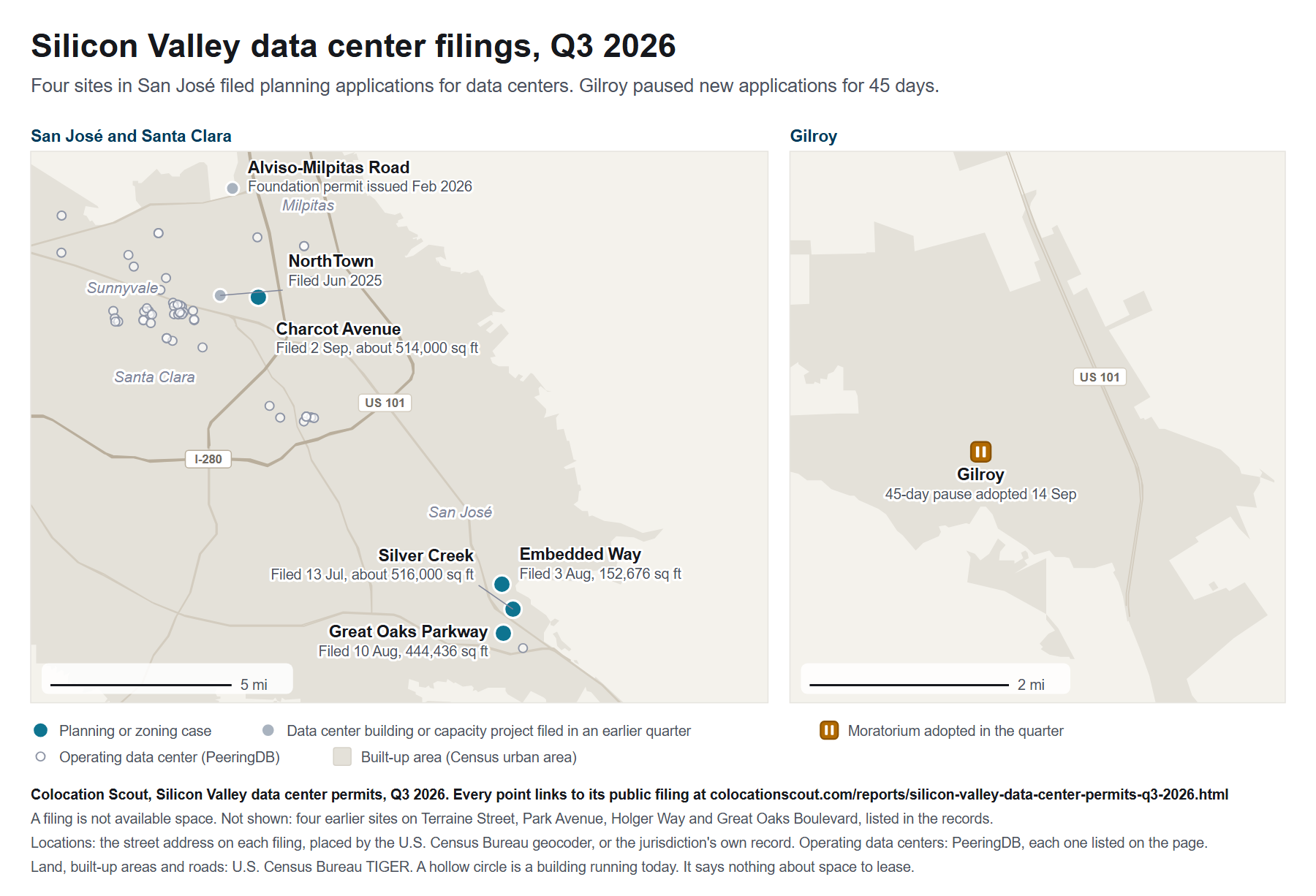

0
new data center building permits in the San José records this quarter. Recent filings may not have posted yet, and these records do not hold every permit.
4
sites filed planning applications to build data centers in San José, from 152,676 to about 516,000 square feet. All four are still under city review.
1
city paused new data center applications: Gilroy, by a 7-0 vote on 14 September, for 45 days unless extended, with its approved Amazon campus exempt.
San José took four data center planning applications in Q3 but no new building permits, while Gilroy paused new applications and Santa Clara authorized up to $350 million for its city-owned grid.
Operating facilities on the map (51)
The small hollow grey dots are data centers listed in the public PeeringDB facility list, each linked to its record. Listings marked closed are left off. A listed building is in no count on this page.
| Operator | Facility | City | Record |
|---|---|---|---|
| BAIS, INC | Bay Area Internet | Santa Clara | peeringdb.com/fac/1513 |
| Centersquare | Centersquare Silicon Valley (SFO1) | Santa Clara | peeringdb.com/fac/2643 |
| Centersquare | Centersquare Silicon Valley (SFO2) | Santa Clara | peeringdb.com/fac/2645 |
| Centersquare | Centersquare Silicon Valley (SFO3) | Sunnyvale | peeringdb.com/fac/2653 |
| Centersquare | Centersquare Silicon Valley (SFO4-A) | Santa Clara | peeringdb.com/fac/7836 |
| ColoCrossing | ColoCrossing SJ1 | San Jose | peeringdb.com/fac/6422 |
| Cologix, Inc. | Cologix SV1 | Santa Clara | peeringdb.com/fac/11633 |
| CoreSite | Coresite - Milpitas (SV2) | Milpitas | peeringdb.com/fac/671 |
| CoreSite | CoreSite - San Jose (SV1) | San Jose | peeringdb.com/fac/20 |
| CoreSite | CoreSite - Santa Clara (SV3) | Santa Clara | peeringdb.com/fac/2762 |
| CoreSite | CoreSite - Santa Clara (SV4) | Santa Clara | peeringdb.com/fac/1619 |
| CoreSite | CoreSite - Santa Clara (SV7) | Santa Clara | peeringdb.com/fac/3344 |
| CoreSite | CoreSite - Santa Clara (SV8) | Santa Clara | peeringdb.com/fac/8867 |
| CoreSite | CoreSite - Santa Clara (SV9) | Santa Clara | peeringdb.com/fac/15079 |
| DataBank, Ltd. | DataBank Santa Clara (SFO1) | Santa Clara | peeringdb.com/fac/10931 |
| DataPipe, Inc. | DataPipe Silicon Valley One | San Jose | peeringdb.com/fac/2973 |
| Digital Realty | Digital Realty SJC (1100 Space Park) | Santa Clara | peeringdb.com/fac/3131 |
| Digital Realty | Digital Realty SJC (1201 Comstock St) | Santa Clara | peeringdb.com/fac/4682 |
| Digital Realty | Digital Realty SJC (1500 Space Park Dr) | Santa Clara | peeringdb.com/fac/4681 |
| Digital Realty | Digital Realty SJC (1525 Comstock St) | Santa Clara | peeringdb.com/fac/4680 |
| Digital Realty | Digital Realty SJC (1725 Comstock St) | Santa Clara | peeringdb.com/fac/4679 |
| Digital Realty | Digital Realty SJC (2220 De La Cruz Blvd) | Santa Clara | peeringdb.com/fac/1101 |
| Digital Realty | Digital Realty SJC (2805 Lafayette) | Santa Clara | peeringdb.com/fac/2542 |
| Digital Realty | Digital Realty SJC (2820 NW Pkwy) | Santa Clara | peeringdb.com/fac/469 |
| Digital Realty | Digital Realty SJC (3011 Lafayette St) | Santa Clara | peeringdb.com/fac/4678 |
| Digital Realty | Digital Realty SJC (3105 Alfred St) | Santa Clara | peeringdb.com/fac/4676 |
| Digital Realty | Digital Realty SJC (3205 Alfred St) | Santa Clara | peeringdb.com/fac/4675 |
| EdgeConneX Inc. | EdgeConneX Santa Clara (EDCSVC01/EDCSVC02) | Santa Clara | peeringdb.com/fac/2427 |
| EdgeCore Digital Infrastructure | EdgeCore Silicon Valley | Santa Clara | peeringdb.com/fac/13478 |
| Energy Group Networks LLC | OpenColo | Santa Clara | peeringdb.com/fac/10674 |
| Equinix, Inc. | Equinix SV1/SV5/SV10 - Silicon Valley, San Jose | San Jose | peeringdb.com/fac/6 |
| Equinix, Inc. | Equinix SV17 - Silicon Valley, Santa Clara | Santa Clara | peeringdb.com/fac/85 |
| Equinix, Inc. | Equinix SV2 - Silicon Valley, Santa Clara | Santa Clara | peeringdb.com/fac/437 |
| Equinix, Inc. | Equinix SV3 - Silicon Valley, San Jose | San Jose | peeringdb.com/fac/436 |
| Equinix, Inc. | Equinix SV4 - Silicon Valley, Sunnyvale | Sunnyvale | peeringdb.com/fac/574 |
| Equinix, Inc. | Equinix SV6 - Silicon Valley, Sunnyvale | Sunnyvale | peeringdb.com/fac/510 |
| H5 Data Centers | H5 Data Centers Silicon Valley | Sunnyvale | peeringdb.com/fac/2873 |
| Hurricane Electric | Hurricane Electric San Jose 1 | San Jose | peeringdb.com/fac/16184 |
| KDWEB | KDWEB San Jose | San Jose | peeringdb.com/fac/84 |
| Lumen Technologies Inc | Level(3) Sunnyvale | Sunnyvale | peeringdb.com/fac/176 |
| NaviSite LLC | Navisite Santa Clara | Santa Clara | peeringdb.com/fac/10830 |
| Opus Interactive, Inc. | Opus Interactive Silicon Valley (SJC01) | San Jose | peeringdb.com/fac/3864 |
| QTS Realty Trust, Inc. | QTS Santa Clara (SJC1/SJC2) | Santa Clara | peeringdb.com/fac/578 |
| Serverfarm | ServerFarm SC1 | Santa Clara | peeringdb.com/fac/5439 |
| Stack Infrastructure | Stack Infrastructure Silicon Valley SVY01 | San Jose | peeringdb.com/fac/6095 |
| SVTIX San Jose | SVTIX San Jose | San Jose | peeringdb.com/fac/33 |
| TelePacific Communications | 190 Park Center Plaza San Jose | San Jose | peeringdb.com/fac/414 |
| Vantage Data Centers | Vantage Data Centers (Santa Clara) | Santa Clara | peeringdb.com/fac/1102 |
| VPLS | Evocative San Jose (SV7) | San Jose | peeringdb.com/fac/147 |
| VPLS | Evocative SJC11 | Santa Clara | peeringdb.com/fac/1842 |
| VPLS | Evocative SJC3 | Santa Clara | peeringdb.com/fac/293 |
What happened this quarter
Four data center plans, no new building permits
No new data center building permit was filed in the San José records this quarter, although recent filings may not have reached the city's public system yet and the map layers behind these records do not hold every permit. Four sites filed planning applications to build data centers instead, and all four are still under city review. Silver Creek, at about 516,000 square feet, and a three-story building on Charcot Avenue that would replace five others, at about 514,000, are the largest, followed by a 444,436 square foot plan on Great Oaks Parkway and 152,676 square feet on Embedded Way. A downtown rezoning at 150 South First Street to reinstate and expand a data center is also on file. Its record states no power figure.
Power figures that do not add up
Three of the four applications state power, each in a different way, so none of their figures can be added to another. The city's record describes the Embedded Way plan as an 18 megawatt data center and the Great Oaks plan as a 72 megawatt one, without saying whether that is the load of the computers or the demand of the whole site. Silver Creek's record gives up to 99 MW of backup generation from 44 generators, the plant Prologis put before the California Energy Commission on 18 September when it applied for a small power plant exemption. A generator rating measures backup plant, not capacity a customer can use.
Older projects move through review and construction
NorthTown, a 206,250 square foot data center proposed on West Trimble Road in June 2025, went deeper into state review. The Energy Commission opened scoping for a draft environmental impact report on 21 July, and on 6 October, after the quarter closed, it asked for alternative sites and a smaller backup plant, once San José had asked that the review cover the whole data center and its full build-out. On Alviso-Milpitas Road, a 245,000 square foot data center has held a foundation permit since February and is under inspection. Valley Water agreed on 14 July to move a visitor center and change parking for it, but the full building permit still waits on approval of public improvements.
Gilroy pauses applications as Santa Clara funds its grid
Gilroy council voted 7-0 on 14 September to stop accepting, processing or approving new data center applications for 45 days while the city writes rules for them, and its own 10-day report says the pause ends on 29 October unless the council extends it. The Amazon campus at 8050 Camino Arroyo, approved and under construction, is exempt, but a second Amazon facility, so far only a pre-application, is not. Santa Clara's council authorized up to $350 million in revolving credit for its city-owned electric utility on 7 July, which pays for the system without assigning power to any site, and in August agreed to schedule a debate on data center water use.
The quarter's filings
| Site | Square feet | Megawatts, as the record words them | Estimated cost, as filed |
|---|---|---|---|
| Silver Creek5977 Silver Creek Valley Road, San José. 1 building | 516,000 | Up to 99 MW backup generation | TBA |
| 326 Charcot AvenueSan José. 1 building | 514,000 | TBA | TBA |
| 5601 Great Oaks ParkwaySan José. 1 building | 444,436 | 72 MW data center | TBA |
| 865 Embedded WaySan José. 1 building | 152,676 | 18 MW data center | TBA |
| Total, 4 sites and 4 buildings | 1,627,112 | Not totalled | TBA |
All four are planning applications, not building permits. Square feet are the data center area each record describes, about 516,000 and 514,000 as Silver Creek's and Charcot Avenue's records round them, and leave out Silver Creek's 30,000 square feet of office. The megawatts are not totalled because they measure different things: Silver Creek's is backup generation and the other two do not say what they measure. TBA marks a figure the record does not state yet. Estimated cost, as filed, is the filers' own unverified figure, not total project spend, and no planning application here states one.
Completed 13 October 2026. These figures are frozen, and any later correction is listed under Sources and revisions. Recent San José filings may not have reached the city's public system yet. A filing is not space anyone can lease.
Sites filing to add data center capacity, by quarter
A site counts once in a quarter however many permits it files. The chart draws on San José building permits and planning cases naming a data center, found through the city's map layers of recent and active permits and its data center register. Those layers do not hold every past permit. Other cities and both counties are outside this report's coverage.
Earlier quarters, not comparable with Q3 2026
Sources were added or changed during these quarters, so these counts cannot be compared with each other or with Q3 2026. They show what the records hold, not a trend.
| Quarter | San José: sites filing to add capacity |
|---|---|
| Q2 2026 | 0 |
| Q1 2026 | 0 |
| Q4 2025 | 2 |
| Q3 2025 | 2 |
| Q2 2025 | 2 |
| Q1 2025 | 0 |
What to watch
- 19 October 2026: Gilroy's council holds a hearing on extending the moratorium by 10 months and 15 days, to 3 September 2027. An extension needs a four-fifths vote.
- 29 October 2026: the moratorium expires unless it is extended, according to the city's 10-day report.
- 5 November 2026: NorthTown's answers are requested by then, 30 days after the Energy Commission asked on 6 October for alternative sites and a smaller backup plant.
The records
The quarter's filings, in detail (4)
Silver Creek
- Location
- 5977 Silver Creek Valley Road, San José, on about 15.13 gross acres
- Applicant
- Prologis, L.P., in its filing with the California Energy Commission (application). The city record does not name the applicant.
- Size
- About 516,000 square feet of data center and about 30,000 square feet of office
- Power
- 44 generators with up to 99 MW of backup generation, and an electrical substation
- Work, as filed
- "construction of a three-story, approximately 111-foot-high, approximately 516,000-square-foot data center with approximately 30,000 square feet of accessory office space"
- Filing and status
- Special use permit application, under review. A planning application is not a building permit.
- Filed
- 13 July 2026
- Record
- SP26-016
326 Charcot Avenue
- Location
- 326 Charcot Avenue, San José
- Size
- About 514,000 square feet
- Work, as filed
- "demolition of five existing buildings and the construction of an approximately 514,000-square-foot, three-story data center building"
- Filing and status
- Special use permit application, under review. A planning application is not a building permit.
- Filed
- 2 September 2026
- Record
- SP26-026
5601 Great Oaks Parkway
- Location
- 5601 Great Oaks Parkway, San José, on about 15.12 gross acres
- Size
- 444,436 square feet
- Power
- "72-megawatt data center", as the record words it, with an on-site substation and 44 backup generators
- Work, as filed
- "construction of a two-story 444,436-square-foot, 72-megawatt data center with an on-site substation (0.88 acres), 44 backup generators, 42 chillers, and publicly accessible public open space"
- Filing and status
- Planned development permit application, under review. The city's data center register lists the case as SP26-022, and its permit system files the same folder as PD26-007.
- Filed
- 10 August 2026
- Record
- PD26-007
865 Embedded Way
- Location
- 865 Embedded Way, San José, on about 10.1 gross acres of vacant land
- Size
- 152,676 square feet
- Power
- "18 megawatt data center", as the record words it
- Work, as filed
- "construction of a two-story 152,676-square-foot 18 megawatt data center on an approximately 10.1-gross-acre vacant property"
- Filing and status
- Special use permit application, under review. A planning application is not a building permit.
- Filed
- 3 August 2026
- Record
- SP26-020
Every project in the record, Q1 2025 to Q3 2026 (13)
| First filed | Permit first issued | Where | The work | Type | Declared value | Record |
|---|---|---|---|---|---|---|
| 9 April 2025 | No decision yet | 323 Terraine St, San José | About 240,000 square foot data center beside a residential tower | Planning case, one of two options | Not stated | PD25-011 |
| 30 June 2025 | No decision yet | 350 W Trimble Rd, San José | About 206,250 square foot data center with 21 generators | Planning case | Not stated | CP25-013 |
| 28 July 2025 | Q3 2025 1 August 2025 | 5 Great Oaks Blvd, San José | Chillers, a powerhouse and a generator at an existing data center | Existing data center work | Not stated | 2025-121736-CI |
| 12 August 2025 | No decision yet | 180 Park Ave, San José | About 457,125 square foot, 11-story data center beside a residential tower | Planning case, one of two options | Not stated | PD25-015 |
| 8 September 2025 | Q4 2025 3 October 2025 | 127 Great Oaks Blvd, San José | Four data halls with eight 3.35 MW backup generators | Data hall fit-out | Not stated | 2025-128807-CI |
| 19 November 2025 | No decision yet | 300 Holger Way, San José | Data center use in a 97,800 square foot research building | Planning case, change of use | Not stated | SP25-029 |
| 15 December 2025 | Q1 2026 5 January 2026 | 1657 Alviso-Milpitas Rd, San José | 245,000 square foot data center, foundation first, and a substation | New building | Not stated | 2025-145276-CI, 2025-145629-CI |
| 30 January 2026 | Q1 2026 3 February 2026 | 5 Great Oaks Blvd, San José | Fuel cell tower for an existing data center campus | Existing data center work | Not stated | 2026-101243-CI |
| 13 July 2026 | No decision yet | 5977 Silver Creek Valley Rd, San José | About 516,000 square foot data center with 44 generators | Planning case | Not stated | SP26-016 |
| 3 August 2026 | No decision yet | 865 Embedded Way, San José | 152,676 square foot, 18 MW data center | Planning case | Not stated | SP26-020 |
| 10 August 2026 | No decision yet | 5601 Great Oaks Pkwy, San José | 444,436 square foot, 72 MW data center with a substation | Planning case | Not stated | PD26-007 |
| 2 September 2026 | No decision yet | 326 Charcot Ave, San José | About 514,000 square foot data center replacing five buildings | Planning case | Not stated | SP26-026 |
| 10 September 2026 | None on record | 150 S 1st St, San José | Rezoning to reinstate and expand a data center, as the city register describes it | Existing data center work | Not stated | PDC26-016 |
Existing data center work: the record states no power figure.
State reviews of data center backup power (3)
| Date | Proceeding | What happened | Backup plant | Docket |
|---|---|---|---|---|
| 21 July 2026 | NorthTown Backup Generating Facility | Scoping opened for a draft environmental impact report | 42 generators, up to 97.3 MW | 25-SPPE-02 |
| 18 September 2026 | Silver Creek Backup Generating Facility | Prologis applied for an exemption | 44 generators, up to 99 MW | 26-SPPE-02 |
| 6 October 2026 | NorthTown Backup Generating Facility | Asked for alternative sites and a smaller plant | 42 generators, up to 97.3 MW | 25-SPPE-02 |
California Energy Commission proceedings on data center generators, 2 in Q3 2026 and 1 after it. A generator rating is backup plant, not capacity.
Government actions, 2025 to 2026 (9)
- Santa Clara council: A data center customer's 24 MVA power schedule moved from 2032 to 2027 (action history).
- Santa Clara council: Ordinance 2078 amended a data center development agreement (action history).
- Santa Clara council: Faster power ramps allowed for large customers, subject to grid limits (action history).
- San Benito County supervisors: Agreed to bring back a possible data center ordinance (minutes).
- San José rules committee: Uniform data center standards recommended, not yet adopted (city register).
- Santa Clara council: Up to $350 million in revolving credit for the electric utility (resolution).
- Valley Water: Agreement to move a visitor center for the Alviso-Milpitas data center (state notice).
- Santa Clara council: Agreed to schedule a debate on data center water use. No rule adopted (action history).
- Gilroy council: Ordinance 2026-08, a 45-day pause on new data center applications, 7-0 (minutes, 10-day report).
Reported (15)
Projects named in public lists, city directories or undated records. None of these is in the counts above.
- Amazon's second Gilroy facility, near Highway 152 and Camino Arroyo, Gilroy. A pre-application for a second data center (draft extension ordinance). No formal application, and the moratorium covers one.
- AWS Data Center, 8050 Camino Arroyo, Gilroy. Approved and under construction, up to 98 MW of electrical demand for two buildings, the city says (city announcement, draft extension ordinance). Applied for before 2025, so outside the counts.
- 1321 Comstock Street, Santa Clara. A new four-story data center of about 112,000 square feet (permit). Its search date is not confirmed as a filing date.
- GI Partners, 2805 Bowers Avenue, Santa Clara. Listed as approved in the city's project directory (city directory). No decision date or building status on record.
- Meadow Point, Disk Drive, San José. Described by residents as a Google data center (city register). The city lists the use as research and development.
- Prologis Zanker Road, Buildings 1 to 4, San José. Listed as planned. No city filing found.
- Goodman San Jose Data Center, San José. Listed as planned. Any link to NorthTown is unconfirmed.
- Terra Data Center, Santa Clara County. Listed as planned. No city or filing on record.
- SJDC 04 and SJC Campus, San José. Listed as planned. No city filing found.
- LBA Realty San Jose data centers, San José. Listed as planned. No city filing found.
- Equinix SV12, San José. Listed as planned. No filing names it.
- Stack SVY02A, Santa Clara County. Listed as planned. No city or filing on record.
- AWS Mission College, Building 2, Santa Clara. Listed as planned. No Santa Clara filing found.
- Prime Data Centers, 1231 Comstock and SJC03, Santa Clara and San José. Listed as planned. No filing found, and 1231 may be the 1321 Comstock permit.
- Menlo Digital, Sunnyvale. Listed as planned. Sunnyvale permits are not collected.
Coverage and method
Boundary. The San Jose-Sunnyvale-Santa Clara metropolitan area as the Office of Management and Budget defined it in July 2023: Santa Clara and San Benito counties. San Mateo and Alameda counties are outside it.
| Authority | Records | Status, Q1 2025 to Q3 2026 |
|---|---|---|
| City of San José | Permits and planning cases naming a data center | Collected, from map layers of recent and active permits |
| City of Santa Clara | Council actions and a building permit search | Actions reviewed. Permits not listed |
| City of Gilroy | Council minutes and staff reports | Reviewed. Permits not collected |
| San Benito County | Board and planning commission minutes | Partly reviewed. Permits not collected |
| Santa Clara County and the other 14 cities | Permits, planning cases and meetings | Not collected or not reached |
| California Energy Commission | Backup power proceedings | Listed below |
What is in this report. A new data center building, a planning case for a new data center site, and work at an existing data center that states added power with a figure. Each filing's own record names a data center. Repairs, replacements and equipment with no power figure are left out, or noted where they sit at a data center.
Sites. A site is one address or one campus and appears once in a quarter. A planning case is an application, not a permit. Quarters do not compare, because the city's map layers hold recent and active permits, not every past one.
Sources and revisions
Every figure links to the public record it came from: a City of San José permit or planning case, a California Energy Commission filing, or the minutes, resolution or report of the body that acted. Public project lists were used to find leads and are never cited.
Colocation Scout is run by a wholesale and colocation consultant. The permit data is public and every row links to its filing. How we publish these reports.
Revisions: on 13 October 2026 the edition was finalized and the headline changed. No figures changed. Edition status: final.
Cite this report as: Colocation Scout, "Silicon Valley data center permits, Q3 2026," colocationscout.com/reports/silicon-valley-data-center-permits-q3-2026.html
